How to Get an Industrial License in the US (2026 Guide) Search "industrial license USA" and most results promise one form, one fee, one agency. That's not how US manufacturing regulation actually works.

In reality, "industrial license" is shorthand for a stack of federal, state, county, and city approvals that vary by what you make, how you make it, and where your facility sits. A food processor in Ohio faces a different approval path than a metal fabricator in Texas or an electronics assembler in Washington.

This guide walks through how to identify the right approvals, prepare your business and facility, apply in the correct sequence, and avoid the delays that trip up most new manufacturers in 2026.

Key Takeaways

  • No single US industrial license exists; requirements depend on product, process, site, and jurisdiction.
  • Forming an LLC or corporation and getting an EIN doesn't authorize you to run a facility.
  • Confirm zoning and environmental feasibility before signing a lease or ordering equipment.
  • Federal, state, and local agencies run separate approval tracks you must track individually.
  • Always verify fees, forms, and renewal cycles against current official agency sources.

How to Get an Industrial License in the US: Step-by-Step Process

Step 1: Define the Industrial Activity and Regulatory Profile

Before touching an application, document exactly what your business will do. This profile determines which regulators even apply to you.

Capture the following:

  • Products and processes — what you manufacture, process, store, import, or distribute
  • Inputs — raw materials, chemicals, and machinery involved
  • Outputs — waste streams, emissions, and water discharge
  • Scale — employee count, storage needs, and planned sales channels

Identify your NAICS code (manufacturing sits in sectors 31-33 under the Census Bureau's classification system). Then check whether your activity triggers a federal regulator such as the FDA, USDA, ATF, FAA, FCC, CPSC, or US Fish and Wildlife Service. Don't assume a generic search result applies to your exact product; verify directly with the agency.

Step 2: Form the Business and Establish Tax Registrations

Entity formation is necessary, but it's not permission to produce anything. In the US, this typically means:

  • Filing Articles of Organization or Incorporation with your chosen state's Secretary of State (LLC, C-Corp, S-Corp, or branch registration)
  • Appointing a registered agent in that state
  • Adopting an operating agreement or bylaws
  • Obtaining an EIN from the IRS
  • Registering for state tax IDs, sales and use tax, and payroll accounts (W-4, W-2, 941, 1099-NEC)
  • Filing beneficial ownership information (BOI) with FinCEN

An EIN is a nine-digit federal tax identifier, nothing more. It doesn't substitute for zoning clearance, environmental permits, or sector-specific operating authorization.

This is where VJM Global supports international founders: entity formation, registered agent setup, EIN applications, and payroll registration, so the paperwork foundation is solid before facility approvals begin.

Step 3: Confirm Site, Zoning, and Construction Feasibility

Contact your city or county planning department before signing a lease or purchase agreement. Confirm the intended industrial use is permitted at that address.

Depending on the jurisdiction, you may need:

  • Building, site-plan, and construction permits
  • Electrical, plumbing, and accessibility approvals
  • Certificate of occupancy
  • Fire-code review and signage approval
  • Utility connection sign-off

Changing a building's use, installing production equipment, storing hazardous materials, or expanding capacity can all trigger additional review — even if you already hold a general business license.

Step 4: Apply for Environmental, Safety, and Operating Permits

This is usually the longest and most technical phase. Depending on your process, you may need coverage for air emissions, wastewater or stormwater discharge, hazardous waste, chemical storage, solid waste, noise, or fuel tanks.

A critical detail many founders miss: EPA's New Source Review program applies before construction or modification of a qualifying stationary emissions source, not after you've already built. Ordering and installing equipment before assessing air permit triggers is one of the most expensive sequencing mistakes in industrial permitting.

Alongside environmental approvals, prepare for:

  • OSHA workplace safety readiness, including hazard communication and machine guarding
  • Fire prevention and emergency planning
  • Employee training documentation

Most applications require:

  • Legal entity information and facility address
  • Process descriptions and site plans
  • Equipment specifications and engineering reports
  • Safety plans, plus insurance or financial documents when requested

Step 5: Submit, Inspect, Receive Approval, and Track Renewals

Submit applications to each responsible agency, pay the applicable fees, and respond promptly to information requests. Some approvals require public notice periods or scheduled inspections before issuance.

Don't start production until every condition-of-operation approval has actually been issued. A pending application is not a permit.

Once approved, maintain a permit register tracking:

  • Approval numbers and expiration dates
  • Reporting obligations and inspection records
  • Responsible employees for each obligation
  • Triggers that would require amended approvals (new equipment, added chemicals, relocation)

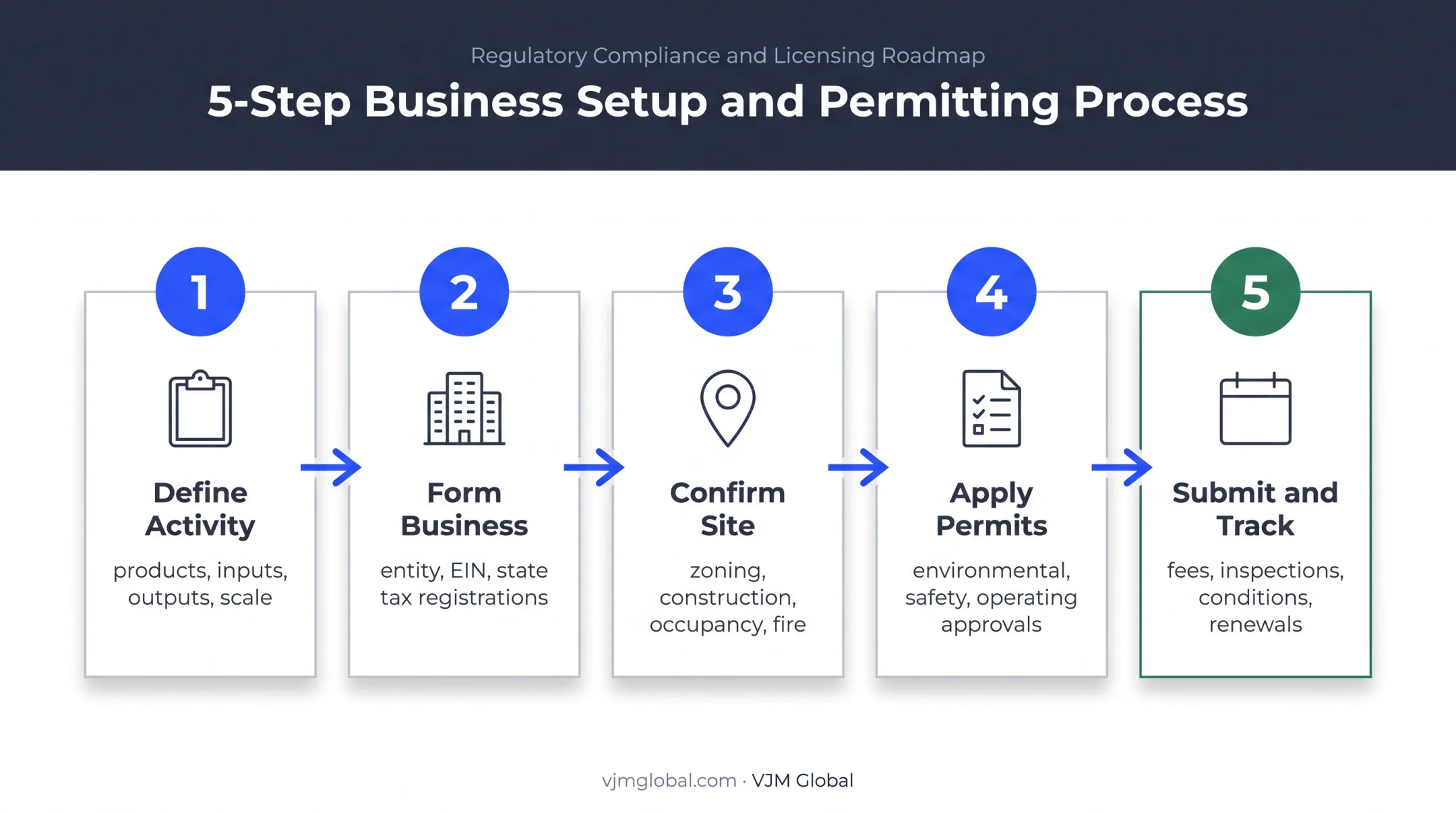

Five-step US industrial permitting process from activity definition to renewals

What You Need Before Applying for an Industrial License

Preparation directly affects approval speed. Skipping it is how businesses end up investing in a facility that legally can't operate.

Business and Ownership Information

Gather these details before you apply:

  • Legal entity name and formation documents
  • EIN and ownership structure
  • Registered agent details and business address
  • Foreign ownership disclosures (where relevant)
  • Responsible-official contact information

Facility, Process, and Technical Information

Agencies typically want:

  • Site details, zoning classification, and floor plans
  • Production flow, machinery lists, and utility demand
  • Raw materials, finished products, and storage arrangements
  • Emissions data, wastewater routing, and waste disposal methods
  • Transportation access and operating hours

Research early whether engineering drawings, environmental assessments, safety data sheets, or professional certifications apply to your specific application.

Compliance and Inspection Readiness

Hold pre-application conversations with planning, building, fire, environmental, and occupational safety regulators to confirm the correct approval order. You'll also need written procedures covering:

  • Worker safety and emergency response
  • Hazardous-material handling
  • Equipment maintenance and recordkeeping
  • Incident reporting and required testing or monitoring

Financial and Operational Planning

Budget for costs specific to your jurisdiction—generic nationwide figures aren't reliable:

  • Application fees and inspection charges
  • Consultant and construction costs
  • Insurance requirements
  • Recurring reporting expenses

Build a realistic timeline that accounts for agency review periods, construction, inspections, and possible requests for revised documents.

Which Industrial Licenses and Permits Might You Need?

Treat the categories below as a screening framework, not a checklist to complete in full. The exact combination depends entirely on your product, process, site, and state.

Federal or Sector-Specific Approvals

Agency Trigger
FDA Food, drug, or medical-device facility registration
USDA FSIS Meat, poultry, or egg-product grant of inspection
ATF Explosives licensing
FAA Production certificate for aircraft, engines, or propellers
FCC Equipment authorization for RF devices
CPSC Children's product certification
US Fish & Wildlife Service Import/export of protected wildlife or products

State Business, Tax, and Professional Registrations

  • State entity registration or foreign qualification
  • State tax registration and sales/use tax permits
  • Unemployment and workers' compensation registration
  • Professional or occupational licenses where applicable

Verify whether your state issues a general business license, a manufacturer registration, or a sector-specific environmental authorization. This varies significantly between states.

Local Zoning, Building, Fire, and Occupancy Approvals

Possible requirements include:

  • Zoning clearance or conditional-use approval
  • Site-plan approval
  • Building and construction permits
  • Certificate of occupancy
  • Fire inspection and hazardous-material storage approval
  • Signage approval and local business registration

Environmental and Workplace-Related Permits

Air, water, and waste pathways are each assessed separately, not as one bundle:

  • Air: New Source Review (preconstruction) and Title V operating permits for major sources
  • Water (direct discharge): NPDES authorization
  • Water (municipal sewer): Assessed under separate pretreatment rules
  • Stormwater: Covered facilities may need industrial stormwater permit coverage
  • Waste: Hazardous waste generator ID requirements scale with generator size
  • Chemical reporting: EPCRA Sections 311/312 require hazardous-chemical inventory reports to state and local emergency planning bodies

OSHA's hazard communication and machine-guarding standards apply regardless of whether a separate "safety license" exists in your state.

Import, Export, Transportation, and Product-Compliance Registrations

If your business imports inputs or exports finished goods, expect to handle:

  • Customs importer requirements, including CBP Form 5106
  • Export licensing through the Bureau of Industry and Security where applicable
  • Product labeling rules
  • Hazardous-materials transportation registration through PHMSA

None of these replace your manufacturing or operating approvals. An import permit authorizes importing, not production.

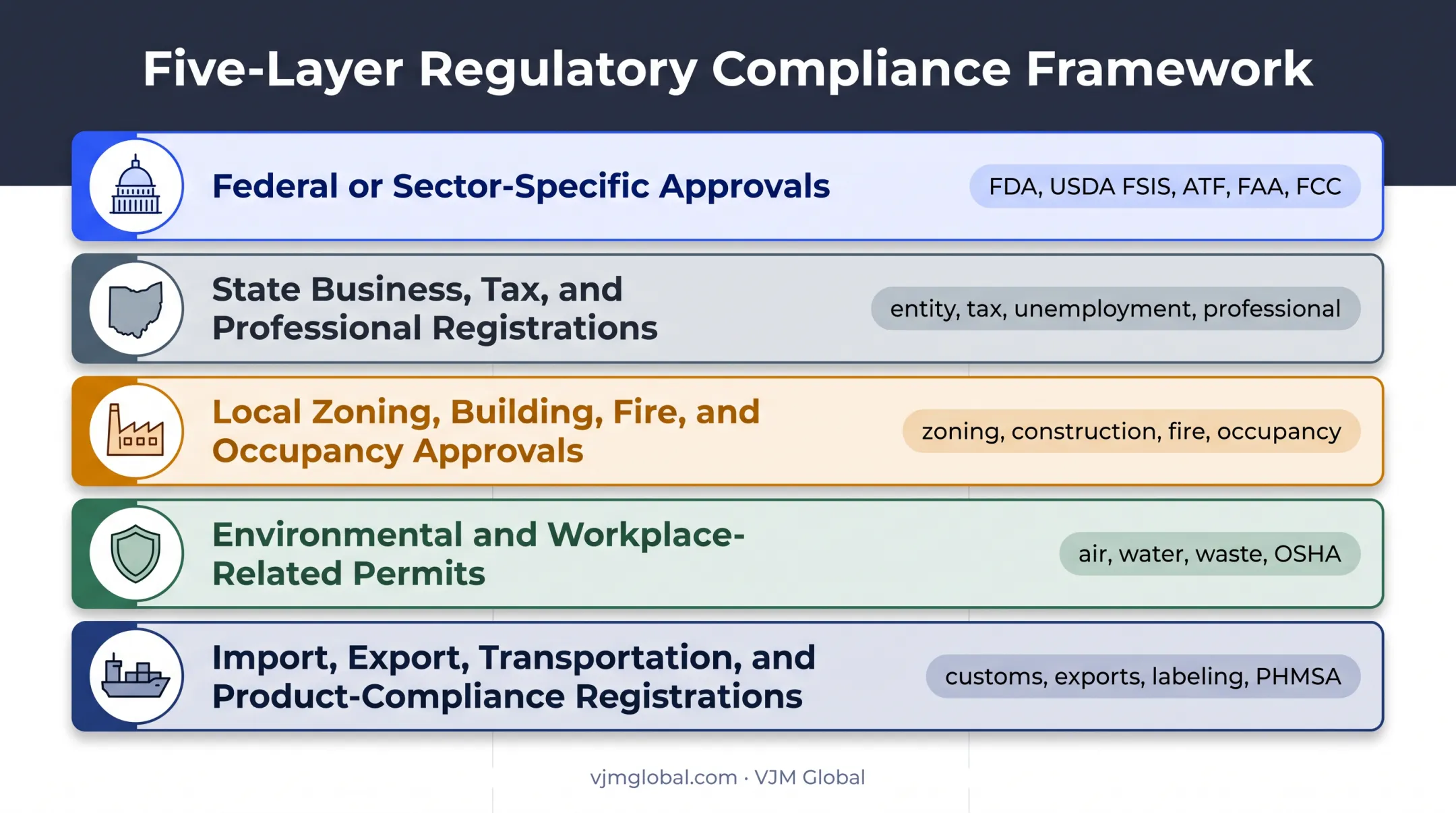

Five-category US manufacturing approval and permit framework

Common Mistakes and Troubleshooting When Getting an Industrial License

Most permitting problems trace back to incomplete regulatory scoping, inconsistent paperwork, or starting site work before approvals are confirmed.

Skipping Zoning or Pre-Application Review

Leasing or buying a facility before confirming permitted use, utility capacity, environmental constraints, and fire access often forces costly redesigns, or blocks approval entirely. Always check with planning first.

Incomplete, Inconsistent, or Technically Weak Applications

Common red flags include:

  • Mismatched legal names across documents
  • Incorrect addresses or missing ownership details
  • Thin process descriptions and absent site plans
  • Unsupported emissions estimates
  • Unanswered agency follow-up questions

Each of these resets your review clock.

Beginning Operations or Changing the Process Without Updating Approvals

New equipment, higher production volumes, added chemicals, altered waste streams, ownership changes, or relocation can all require amended permits or fresh inspections.

Operating without required coverage carries real consequences. EPA's FY2025 civil enforcement results describe a Nevada sand-and-gravel operation penalized $310,000 for unpermitted wastewater and stormwater discharges. That's a case-specific outcome, not a standard fine, but it illustrates the exposure.

EPA enforcement example showing $310,000 industrial permit penalty

When issues arise, escalate to the relevant agency, a qualified environmental or safety professional, or local counsel. International companies running US operations often need tax, accounting, and entity-compliance coordination alongside permits. VJM Global supports that broader business-compliance work, without acting as a licensing authority itself.

Conclusion

Getting an industrial license in the US means identifying and satisfying a coordinated set of federal, state, local, environmental, safety, tax, and industry requirements that apply to your specific facility.

The safest sequence stays consistent regardless of industry:

  • Define the activity
  • Form the entity
  • Confirm the site
  • Obtain required permits
  • Pass inspections
  • Track ongoing obligations before production begins

For complex facilities, regulated products, foreign ownership, or multi-state operations, use current official agency guidance plus qualified professional support—not generic online checklists. VJM Global can help with US entity formation, tax registration, and ongoing compliance alongside your permit work.

Frequently Asked Questions

Can I start a business in the US as a non-citizen?

Yes. Non-citizens can own or form many US business entities. Immigration status, work authorization, tax obligations, ownership disclosures, and industry-specific rules still need separate review.

Is there one industrial license that covers all manufacturing businesses in the US?

No. The US uses multiple federal, state, local, environmental, building, safety, tax, and industry-specific approvals rather than a single nationwide industrial license.

What licenses and permits does a manufacturing company usually need?

Most manufacturers need entity and tax registrations, zoning and building approvals, fire clearance, environmental permits, workplace safety compliance, and local business licenses. Product-specific registrations may also apply, depending on your facility and jurisdiction.

Do I need an EIN before applying for an industrial permit?

Many applications require an EIN or similar business identifier. But an EIN is a federal tax ID, not an operating license, and it doesn't replace state, local, or environmental approvals.

Can a foreign company obtain industrial permits in the United States?

Yes, if the company meets entity registration, tax, registered-agent, ownership, immigration, export-control, and industry-specific rules. Foreign formation does not skip any standard US approval process.

What happens if I operate an industrial facility without the required permits?

You risk notices, fines, failed inspections, stop-work or closure orders, and environmental or safety liability. Unpermitted operations can also complicate insurance coverage, financing, and future due diligence.
