Hazardous Waste Permit Requirements in California Explained California hazardous waste permit requirements don't hinge on the simple fact that your business generates hazardous materials. They hinge on what you do with that waste. A warehouse that stores solvents briefly before disposal faces different rules than a facility that treats, recycles, or accepts waste from other businesses.

This guide answers the question most operators actually have: do you need a full DTSC hazardous waste facility permit, a narrower authorization like Permit by Rule, or simply generator-level compliance? We'll walk through hazardous waste identification, generator duties, facility permits, Permit by Rule, public participation requirements, and ongoing compliance obligations.

One caveat before you read further: California's hazardous waste regulations change. Treat this as a starting framework, and verify specifics with current DTSC guidance or qualified environmental counsel before making operational decisions.

Key Takeaways

  • DTSC administers California's hazardous waste program under the Health and Safety Code, Title 22, and federal RCRA.
  • Treating, storing, disposing of, or operating a hazardous waste facility requires specific authorization before operations begin.
  • Permit by Rule and similar pathways are conditional, not automatic exemptions — eligibility and recordkeeping still apply.
  • An EPA ID number or hazardous waste manifest alone does not authorize treatment, storage, or disposal.

What Counts as Hazardous Waste in California—and Who Regulates It

California doesn't rely solely on federal categories. A waste can be regulated because it's listed, exhibits a hazardous characteristic (ignitability, corrosivity, reactivity, or toxicity), or meets California-specific criteria beyond federal RCRA.

DTSC's classification guidance makes clear this is a waste-specific determination, not something you can assume from a product label or trade name.

California's Dual Testing Standards

Federal rules use the Toxicity Characteristic Leaching Procedure (TCLP) to assess toxicity. California adds two more layers:

  • TTLC (Total Threshold Limit Concentration): evaluates total concentration of a substance in the waste
  • STLC (Soluble Threshold Limit Concentration): evaluates what's extracted through California's Waste Extraction Test (WET)

A waste that passes federal TCLP can still trigger California regulation under TTLC or STLC. Don't assume federal clearance means state clearance.

Common Waste Streams (Verify Each One)

  • Spent cleaning solvents and degreasers
  • Paints and thinners (classification depends on characteristics, not just category)
  • Contaminated absorbents and rags
  • Discarded laboratory chemicals and pesticides
  • Batteries and electronic equipment (managed as universal waste)
  • Treated wood waste

Each of these requires its own evaluation. Contaminated absorbents, for instance, are classified based on what contaminated them, not the absorbent material itself.

Who Regulates What

  • DTSC handles facility permitting and statewide enforcement
  • Certified Unified Program Agencies (CUPAs) manage local generator and tiered-permitting duties
  • U.S. EPA sets the federal RCRA baseline that California builds upon
  • Air districts and water boards may have separate jurisdiction depending on emissions or discharges

One approval doesn't replace another. A facility permit from DTSC doesn't eliminate the need for local fire-code or air-district sign-off if your operation triggers those requirements.

A quick note on households: Household hazardous waste collection rules under Health and Safety Code section 25218 are entirely separate from the commercial generator standards in Title 22, Chapter 12. Don't mix the two frameworks.

When Does a California Business Need a Hazardous Waste Permit?

Here's the central distinction: a generator accumulating its own waste under applicable standards is different from a facility that treats, stores, disposes of, or manages waste as an operational activity. Generators get conditional flexibility. Facilities need authorization.

Activities That Commonly Trigger Facility Authorization

  • Long-term storage beyond generator accumulation limits
  • Treatment of hazardous waste, including onsite treatment of your own waste
  • Disposal or incineration
  • Certain recycling operations
  • Waste transfer activities
  • Accepting hazardous waste generated by other businesses

Notably, treating your own waste onsite generally still requires authorization. DTSC is explicit that generating waste doesn't confer the right to treat it.

Generator Accumulation Time Limits

Generator Category Volume Threshold Accumulation Period Without Facility Permit
Small Quantity Generator (SQG) Under 1,000 kg/month nonacute waste Generally 180 days, or 270 days if shipped 200+ miles
Large Quantity Generator (LQG) 1,000 kg/month or more Generally 90 days

These figures come from DTSC's generator summary chart, last updated October 2024. An additional 90-day constraint applies when more than 1 kg/month of acutely or extremely hazardous waste is involved. Quantity alone doesn't determine whether you need a facility permit. Accumulation time, container type, and the actual activity performed all factor in.

A Practical Decision Sequence

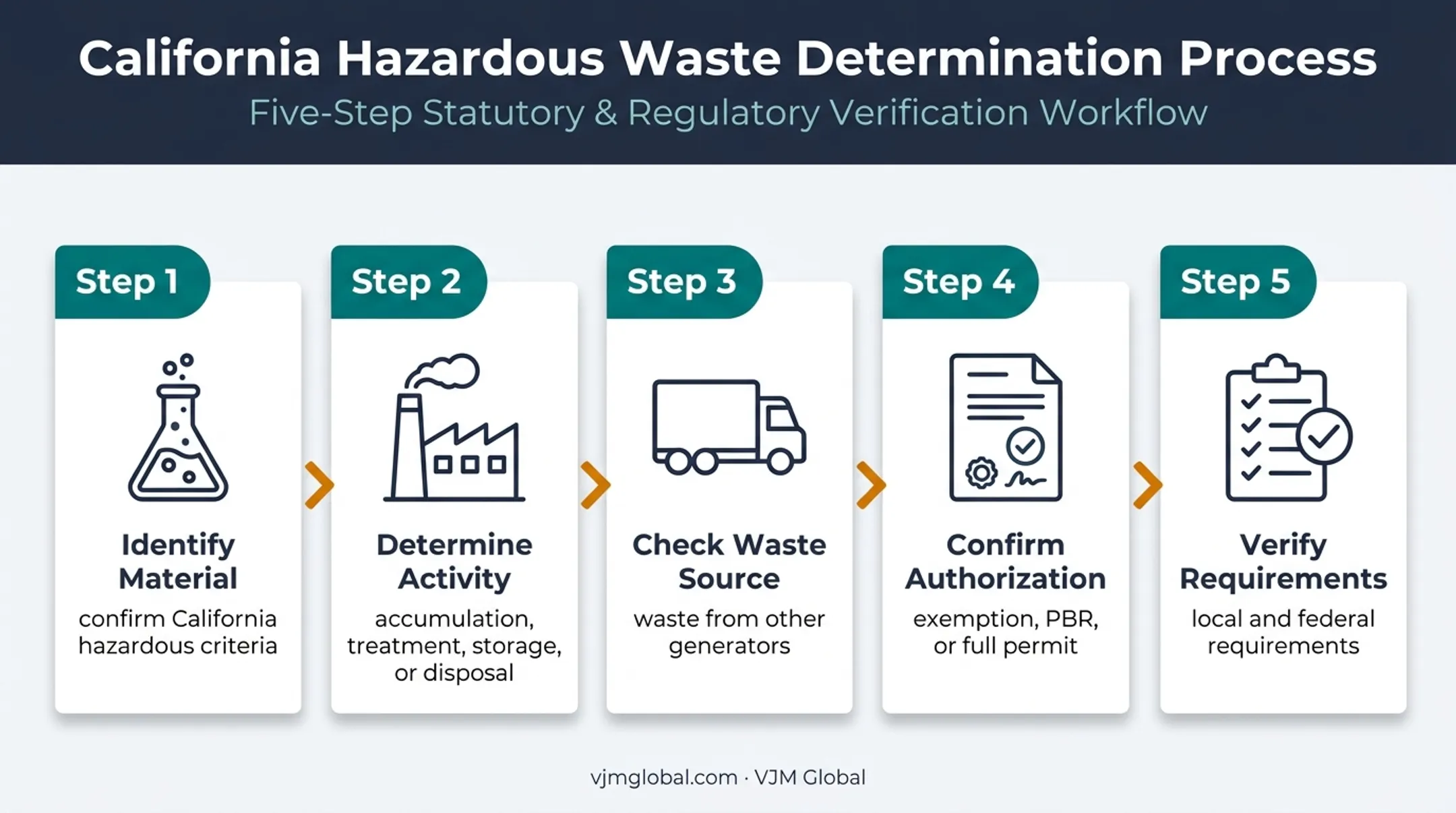

  1. Identify the material and confirm whether it's hazardous under California criteria
  2. Determine the business activity — accumulation, treatment, storage, or disposal
  3. Check whether waste arrives from other generators (this almost always triggers facility-level review)
  4. Confirm the applicable authorization — generator exemption, Permit by Rule, or full permit
  5. Verify local and federal requirements layered on top

Five-step California hazardous waste permit decision sequence

Skipping this sequence carries real risk. Beginning treatment, storage, or disposal operations without proper authorization can trigger enforcement action, cleanup liability, financial penalties, and operational shutdowns.

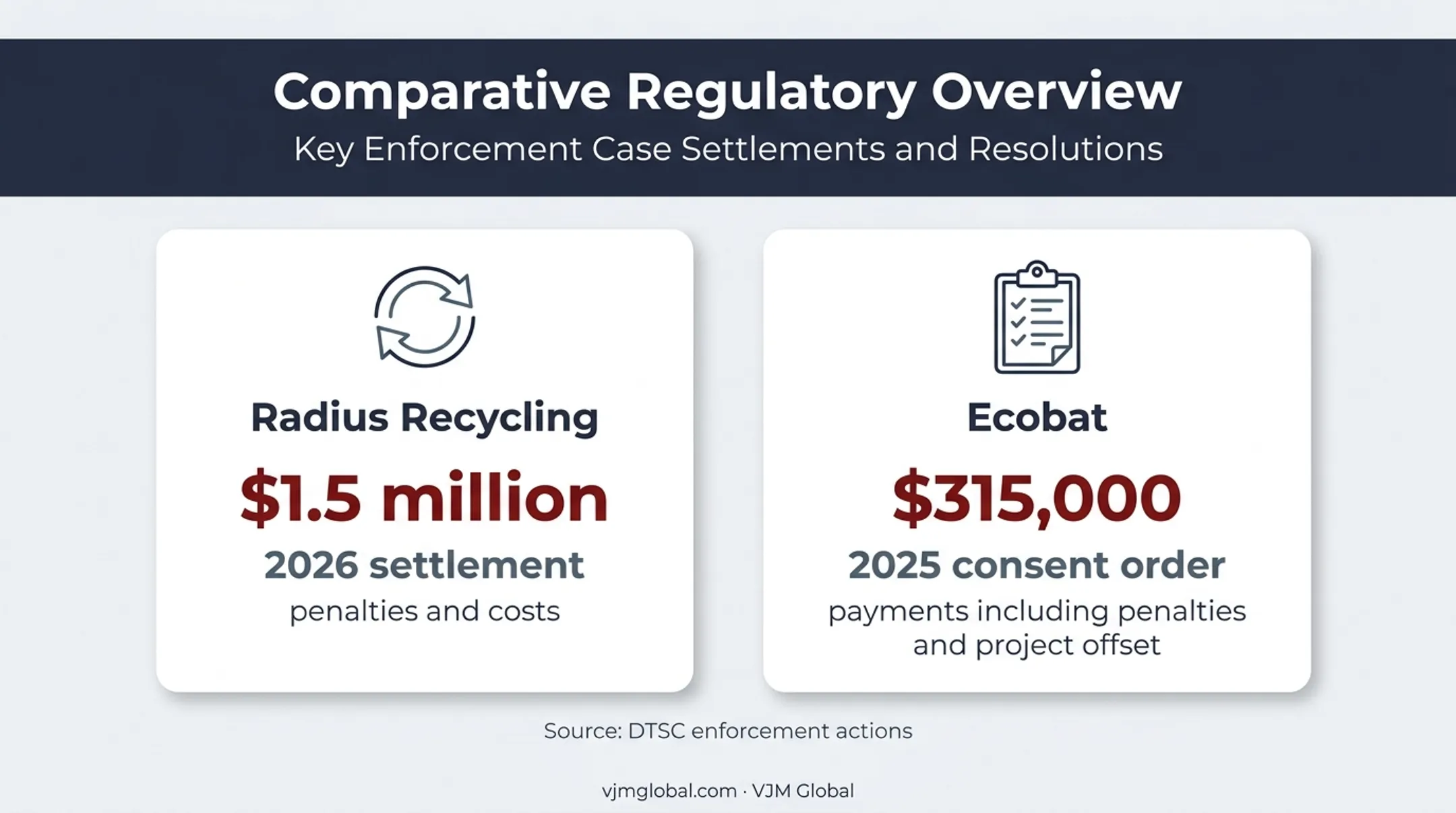

DTSC's 2026 settlement with Radius Recycling, which required $1.5 million in penalties and costs for unauthorized treatment and storage violations, is a concrete example of what those failures cost.

California Hazardous Waste Permit Types and Permit by Rule

California offers several authorization pathways, each tied to a specific scope of activity.

The Main Pathways

  • Full hazardous waste facility permit — required for operations not covered by a narrower route
  • Interim status — potentially available to qualifying existing facilities, not a shortcut for new projects
  • Standardized permit — a separate DTSC tier for specific qualifying operations
  • Permit by Rule (PBR) — conditional authorization for eligible fixed or transportable treatment units
  • Conditional authorization (CA) — for specified onsite generator treatment meeting statutory limits
  • Conditional exemption (CE) — narrow treatment covered by a particular statutory exemption

What Permit by Rule Actually Means

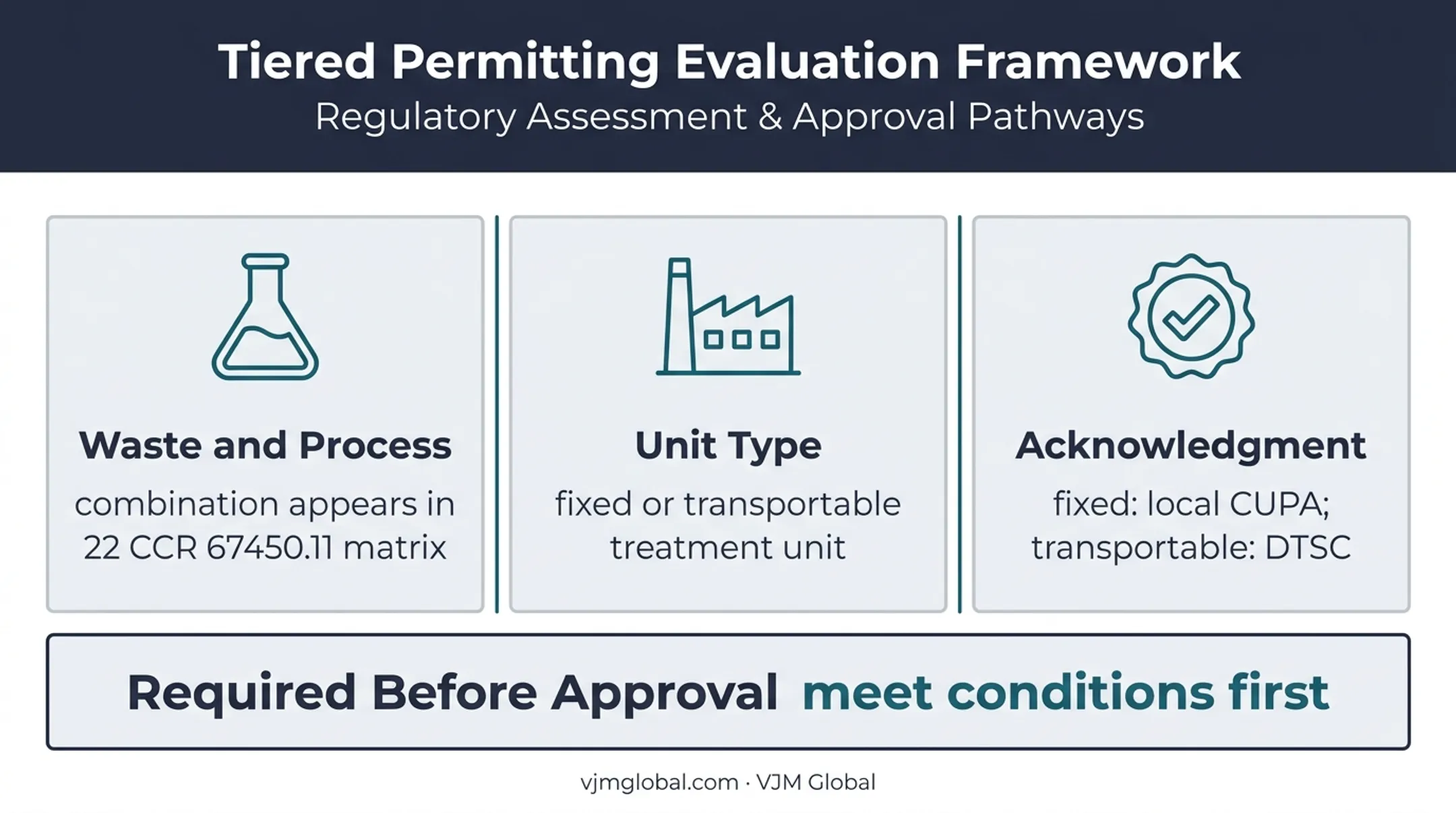

PBR isn't a blanket approval for "recycling" or "treatment" generally. Eligibility depends on whether your specific waste type and treatment process combination appears in the regulatory matrix under 22 CCR section 67450.11. The unit's name or general category doesn't determine eligibility — the actual combination does.

Fixed treatment units need acknowledgment from the local CUPA or authorized agency. Transportable treatment units need DTSC acknowledgment. Neither acknowledgment is automatic once you file; you must meet the conditions first.

Permit by Rule eligibility and acknowledgment requirements framework

Where PBR Falls Short

Permit by Rule comes with real constraints:

  • Limits on allowed waste type and treatment process combinations
  • Quantity and process caps that restrict throughput
  • Facility design and operating standards you must meet
  • Notification, recordkeeping, and inspection duties
  • Closure obligations when the unit stops operating
  • Possible loss of authorization for noncompliance

PBR vs. Full Permit

Factor Permit by Rule Full Facility Permit
Scope Limited to specific waste/process combinations Broad, site-specific operational scope
Public involvement Minimal Notice, comment, sometimes hearings
Application burden Notification and acknowledgment Full Part A/B application
Operational flexibility Constrained to approved conditions Defined by negotiated permit terms
Enforcement exposure Still subject to inspection and penalties Subject to permit conditions and modifications

Before relying on PBR, confirm with DTSC that your waste and process still qualify and that terminology has not changed. California's Generator Improvements Rule took effect in July 2024, with technical corrections in January 2026, so check current DTSC guidance before you file.

How to Apply for a California Hazardous Waste Facility Permit

A full facility permit application starts well before you submit paperwork.

Pre-Application Assessment

  • Characterize each waste stream you'll handle
  • Identify applicable federal and California waste codes
  • Define your proposed treatment or storage process in detail
  • Confirm site feasibility and zoning compatibility

Core Application Materials

DTSC's application structure splits into two parts. Part A covers operator identity, location, waste types, and quantities. Part B goes deeper:

  • Facility and unit design information
  • Process descriptions and waste acceptance criteria
  • Operating procedures and inspection schedules
  • Emergency response plans and personnel training programs
  • Financial assurance and closure/post-closure plans
  • Groundwater or air-monitoring information where applicable

How This Connects to Other Approvals

DTSC's permit process doesn't run in isolation. Depending on the project, you may also need:

  • Local land-use approvals
  • California Environmental Quality Act (CEQA) review
  • Fire-code or hazardous-materials sign-off
  • Other environmental permits specific to your site

The Review Process

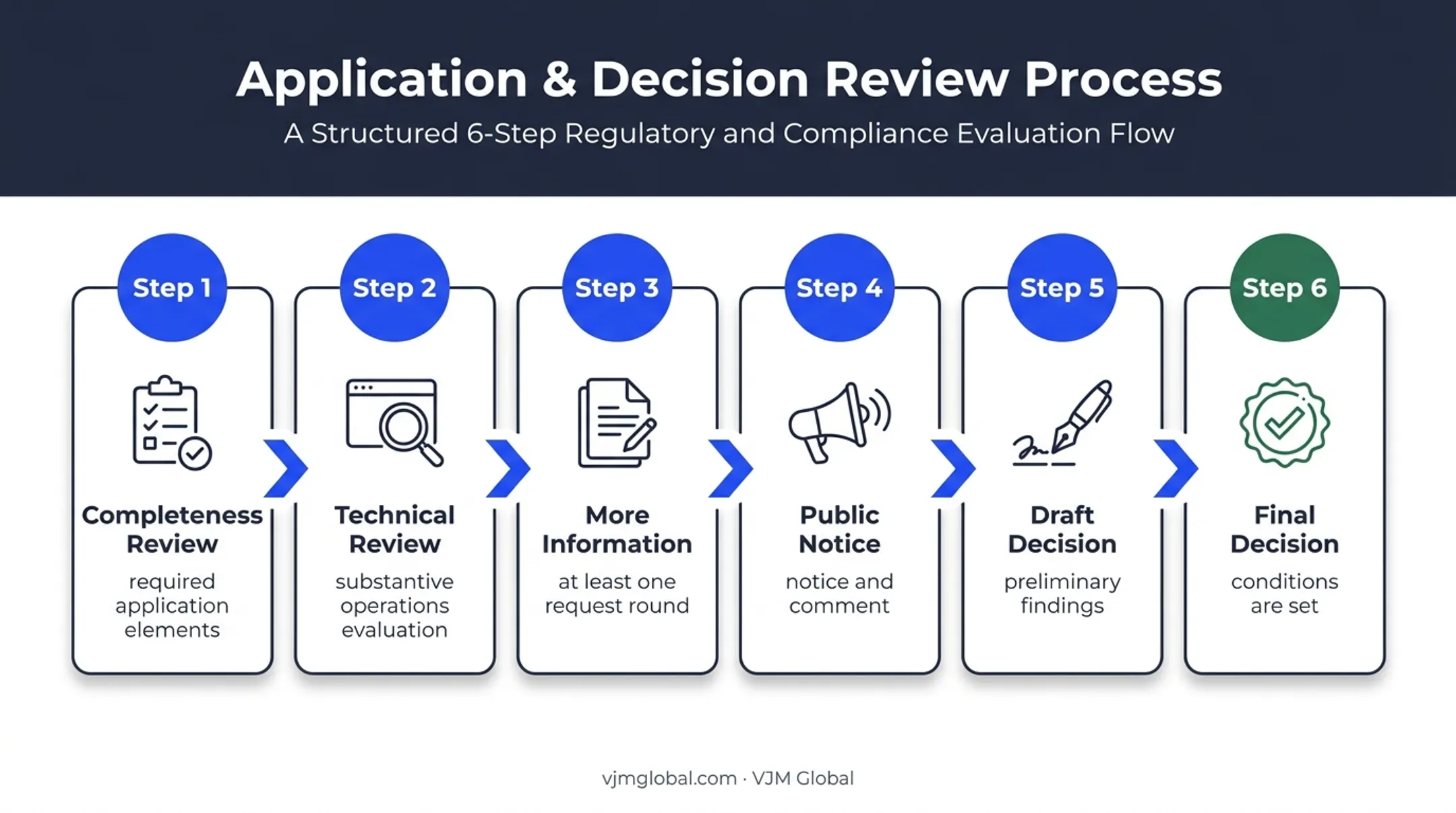

  1. Completeness review: DTSC confirms your application has the required elements
  2. Technical review: substantive evaluation of your proposed operations
  3. Requests for additional information: expect at least one round
  4. Public notice and comment: required for most new or expanded facilities
  5. Draft decision: DTSC issues preliminary findings
  6. Response to comments and final decision: permit conditions are set

Six-step California hazardous waste permit review process flow

Final permit conditions typically address waste types and quantities, operating hours, storage areas, monitoring obligations, contingency planning, and reporting schedules.

Pre-Submission Checklist

  • Ownership and site documentation
  • Complete waste profiles
  • Engineering drawings
  • Emergency contact information
  • Financial assurance evidence
  • Closure strategy documentation
  • Local approval records

Businesses expanding into California often underestimate how much permitting runs in parallel with entity formation, tax registration, and local business licensing.

At VJM Global, we support companies setting up US operations on the accounting, tax, and compliance side. Environmental permitting falls to specialized environmental counsel, but coordinating timelines across both tracks helps keep the launch on schedule.

Ongoing Compliance, Inspections, and Enforcement

Getting the permit is the easy part. Staying compliant is where most violations happen.

Records You Should Maintain

  • Waste determinations and analytical results
  • Manifests for offsite shipments
  • Inspection logs and training records
  • Operating data and incident reports
  • Annual Facility Reports for permitted facilities (separate from the biennial report that RCRA large quantity generators file)
  • Correspondence with regulators

Common Compliance Failures

  • Accepting waste outside your permit's approved types
  • Exceeding storage limits or accumulation timeframes
  • Inaccurate waste characterization
  • Missing or incomplete inspection logs
  • Late reporting
  • Inadequate emergency planning
  • Operating outside approved processes

DTSC's 2025 consent order with Ecobat shows the financial stakes. Failures to maintain required inspection records and schedules led to $315,000 in payments, including penalties and a supplemental environmental project offset.

California hazardous waste enforcement settlements and financial consequences comparison

Responding to a Violation Notice

  1. Preserve all relevant records immediately
  2. Correct immediate hazards on site
  3. Notify appropriate agencies per your permit conditions
  4. Document every corrective action taken
  5. Obtain professional advice before responding in writing

A Practical Action Plan

  • Inventory every waste stream your business produces
  • Identify the activity performed with each one
  • Confirm the applicable authorization directly with DTSC
  • Build a compliance calendar for reports, inspections, and renewals
  • Revisit requirements whenever your process, waste profile, site, or ownership changes

Frequently Asked Questions

What is considered hazardous waste in California?

Waste is hazardous if it's listed, exhibits a hazardous characteristic (ignitability, corrosivity, reactivity, toxicity), or meets California-specific TTLC/STLC criteria. Always verify against current Title 22 and DTSC classification guidance.

What are some examples of hazardous waste in California?

Common examples include spent solvents, certain batteries, paints, pesticides, laboratory chemicals, e-waste, and contaminated absorbents. Final classification always depends on testing and applicable exclusions.

What is the "permit by rule" for hazardous waste in California?

Permit by Rule is a conditional authorization for specific eligible treatment units and waste/process combinations. It requires meeting defined operating standards, notifications, and continuing compliance — not a blanket exemption.

What are the newest hazardous waste rules in California?

Recent changes include the Generator Improvements Rule (effective July 2024) and technical corrections (effective January 2026). Always check DTSC's final regulations page, since proposed rules aren't enforceable until adopted.

Does every business that generates hazardous waste need a facility permit?

No. Generators accumulating their own waste within applicable conditions don't need a facility permit. You likely need one if you treat, store beyond generator limits, dispose of waste, or accept waste from other generators.

Is a California EPA ID number the same as a hazardous waste facility permit?

No. An EPA ID number identifies you as a regulated generator or facility for tracking purposes. It doesn't authorize treatment, storage, or disposal operations on its own.
