Hazardous Waste Facility Permit: Application Process & Requirements A hazardous waste facility permit is the regulator-issued approval that lets a site receive, store, treat, recycle, or dispose of specified hazardous wastes under set operating and environmental conditions.

This guide is written for Australian facility owners, operators, project developers, environmental managers, and overseas businesses planning operations here. Getting this approval right protects workers, nearby communities, and the environment — and it demonstrates compliance to regulators, insurers, and investors alike.

Many people treat "hazardous waste facility permit" as one fixed document. It isn't. Each state and territory runs its own system, with different names, different trigger activities, and different paperwork. A licence in Victoria looks nothing like an environmental authority in Queensland or a works approval in Western Australia.

This article covers the eligibility checks, application stages, technical documents regulators expect, and the mistakes that most often slow applications down.

Key Takeaways

  • Facilities often need several approvals: environmental licence, planning consent, works approval, and waste transport authorisation
  • The correct regulator and pathway depend on your state, waste types, treatment activity, capacity, and nearby sensitive sites
  • Strong applications map the complete waste lifecycle, from acceptance through closure and post-closure care
  • Always confirm current rules with your state or territory regulator before lodging or starting site works

What Is a Hazardous Waste Facility Permit and When Is It Needed?

A hazardous waste facility permit is the approval a regulator issues before a site can legally accept, store, treat, recycle, or dispose of hazardous waste generated elsewhere. It's different from:

  • Generator registration (covers waste you produce on your own site)
  • Waste transport licence (covers moving waste between locations)
  • Dangerous goods approval (covers storage and handling under work health and safety law)
  • Development consent (covers land use and building)
  • WHS obligations (worker safety, separate from environmental approval)

Holding one of these doesn't mean you hold the others. A transport licence, for instance, does not authorise you to store or treat waste once it arrives at your gate.

Activities That Commonly Trigger Approval

Regulators generally require approval when a facility:

  • Accepts waste from third parties, not just its own operations
  • Stores hazardous waste long-term
  • Treats, blends, or reprocesses waste
  • Recycles hazardous materials at scale
  • Incinerates or landfills waste

Trigger activities vary by jurisdiction. Verify them against the relevant state or territory schedule rather than assuming your project does (or doesn't) need a licence.

How Australian Environmental Regulation Works

There's no single national permit. Each state and territory runs its own regulator and its own approval name:

State/Territory Regulator Approval name
NSW NSW EPA Environment protection licence
Victoria EPA Victoria Development licence + operating licence
Queensland DESI (Qld) Environmental authority
South Australia SA EPA Environmental authorisation (licence)
Western Australia DWER Works approval + licence
Northern Territory NT EPA Environment protection licence
Tasmania EPA Tasmania Permit with environmental conditions
ACT ACT EPA Environmental authorisation

Waste classification and facility characteristics shape which pathway applies. Assessment factors typically include:

  • Hazardous properties and waste codes
  • Annual throughput and storage capacity
  • Treatment technology used on site
  • Proximity to sensitive receptors (schools, waterways, residential areas)

Some low-risk, temporary, emergency, or exempt activities may qualify for a simpler pathway. Tasmania, for example, exempts certain waste temporarily stored where it's produced, pending transport.

Don't assume an exemption applies — confirm it in writing with the relevant regulator. Federal guidance or U.S. frameworks won't tell you what Tasmania or Western Australia actually requires.

How to Apply for a Hazardous Waste Facility Permit

The exact forms differ by state, but the overall sequence follows a similar pattern across Australia.

  1. Identify the jurisdiction and regulator. Confirm the facility address, proposed activities, waste types, capacity, and whether the site crosses state or territory boundaries.
  2. Run an approvals and feasibility assessment. Check land-use zoning, planning consent, environmental impact assessment triggers, water and air approvals, dangerous goods controls, and consultation obligations.
  3. Prepare a facility concept and pre-application enquiry. Describe site layout, waste acceptance criteria, storage areas, treatment units, containment systems, traffic movements, and nearby sensitive land uses.
  4. Compile the application evidence. Waste profiles, process descriptions, engineering designs, risk assessments, environmental management plans, emergency procedures, monitoring proposals, closure plans, and ownership details.
  5. Submit forms, pay fees, and respond to information requests. Track every revision so the final application stays internally consistent, since mismatched capacity figures across documents are a common reason for delay.
  6. Go through assessment and decision. Expect technical review, possible site inspection, further information requests, public consultation where applicable, and conditions attached to any approval. Regulated operations cannot start until written approval is in hand.
  7. Confirm the regulator-specific sequence for your state. Fees, processing stages, and renewal requirements vary considerably.

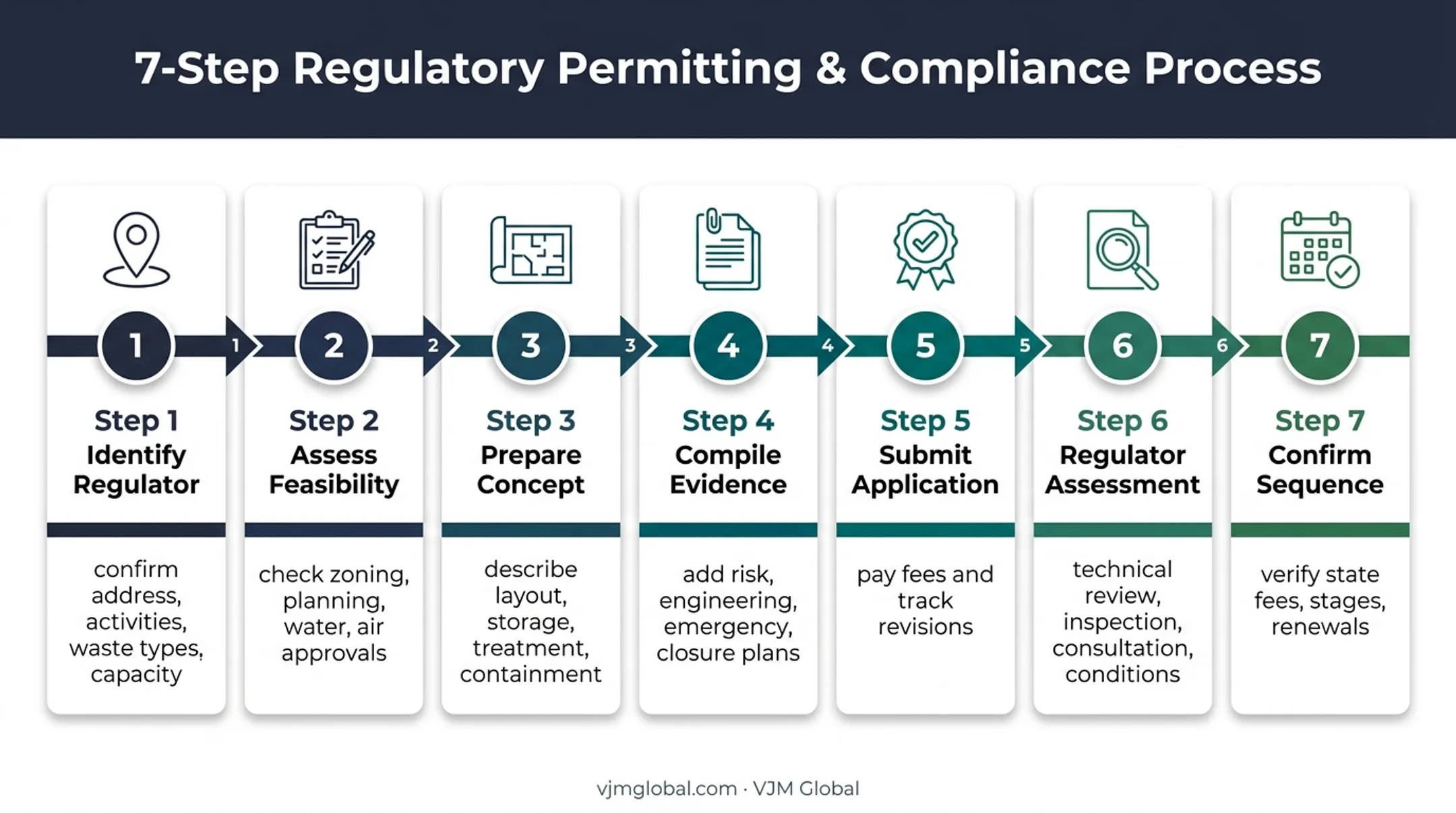

Seven-step Australian hazardous waste permit application process

Victoria as a Worked Example

Victoria shows how detailed this gets. Prescribed high-risk waste developments may need a development licence before applying for an operating licence.

  • A complete development-licence application has a published four-month decision period
  • Operating-licence assessment takes up to 42 business days, or 15 business days if you already hold a satisfactory development-licence completion statement
  • EPA Victoria's current fee schedule lists a new operating-licence application at $1,464.14, plus $112.77 per hour after 13 hours, capped at $16,671.59
  • Progressing from a development licence to an operating licence carries no separate application fee

Further information requests can push out any of these timeframes, so build in buffer when planning construction schedules.

Where a Compliance Partner Fits

Environmental permitting needs specialist environmental engineers, planners, and lawyers. That part isn't negotiable. But a hazardous waste facility is usually one piece of a much larger market-entry project, especially for overseas companies.

For foreign businesses establishing operations in Australia, coordinating entity formation, tax registration, and broader regulatory clearances alongside the environmental approval is its own workload. VJM Global supports that side of the project — business setup, accounting, and compliance coordination for companies entering Australia — without replacing the environmental specialists the permit itself requires.

What Must the Application Demonstrate?

Regulators want the complete waste lifecycle, not just a site plan.

EPA Victoria's A13a guidance for large waste and resource recovery facilities is a useful illustration. It applies once a site receives 4,000 tonnes or more in any month, or stores 10,000 cubic metres at one time.

The guidance requires a storage-management plan, risk and monitoring program, emergency-management plan, and decommissioning arrangements.

Waste Acceptance and Classification

The application must explain how the facility will:

  • Identify which waste streams it's permitted to accept
  • Verify manifests and supplier information before waste arrives
  • Reject incompatible or unauthorised loads
  • Sample or test waste where classification is uncertain
  • Maintain traceability from acceptance through to final disposition

Facility Design and Containment

Regulators expect evidence covering:

  • Impermeable surfaces and bunding or secondary containment
  • Drainage segregation, so contaminated runoff never reaches clean stormwater
  • Tank and container integrity
  • Fire protection, ventilation, and odour control
  • Spill prevention and compatibility between stored materials

Design standards vary by state and waste type. Confirm which ones apply to your site rather than assuming a standard from another jurisdiction carries over.

Operating Controls and Monitoring

A credible application sets:

  • Operating limits and maximum inventory
  • Segregation rules for incompatible wastes
  • Inspection schedules and equipment maintenance routines
  • Recordkeeping, worker training, and contractor controls
  • Controls for air, water, noise, odour, and dust emissions

Monitoring proposals need identified sampling points, parameters, frequency, and a quality-assurance approach, plus a clear plan for incident reporting and regulator notification.

Emergency Response and Closure

Emergency plans must address:

  • Fire, explosion, spills, and leaks
  • Incompatible chemical reactions
  • Extreme weather, power failure, and transport incidents
  • Evacuation procedures and coordination with emergency services

Closure planning covers decontamination, removal of residual waste, site assessment against closure criteria, post-closure monitoring, and any land-use restrictions.

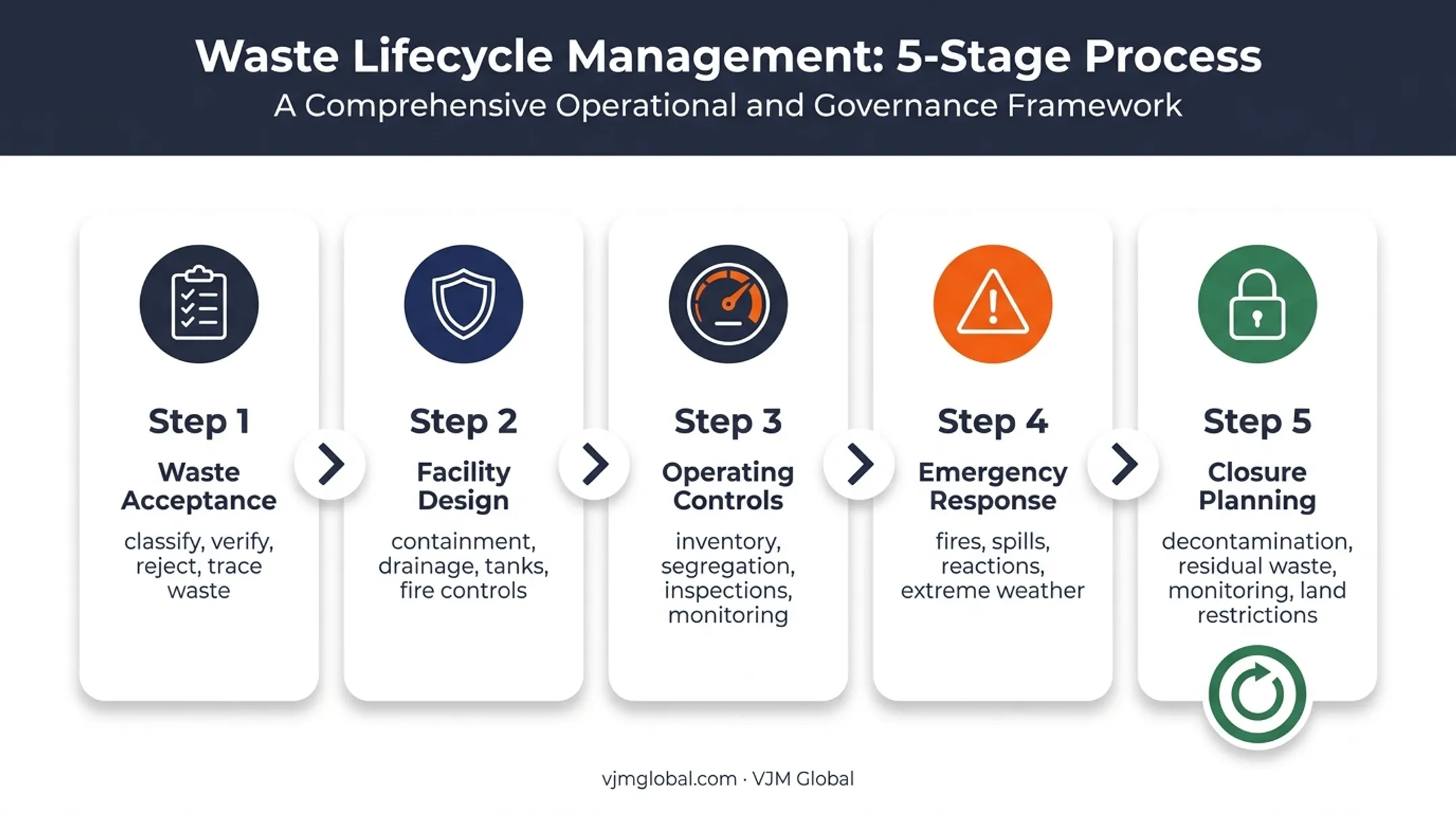

Five-stage hazardous waste facility lifecycle compliance process

Victoria's conditions can also require financial assurance in a form and amount the regulator determines. Budget for this early rather than treating it as a late-stage formality.

Before lodging, check your state's regulator-issued checklist so you know exactly what's mandatory versus what's simply recommended supporting evidence. The two lists aren't always the same.

Where the Approval Fits and Common Problems

A facility permit rarely stands alone. Depending on the site, you may also need:

  • Planning or development consent from the local council
  • Building approval
  • Water discharge or extraction approval
  • Air emissions approval
  • Dangerous goods storage approval
  • Waste transport authorisation
  • Fire authority sign-off
  • Cross-border movement controls if waste crosses state or territory borders

South Australia's EPA, for example, requires development approval before it will issue an environmental authorisation for relevant recycling facilities. The two approvals are sequential, not interchangeable.

Mistakes That Slow Applications Down

The most common delays come from:

  • Incomplete waste inventories
  • Unclear process flow diagrams
  • Inconsistent capacity figures across different documents
  • Missing site ownership information
  • Inadequate groundwater or stormwater controls
  • Weak emergency plans
  • No evidence of community consultation
  • Failure to address closure liabilities upfront

Two Misconceptions Worth Correcting

A transport or generator approval does not automatically authorise treatment, storage, or disposal at a facility. These are separate permissions with separate conditions.

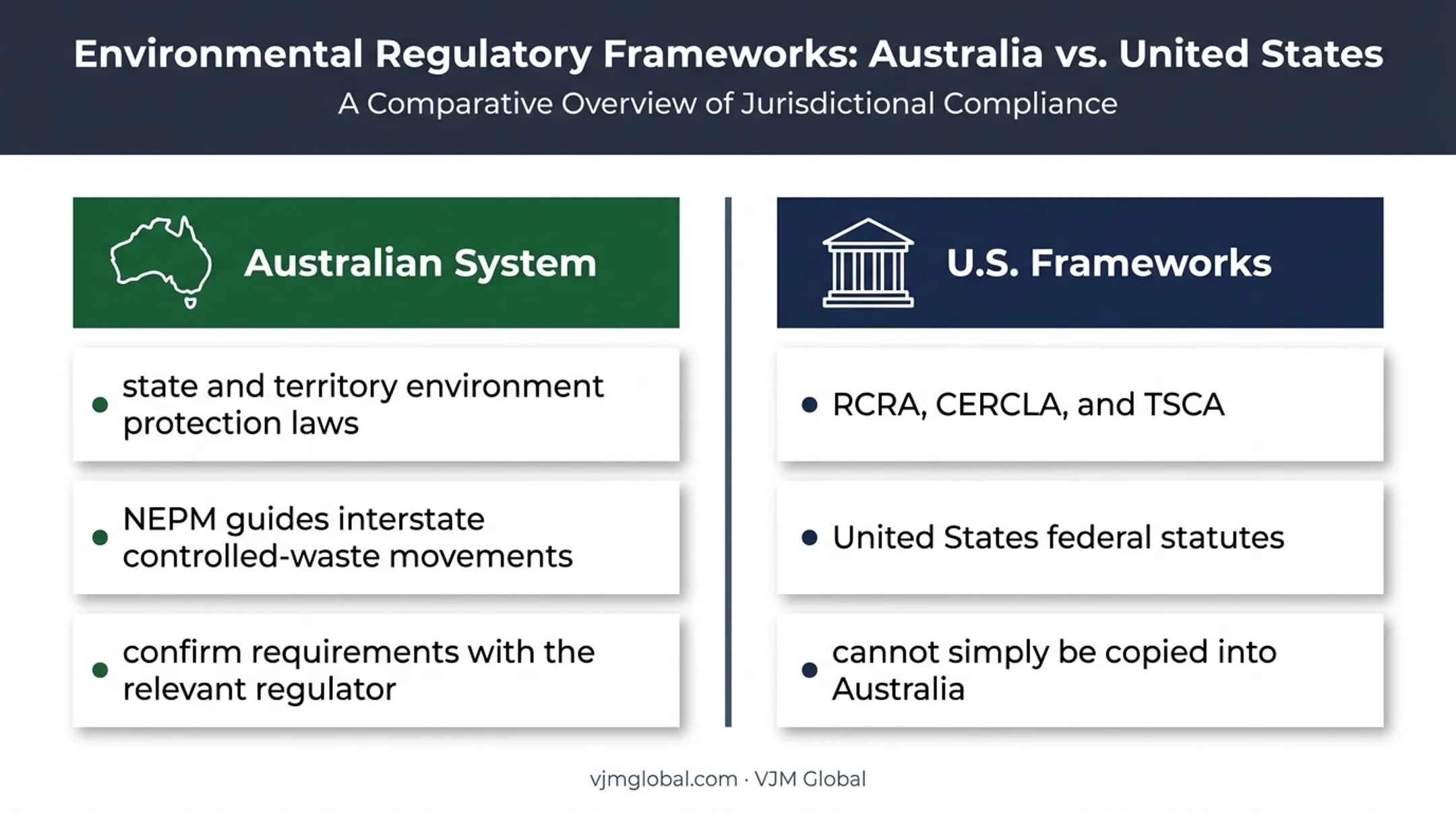

A U.S. RCRA Part A or Part B process also cannot simply be copied into an Australian application. RCRA, CERCLA, and TSCA are U.S. federal frameworks — Australian applicants work within their own state or territory system instead.

Australian and United States hazardous waste regulatory framework comparison

Quick pre-submission checklist:

  • Confirm jurisdiction and classify wastes
  • Map every required approval
  • Validate site suitability
  • Complete engineering and risk documents
  • Arrange specialist reviews
  • Seek informal regulator feedback before lodging

Conclusion

Getting a hazardous waste facility permit right is a staged process:

  • Jurisdictional screening
  • Site and process design
  • Technical evidence
  • Regulator review
  • Ongoing operational compliance once approved

The approval is facility- and activity-specific. A threshold that applies in Victoria won't necessarily apply in Queensland, and guidance written for U.S. facilities won't tell you anything useful about Australian requirements.

Before construction or operation begins, confirm current requirements directly with your state or territory regulator, paired with qualified environmental, engineering, and legal advice specific to your site.

If the broader project also needs an Australian business presence—entity registration, tax compliance, or payroll—VJM Global can coordinate that side of the work, leaving environmental permitting to the specialists who handle it every day.

Frequently Asked Questions

How do I get a hazardous waste facility permit in Australia?

Apply through your state or territory environment regulator (such as EPA Victoria, NSW EPA, or Queensland’s DES). Expect scrutiny of facility design, waste types, operating controls, and monitoring. Cross-border controlled-waste movements must also align with the national NEPM framework.

Do RCRA, CERCLA, or TSCA apply to Australian facilities?

No. Those are United States statutes. In Australia, facility licensing sits under state and territory environment protection laws, with the National Environment Protection (Movement of Controlled Waste) Measure guiding interstate controlled-waste movements.

How is hazardous waste classified in Australia?

Australia does not use a single universal “seven types” list. Controlled waste is grouped under the NEPM using List 1 categories and List 2 hazardous characteristics. Confirm the categories that apply with your state or territory EPA’s waste classification guidelines.
