Obtaining Environmental Permits for Manufacturing Facilities Many manufacturers assume one environmental permit will cover a new facility. It won't. Obtaining environmental permits for a manufacturing facility means identifying, applying for, securing, and maintaining every environmental approval required before and during operations, and in Australia that list rarely has a single name on it.

This matters for manufacturers, facility owners, project managers, and foreign businesses planning Australian operations, because requirements shift between federal, state or territory, and local authorities. In Victoria, for example, EPA Victoria notes that development licence assessment can take up to four months, with a separate operating licence review adding up to 42 business days on top.

Get the permitting strategy wrong and the fallout touches site selection, construction timing, operating limits, and legal exposure. Despite how often "environmental permitting" comes up in planning conversations, it's poorly understood at the operational level, largely because Australia has no universal permit covering every manufacturing facility.

This article explains which approvals may apply, how the process works, what documents regulators commonly request, and how to manage obligations once approval lands.

Key Takeaways

  • Approvals depend on location, activity, emissions, discharges, waste streams, water use, and impacts on protected land or species.
  • Start permit screening during site selection, not after signing a lease or pouring concrete.
  • Federal, state or territory, and local authorities can all have a role, each covering different impacts.
  • A permit isn't a finish line: monitoring, reporting, and renewals continue for the life of the facility.
  • Confirm current thresholds and pathways with the relevant regulator, since terminology varies by jurisdiction.

What Are Environmental Permits for Manufacturing Facilities?

Environmental permits and approvals are legal authorisations, licences, works or development approvals, registrations, consents, or conditions that allow a specified activity to proceed subject to environmental controls. They let industrial activity proceed while managing risks to air quality, waterways, land, biodiversity, nearby communities, and human health.

A manufacturing facility rarely needs one "environmental permit." It usually needs several, depending on what it makes, how it makes it, and where it sits.

These approvals are distinct from other permissions a facility needs, including:

  • Planning or development consent from a council or state planning authority
  • Building approval for construction works
  • Dangerous-goods licensing for storing or handling hazardous substances
  • Workplace health and safety approvals
  • Trade waste approval for sewer discharge
  • Utility connection agreements for water, power, or gas

How Authority Is Divided

Responsibility sits at three levels:

  • Commonwealth: nationally protected matters under the Environment Protection and Biodiversity Conservation Act 1999 (EPBC Act)
  • State and territory regulators: pollution, waste, water, and works or development approvals
  • Local councils: planning conditions and local discharge limits

Same Activity, Different Rules: Electroplating

Electroplating shows why state-by-state checks matter. In New South Wales, the Protection of the Environment Operations Act 1997 lists metal coating, including electroplating, as a scheduled activity. Once a facility processes more than 10,000 tonnes of metal a year, it triggers an environment protection licence.

Victoria takes a different route. EPA Victoria's I04 metal finishing category covers electroplating of metal or plastic under its development and operating licence framework. An operating licence is not required where waste is discharged solely to the atmosphere, subject to stated exemptions.

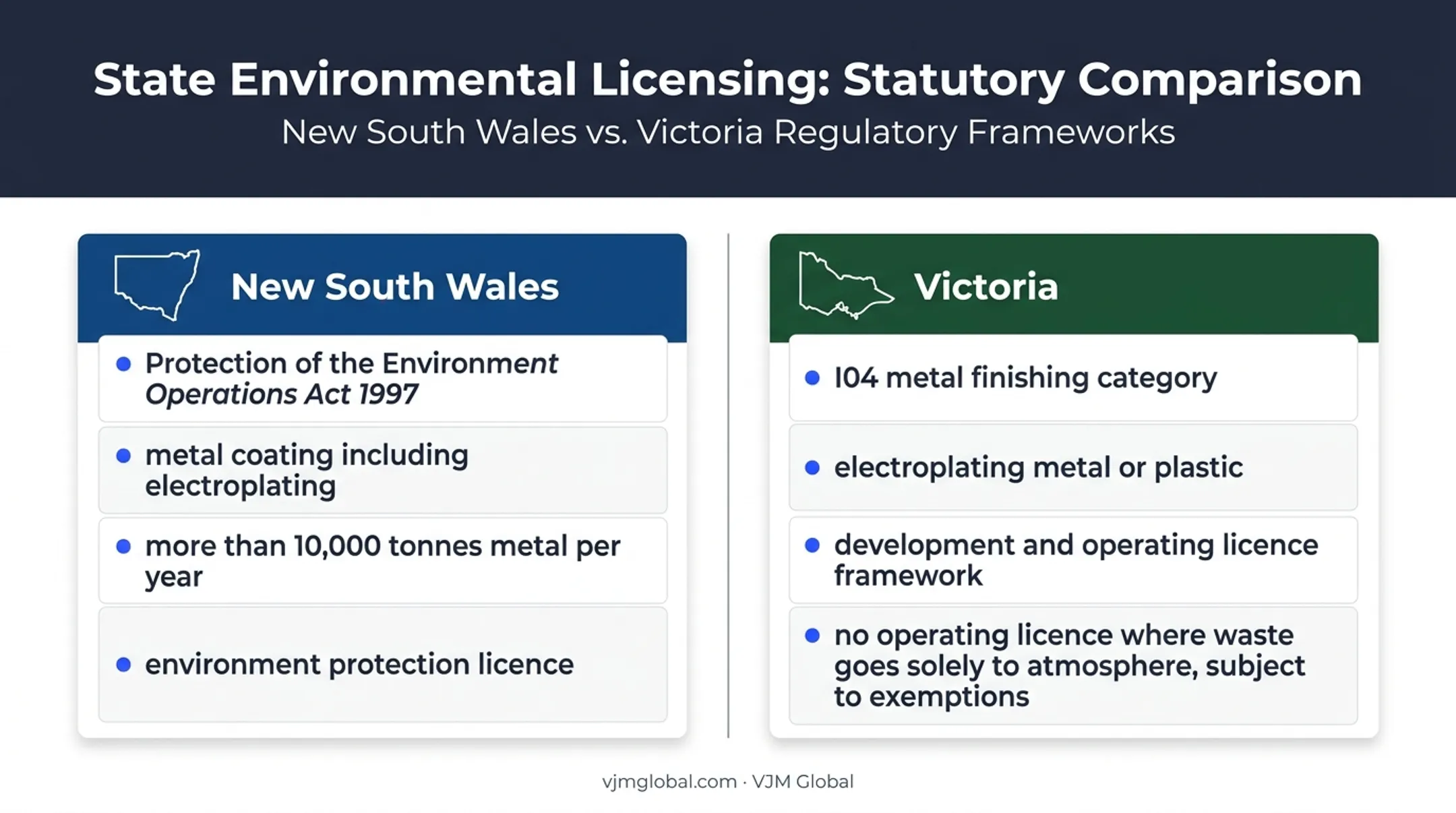

New South Wales versus Victoria electroplating permit requirements comparison

Same process, two different statutory tests. Neither is a national rule.

How the Environmental Permitting Process Works

The process runs from project definition through ongoing compliance. You screen laws, assess impacts, consult regulators, lodge applications, answer review requests, accept conditions, and operate within them.

Start this work during feasibility and site selection—well before the site is locked in or production capacity is finalised.

Build Your Project Profile and Permit Matrix

Before approaching regulators, document the basics:

  • Location, land ownership, and site history
  • Production volumes, raw materials, fuels, and chemicals
  • Equipment, waste streams, and emissions
  • Water intake, wastewater, stormwater, and proposed operating hours

From that profile, build a permit matrix. For each possible approval, record:

  • Responsible authority and triggering activity
  • Submission documents and expected decision stage
  • Renewal date, conditions, and internal owner

That single document becomes the project's compliance roadmap.

The Four Practical Steps

  1. Screen requirements across all levels of government. Check federal, state or territory, and local obligations, documenting confirmed approvals and open questions for the relevant authority.
  2. Complete baseline studies and impact assessments. Scale these to the site, covering air, water, soil, noise, biodiversity, traffic, cultural heritage, or contaminated land where relevant.
  3. Submit coordinated applications. Keep technical data consistent across submissions, respond promptly to regulator questions, and track status, dependencies, and consultation periods.
  4. Convert conditions into operating procedures. Turn permit conditions into monitoring schedules, reporting deadlines, maintenance tasks, training, and recordkeeping systems.

Once applications are in, regulators usually run a completeness check first. They then raise technical questions, request further information, consult other agencies, and may open public notification before issuing conditions—or, occasionally, refusing the application.

Note: In NSW, the EPA's guide to licensing confirms that development consent must be obtained before applying for an environment protection licence, not after. Planning approval and the operating licence are two separate steps, not one.

Construction, commissioning, production increases, new chemicals, new emission sources, or altered discharge points can all require a variation, amendment, or regulator notification before the change goes ahead, not after.

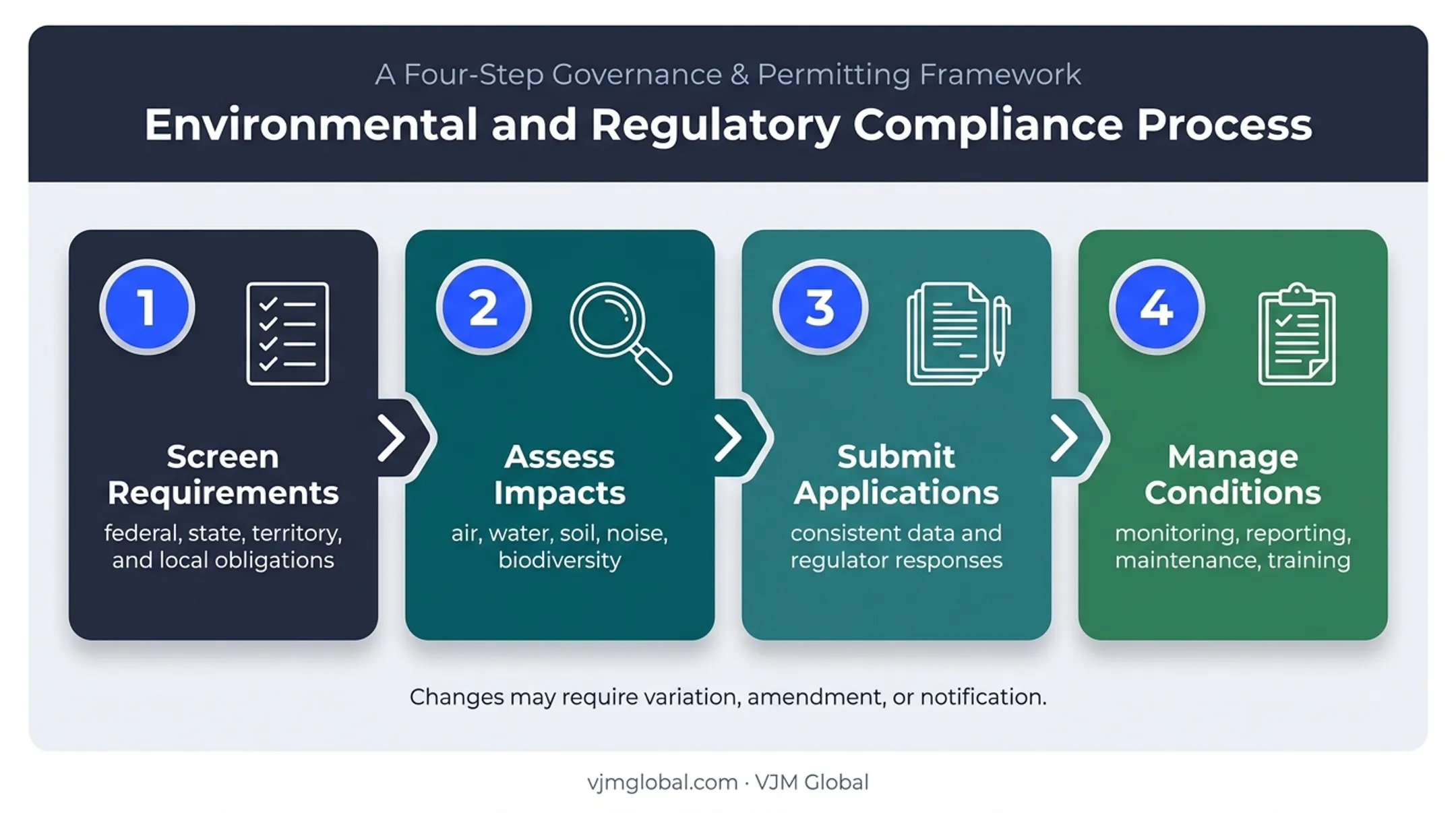

Four-step Australian manufacturing environmental permitting process flow

Which Environmental Approvals May a Manufacturing Facility Need?

The categories below are screening guides, not a universal checklist. Always confirm current thresholds with the relevant Australian regulator.

Category What it covers
Air emissions Boilers, kilns, furnaces, coating lines, foundries, and combustion equipment may trigger licensing, stack testing, operating limits, or reporting obligations.
Water and wastewater Extracting water, discharging industrial wastewater, connecting to sewer or trade-waste systems, altering waterways, or managing contaminated stormwater.
Waste and hazardous materials Classification, storage, treatment, transport, tracking, and disposal of industrial or hazardous waste, including obligations on contractors and off-site facilities.
Land and biodiversity Clearing vegetation, disturbing wetlands, affecting waterways, or impacting threatened species may trigger additional assessment.
Planning and local government Zoning, development consent, construction approval, noise, odour, and stormwater infrastructure conditions.
Federal assessment Projects affecting nationally protected matters, such as listed threatened species, Ramsar wetlands, or World Heritage areas, may need referral under the Environment Protection and Biodiversity Conservation (EPBC) Act framework.

Before locking in a site or process line, run through these screening questions:

  • What will the facility emit?
  • What will it discharge?
  • What waste will it generate?
  • What resources will it use (water, energy)?
  • What land or habitat will it disturb?
  • Which authority controls each of these activities?

Key Factors That Affect Approval

Several variables shape how straightforward, or complicated, approval becomes.

  • Site and location – Proximity to homes, waterways, wetlands, protected areas, or contaminated land increases study requirements and community scrutiny.
  • Facility scale and operating profile – Production capacity, operating hours, fuel and chemical use, and wastewater volume all influence which approvals apply.
  • Quality of technical information – Incomplete process descriptions or inconsistent emissions estimates are a leading cause of regulator questions and delay.
  • Timing and dependencies – Land purchase, design, construction, and production launch often depend on specific approvals. Map the critical path; don't assume permits run in parallel.
  • Community and stakeholder engagement – Public notification, neighbour engagement, or Traditional Owner consultation may apply. Early, factual communication tends to surface concerns before formal review does it for you.
  • Ongoing compliance – Monitoring, sampling, incident notifications, periodic reporting, audits, and renewals continue well after approval is granted.

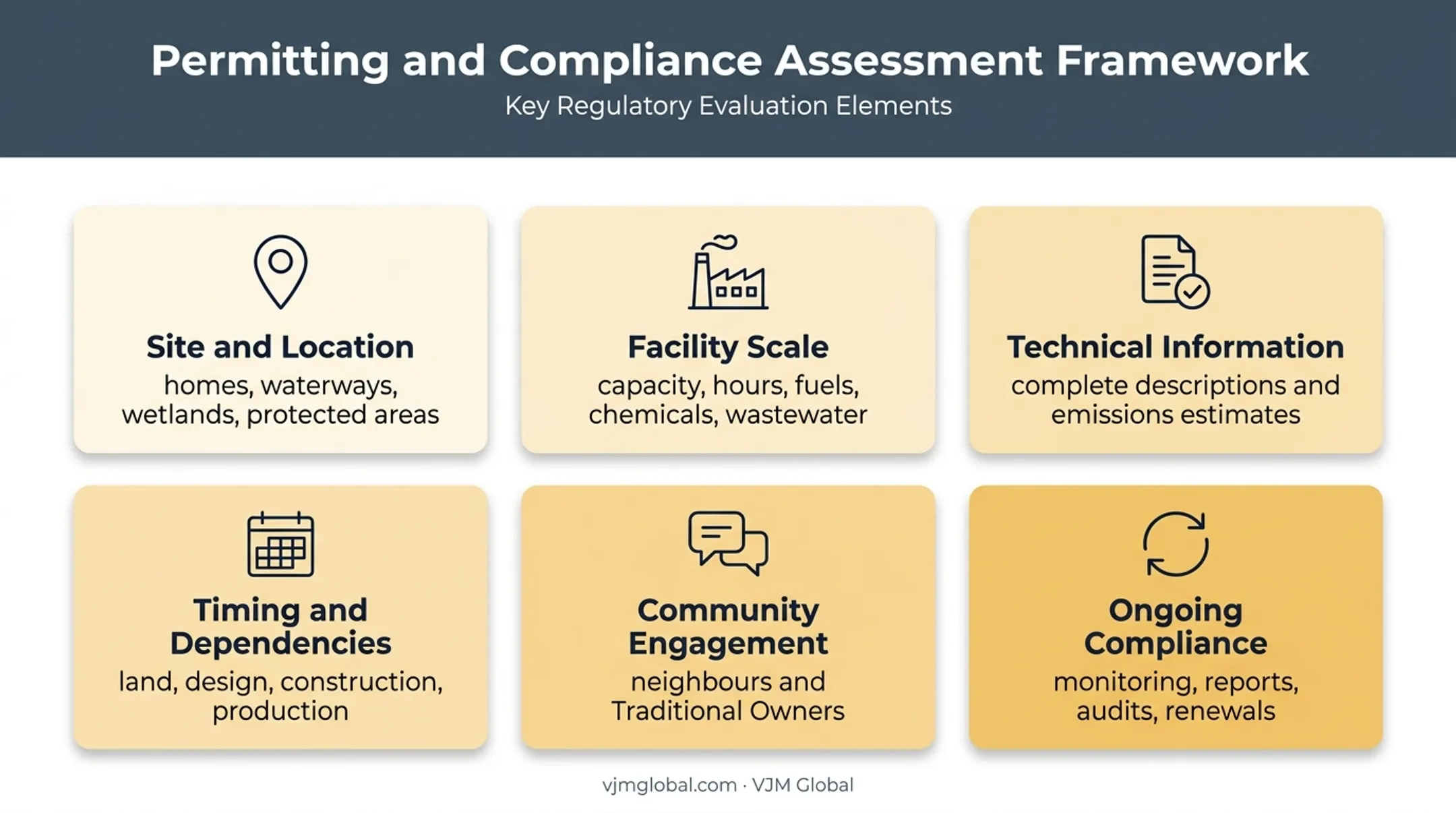

Six factors influencing manufacturing environmental approval complexity

Misconceptions Worth Correcting

A few assumptions cause real problems:

  • Planning approval is not the same as environmental permitting.
  • An approval is not necessarily permanent.
  • A consultant doesn't own compliance after approval. The facility operator does.
  • Minor equipment changes can still require notification.

Starting construction before the required approval, exceeding a permitted limit, or missing a report creates genuine enforcement risk, not just paperwork catch-up later.

When to Revisit Your Permit Strategy

Reassess the approach when the facility changes any of the following:

  • Site or production scale
  • Chemicals, discharge route, or emission source
  • Operating hours or waste profile

Also revisit when regulator feedback flags an impact that wasn't originally assessed. Adjusting the design or sequencing is usually better than forcing a project through a permit category it no longer fits.

If manufacturing expansion also means establishing an entity in India, run business setup and tax registration in parallel with your local environmental approvals. VJM Global supports Australian companies with the India-side entity formation, accounting, tax, and compliance coordination.

Technical environmental approvals in either country still require qualified environmental engineers or local permitting specialists. That work sits outside what any accounting or company-formation partner should advise on.

Conclusion

Obtaining environmental permits for a manufacturing facility comes down to a site- and activity-specific review of federal, state or territory, and local obligations, not a single form to lodge and forget. The most reliable approach starts during site selection:

  • Build a complete permit matrix
  • Prepare technically consistent applications
  • Assign clear ownership for every condition attached to approval

Environmental permitting doesn't end at the approval letter. It's an ongoing operational responsibility that follows the facility for its entire operating life.

Confirm current requirements directly with the relevant Australian authorities and qualified environmental specialists before committing to a site, a process, or a production target.

Frequently Asked Questions

What are the major environmental regulations in the USA?

U.S. requirements commonly include federal laws covering air, water, hazardous waste, solid waste, chemical emergency planning, and environmental review, alongside state and local rules. This isn't the default framework for an Australian facility.

What is the 40 CFR?

Title 40 of the U.S. Code of Federal Regulations contains many federal environmental rules, administered primarily by the U.S. EPA. Australian manufacturers should consult Australian federal, state or territory, and local legislation instead.

What environmental permits does a manufacturing facility need in Australia?

Requirements depend on the state or territory, site, processes, emissions, wastewater, waste, water use, and land sensitivity. Air, water, waste, planning, and development approvals are common screening categories.

Who issues environmental permits in Australia?

State or territory environmental regulators typically issue pollution licences and works or operating approvals. Local councils handle planning approvals. The Australian Government steps in where federally protected matters or other federal triggers apply.

When should a manufacturer apply for environmental approvals?

During feasibility and site selection, before construction, equipment commitments, or production changes. Studies, consultation, and regulator review can all affect project timing if left too late.

Do environmental permits need to be renewed or updated?

Yes. Permits can carry expiry dates, reporting cycles, and variation requirements triggered by changes to capacity, equipment, emissions, waste, chemicals, or discharge arrangements.
