Environmental Permitting Services in India: A Complete Guide Navigating the environmental permitting process in India can feel like a complex puzzle. It's not a single approval but a web of permissions, consents, and ongoing obligations that vary based on your project's nature, scale, and location. Many businesses, especially foreign investors, struggle with unclear approval routes, overlapping central and state authorities, and shifting requirements.

These challenges often lead to significant project delays, especially when environmental planning is treated as an afterthought to land acquisition or construction decisions. Incomplete documentation and a lack of foresight can turn a promising venture into a bureaucratic marathon.

This guide provides a clear roadmap. We will break down India's regulatory framework, explore the major types of approvals your project might need, and walk through the permitting process step-by-step. We'll also cover common risks, post-approval compliance, and how to coordinate environmental requirements with your broader India market entry strategy.

Key Takeaways

  • The required approvals depend on your project's type, scale, location, pollution potential, and specific activities.
  • Environmental Clearance (EC), Consent to Establish (CTE), and Consent to Operate (CTO) are distinct approvals and must be managed separately.
  • Begin your environmental approval planning during site selection and feasibility studies, well before committing to land, construction, or equipment.
  • Maintain a detailed approval matrix and compliance calendar to track applications, conditions, monitoring schedules, renewals, and reporting duties.

India’s Environmental Permitting Landscape

Environmental permitting in India means identifying legal obligations, preparing technical documents, securing approvals from the right authorities, and staying compliant over time. National and state laws sit on top of each other, so the pathway depends on both.

The primary legal frameworks that underpin this system include:

  • The Environment (Protection) Act, 1986: The umbrella legislation that empowers the central government to regulate activities that may harm the environment.
  • The Environmental Impact Assessment (EIA) Notification, 2006: Issued under the 1986 Act, this is the key regulation that mandates a prior Environmental Clearance (EC) for a schedule of specified projects and their expansions.
  • The Water (Prevention and Control of Pollution) Act, 1974: This act governs water pollution and requires industries to obtain consent before establishing or operating.
  • The Air (Prevention and Control of Pollution) Act, 1981: Similarly, this requires prior consent for industrial plants operating within designated air pollution control areas.

Key Regulatory Bodies

Navigating this landscape requires interacting with several authorities, each with a distinct role:

  • Ministry of Environment, Forest and Climate Change (MoEFCC): The central authority for appraising large-scale (Category A) projects requiring EC.
  • State Environment Impact Assessment Authorities (SEIAA): State-level bodies that grant EC for medium-scale (Category B) projects.
  • Central Pollution Control Board (CPCB): Coordinates national pollution control efforts and sets standards, particularly for waste management and Extended Producer Responsibility (EPR).
  • State Pollution Control Boards (SPCBs) / Pollution Control Committees (PCCs): The primary state-level agencies responsible for granting Consent to Establish (CTE) and Consent to Operate (CTO) and for conducting public hearings for the EC process.

State-specific rules, local development controls, and site conditions can change the approval pathway. Always check the latest requirements for the state where your project is located.

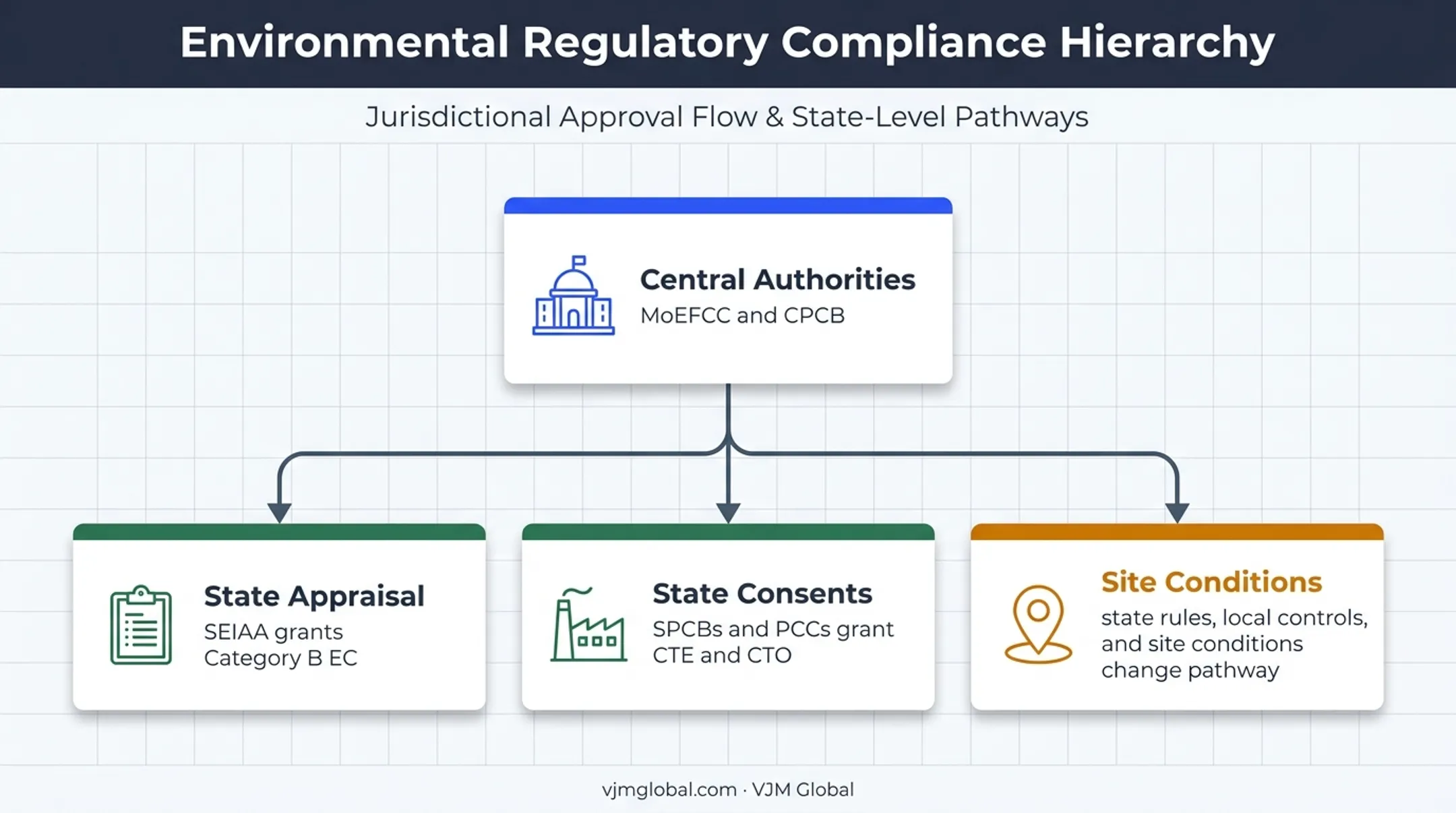

India environmental permitting authorities and regulatory framework hierarchy

Approvals usually fall into three stages:

  • Pre-project clearances such as Environmental Clearance (EC)
  • Permissions tied to construction
  • Operational consents (CTE/CTO) that need ongoing compliance and renewal

Types of Environmental Approvals a Project May Need

The specific permits your project needs are not one-size-fits-all. They are triggered by your industry, capacity, location, and potential environmental impact. Here are the main categories of approvals to investigate.

Environmental Clearance (EC)

Under the EIA Notification, 2006, certain projects listed in its Schedule require a prior EC before any construction work or land preparation can begin. The process depends on the project's classification:

  • Category A Projects: These are large-scale projects appraised by the MoEFCC at the central level.
  • Category B Projects: These are appraised by the SEIAA at the state level. They are further screened into:
    • Category B1: Requires a full EIA report and public consultation.
    • Category B2: Does not require an EIA report or public consultation but still needs prior appraisal and EC.

Consent to Establish (CTE) and Consent to Operate (CTO)

Governed by the Water and Air Acts, these are fundamental approvals managed by the state SPCBs/PCCs.

  • Consent to Establish (CTE): A prerequisite for setting up an industrial plant, detailing proposed pollution control measures and processes. Required before construction begins.
  • Consent to Operate (CTO): Granted after the SPCB inspects the facility and confirms compliance with CTE conditions. Required before commercial operations start, and valid for a fixed period before renewal.

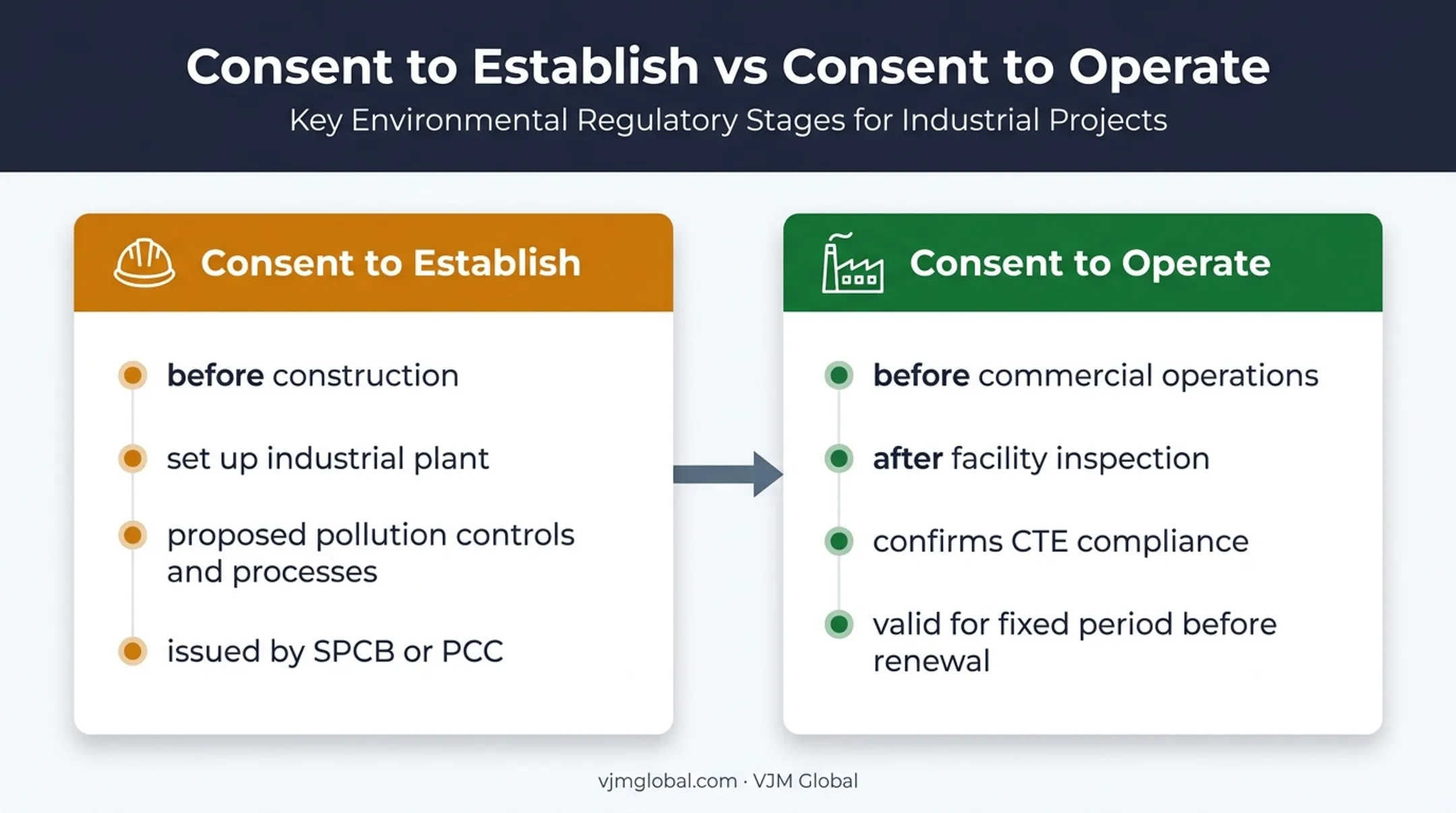

Consent to Establish versus Consent to Operate approval comparison

Site-Specific and Impact-Based Permissions

Your project's location and specific activities can trigger additional approvals. These are often overlooked but can cause significant delays. Key examples include:

  • Forest Clearance: If your project involves diverting forest land for non-forest use.
  • Wildlife Clearance: If the site is near a protected area like a national park or wildlife sanctuary.
  • Coastal Regulation Zone (CRZ) Clearance: For projects located in coastal areas, governed by the CRZ Notification, 2019.
  • Groundwater Extraction NOC: A No Objection Certificate (NOC) is needed from the Central Ground Water Authority (CGWA) or relevant state authority for industrial water use.
  • Other permissions: Depending on the site, you may also need approvals related to wetlands, tree felling, or local land use.

Waste and Material-Specific Obligations

India regulates several distinct waste streams, each under its own set of rules. Your business must identify which apply and secure the necessary authorisations or registrations. These are separate from EC and CTE/CTO.

  • Hazardous and Other Wastes: For handling, storage, treatment, and disposal.
  • Solid Waste: Bulk generators have specific duties for segregation and management under the Solid Waste Management Rules.
  • Plastic Waste: Producers, importers, and brand owners have EPR obligations.
  • Bio-medical Waste: Any facility generating this waste requires authorisation, regardless of quantity.
  • Construction and Demolition (C&D) Waste: Producers have EPR targets for recycling.
  • E-waste (Electronic Waste): Producers and recyclers must register on the CPCB's EPR portal.
  • Battery Waste: Producers and recyclers have specific registration and EPR duties.
  • Used Oil: Covered by EPR rules effective from 1 April 2024.

Step-by-Step Environmental Permitting Process in India

A structured approach is the best way to manage the environmental permitting process. Rushing applications without preparation leads to delays.

  1. Project Scoping and Data Collection: Gather detailed information about your project, including:

    • Legal entity, industry sector, products, capacity, and technology
    • Land details, construction schedule, and water balance
    • Potential sources of emissions, effluents, and waste
  2. Site and Feasibility Due Diligence: Complete this step before you commit to a site. Analyse proximity to protected areas, forests, water bodies, coastal zones, and settlements, then verify land-use zoning and constraints such as groundwater restrictions.

  3. Develop an Approval Matrix: Create a master document that maps every approval your project needs. For each item, list the authority, legal trigger, application form, technical documents, dependencies, timeline, and post-approval conditions. This matrix becomes your compliance dashboard.

  4. Prepare the Technical Package: Compile site plans, process flow diagrams, water and mass balances, pollution load estimates, waste management plans, and corporate records. Keep details consistent across all documents.

  5. Submit Applications and Manage Correspondence: File through the correct channels, such as the central government's PARIVESH portal for EC or state SPCB portals for consents. Track status, respond promptly to queries, and keep a version-controlled record of submissions and communications.

  6. Operationalise Post-Approval Conditions: Convert conditions from your EC, CTE, and CTO into operational controls. Assign owners, schedule monitoring and sampling, maintain records, submit mandatory returns on time, and plan renewals.

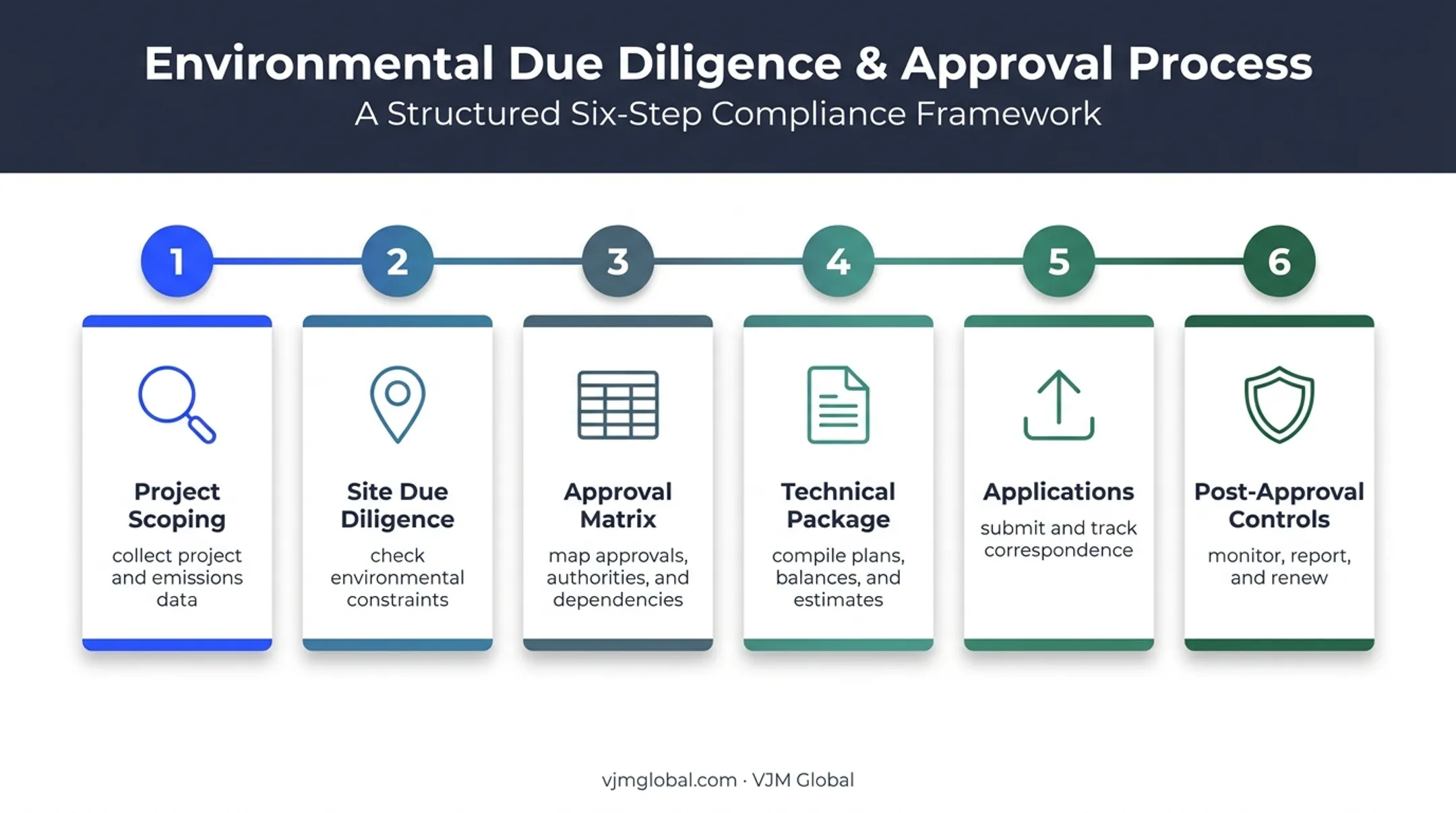

Six-step environmental permitting process in India from scoping to compliance

Common Project Risks and How to Plan Around Them

Even with careful planning, projects can face hurdles. Understanding these common risks allows you to build contingencies into your project plan.

Site Selection without Environmental Due Diligence

Choosing a site based solely on commercial factors without checking for environmental constraints is a major pitfall. This can lead to expensive redesigns, land-use conflicts, or even project cancellation if a fatal flaw—like being too close to a protected zone—is discovered late in the process. An early fatal-flaw analysis before site commitment is essential.

Weak or Inconsistent Application Documents

Regulators frequently reject or delay applications due to poor-quality documentation. Common weaknesses include:

  • Inconsistent capacity figures across application forms
  • Incomplete land records
  • Unsupported pollution estimates
  • Discrepancies between engineering drawings and environmental management plans

A Kerala State Expert Appraisal Committee (SEAC) case shows the cost of this gap: the committee recently deferred a quarry proposal, requesting updated hazard-zonation information and other visual evidence before it could proceed. An incomplete file simply stops the clock.

Unrealistic Timelines and Dependencies

Project schedules often fail to account for the realities of the approval process. Public consultations, local objections, inter-departmental queries, and site inspections can all add time. Build realistic contingencies into your timeline rather than assuming a best-case scenario. Promising a fixed approval date is a recipe for failure.

Post-Approval Non-Compliance

The biggest risks often emerge after operations begin. Operating without a valid CTO, failing to comply with approval conditions, or exceeding approved capacity can lead to severe consequences, including closure directions.

The Maharashtra Pollution Control Board (MPCB), for example, issued a closure direction to a service station for operating without consent and discharging untreated effluent. Compliance monitoring continues long after approval, and regulators enforce conditions aggressively.

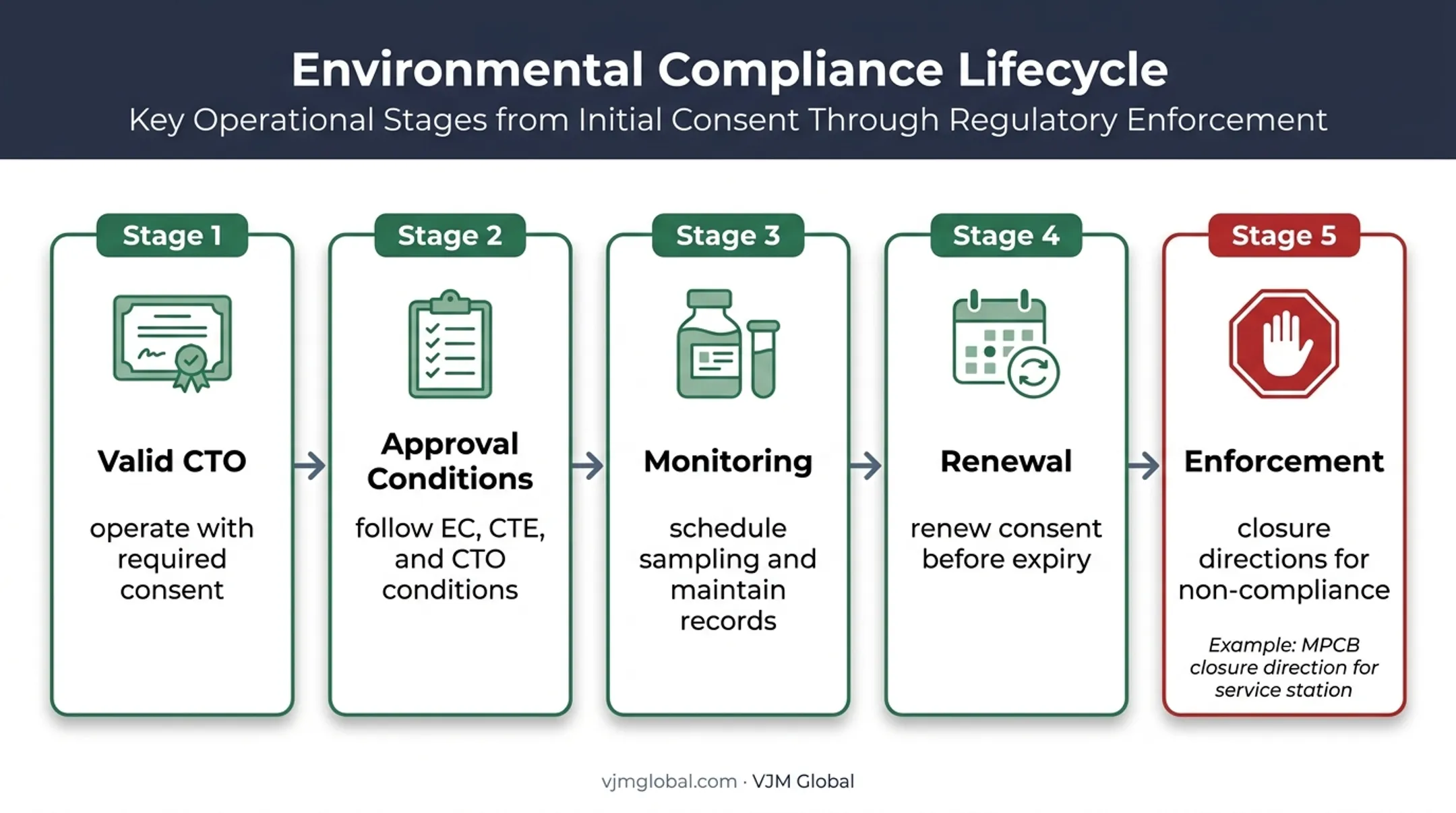

Post-approval environmental compliance monitoring and enforcement lifecycle

When to Engage Professional Environmental and India Compliance Support

Navigating India's complex environmental and business regulations requires specialised expertise. Engaging professional support is most effective when done early—during site selection, feasibility, and project design—not just when an application gets stuck.

When selecting an advisor, look for:

  • Deep knowledge of your project's sector and the specific state's regulations.
  • Proven ability to coordinate between technical, legal, and business compliance teams.
  • Familiarity with online portals like PARIVESH and the workings of local authorities.
  • A transparent scope of work and fee structure.
  • Strong document control and quality check processes.

For foreign companies, coordinating environmental approvals with the broader challenges of India market entry is crucial. A partner with hands-on compliance experience can make that coordination far smoother.

At VJM Global, our expertise in business setup, tax, accounting, and corporate governance helps foreign investors, multinational companies, and entrepreneurs establish a compliant foundation in India.

While qualified specialists should handle the technical side of environmental applications, we ensure your project's business structure and corporate compliance align with your operational goals.

We assist with everything from entity formation and location selection to post-incorporation accounting, tax, and audit support, so you can manage your India venture with confidence.

If you are planning a project in India, map your environmental and business compliance requirements early. Contact VJM Global today to confirm the support you need for a successful market entry and sustainable operation.

Frequently Asked Questions

What is environmental permitting in India?

Environmental permitting is the process of obtaining all necessary approvals, consents, and registrations from central, state, and local authorities for any activity that may impact the environment. Requirements are highly dependent on the project's specifics and location.

Is environmental clearance mandatory for every project in India?

No, it is not. Environmental Clearance (EC) is mandatory only for specific project categories and activities listed in the EIA Notification, 2006. Project-specific verification is essential to determine if your activity triggers the need for an EC.

What is the difference between environmental clearance and Consent to Establish?

Environmental Clearance is an appraisal of a project's potential environmental impacts, required before any site work begins for scheduled projects. Consent to Establish is a pollution-control permit from the State Pollution Control Board to set up an industrial unit. They are separate approvals, and one does not replace the other.

Which authorities issue environmental approvals in India?

The MoEFCC, State Environment Impact Assessment Authorities (SEIAA), State Pollution Control Boards (SPCBs), and specialised authorities for forests, wildlife, groundwater, and coastal zones issue these approvals.

What documents are generally required for environmental permits in India?

A typical application package includes corporate records, land documents, site plans, process details, water balance, waste management plans, and other technical studies. The exact list varies significantly based on the type of approval and the project.

How long does environmental permitting take in India?

There is no universal timeline. The duration depends on the approval type, project category, state, quality of documentation, and the speed of regulatory responses. Plan with contingencies rather than a fixed average.
