This guide is written for UK plant owners, operators, developers, contractors, and overseas businesses planning construction operations in the UK. Getting permitting wrong isn't just a paperwork problem. Unpermitted operation can mean fines, enforcement notices, and forced shutdowns, as one Oxfordshire operator recently found out.
The term "environmental permit" gets used loosely across the construction sector, often to describe anything from a waste exemption to a full installation permit. That looseness causes real confusion. This article breaks down which regimes actually apply to concrete batching, how the application process works, what operators must do after approval, and where most people get tripped up.
Key Takeaways
- Batching plants often need air, waste, water discharge or abstraction permissions based on activity and location
- Planning permission and environmental permitting are separate—one does not secure the other
- England and Wales use the Environmental Permitting Regulations 2016; Scotland and Northern Ireland use different frameworks
- Compliance continues after approval via monitoring, record-keeping and reporting for the plant’s operating life
What Is a Concrete Batching Plant Environmental Permit?
What counts as an environmental permit
An environmental permit is a legal authorisation that sets conditions on a specific activity carried out at a specific site. It exists to control:
- Dust and particulate emissions from cement handling and aggregate storage
- Contaminated runoff and wash water reaching drains or watercourses
- Waste handling of returned concrete, washout solids, and packaging
- Noise and odour nuisance affecting neighbouring properties
For England and Wales, the governing framework is the Environmental Permitting (England and Wales) Regulations 2016 (SI 2016/1154). Under Schedule 1, bulk cement blending and ready-mixed concrete batching carried out away from a construction site is a Part B activity.
That means the local authority, not the Environment Agency, handles the air-emissions permit. Check the current schedule before applying. Amendments happen regularly.
The permissions that might apply
No two plants need the exact same combination. Depending on what the site actually does, you might need:
- An environmental permit for a regulated installation or waste activity, where the specific process falls within the applicable regime
- A water discharge or trade effluent consent, where contaminated water goes to a watercourse or sewer
- An abstraction licence, where water is drawn from a river, borehole, or other source
- A waste exemption or separate waste permit, where returned concrete, wash water, or other waste materials are stored, treated, or disposed of

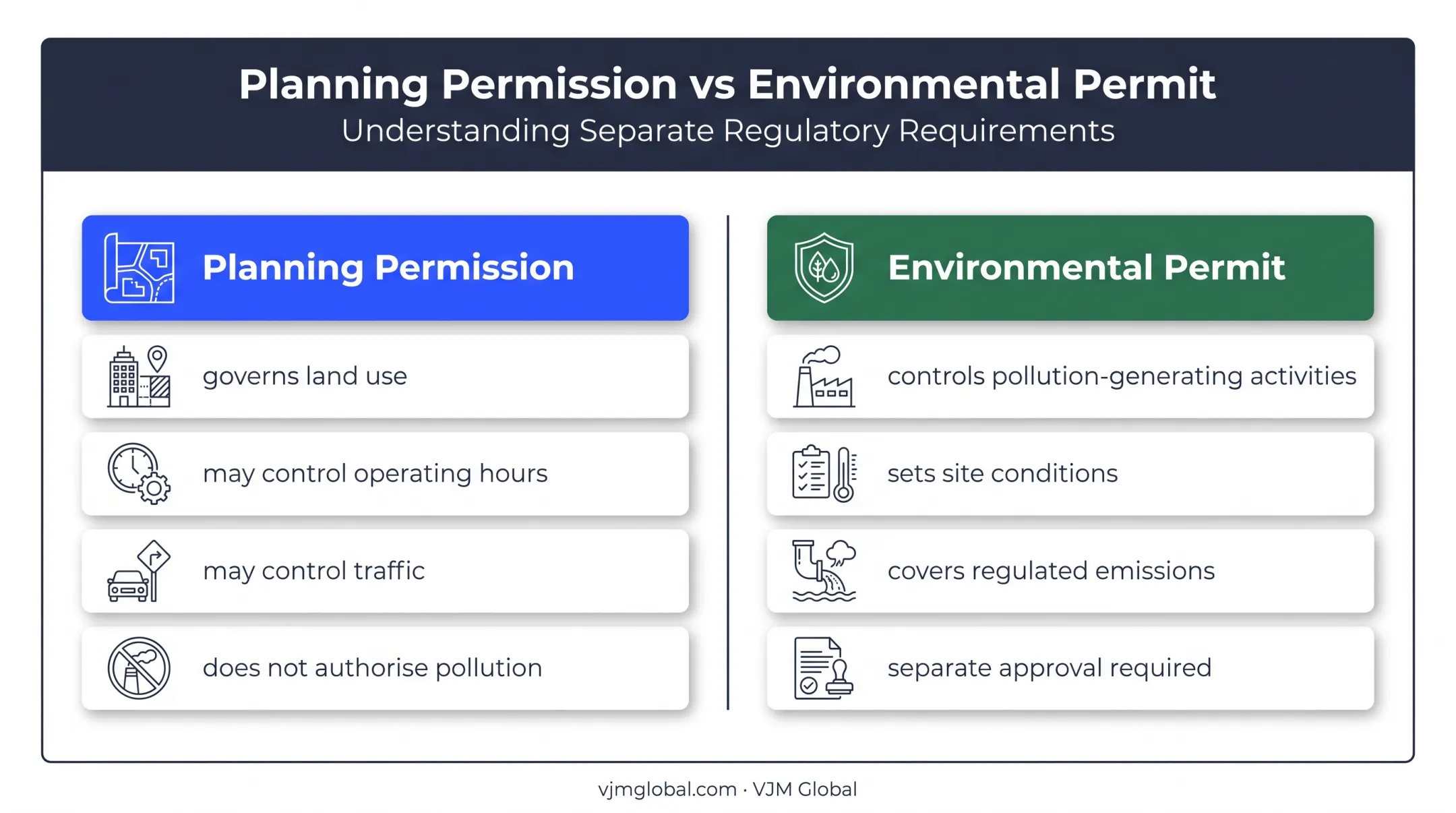

Permit vs. planning vs. everything else
An environmental permit is not planning permission, building control sign-off, or a waste carrier's licence. Each addresses a different risk.
Planning permission governs land use and might include conditions on operating hours or traffic, but it does not authorise pollution-generating activities. A site can hold full planning consent and still be operating illegally without the correct permit.

It depends which UK nation you're in
The regulator, and the rules, change across the UK:
| Nation | Who handles batching-related permits |
|---|---|
| England | Local authority (Part B); Environment Agency for waste and water |
| Wales | Local authority (Part B); Natural Resources Wales for waste and water |
| Scotland | SEPA, under a separate EASR registration, not a Part B permit |
| Northern Ireland | District council or NIEA, depending on activity classification |
Confirm current guidance for the nation where the plant actually operates. Don't assume England's rules transfer directly to Wales, Scotland, or Northern Ireland.

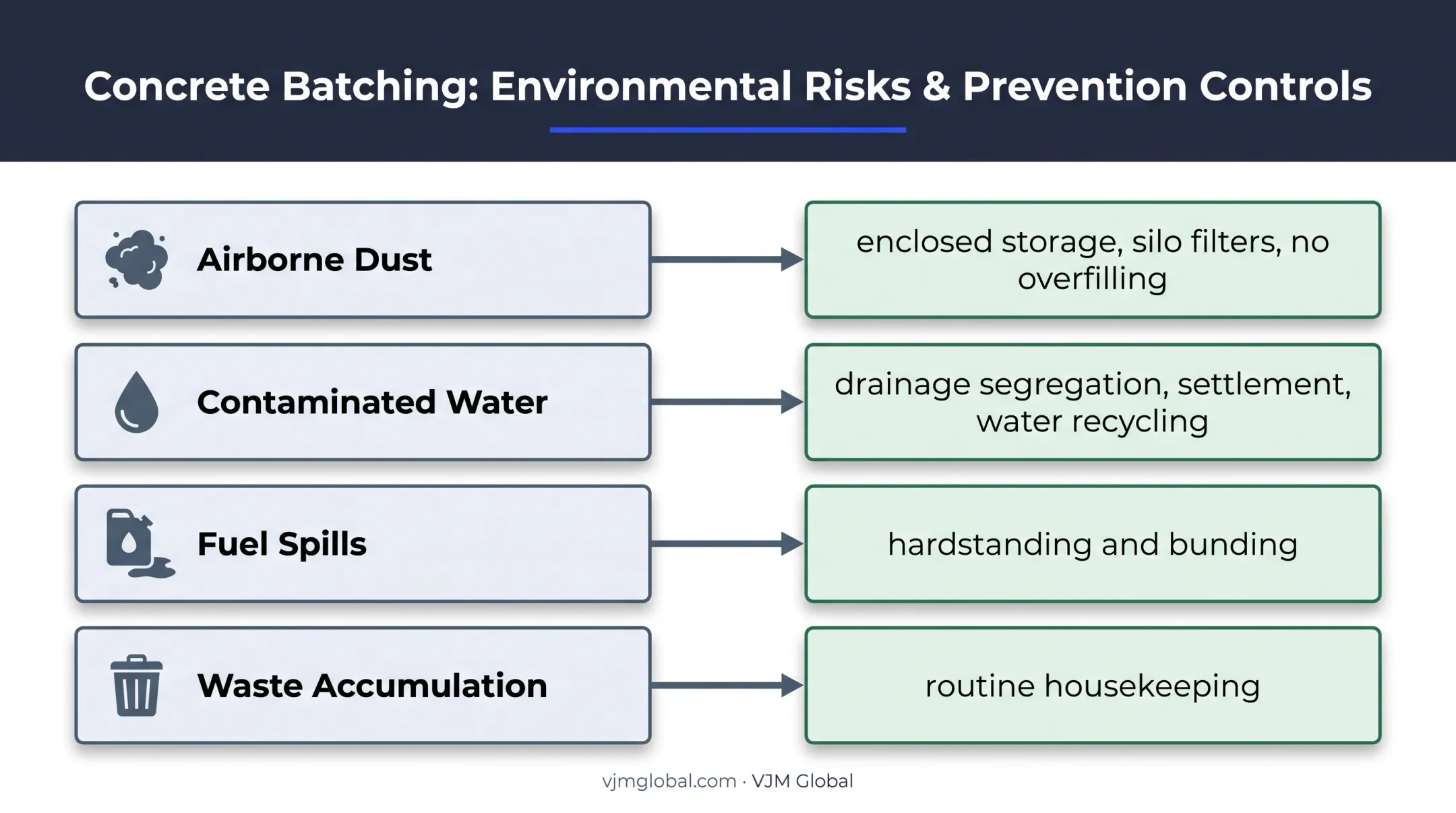

Why Environmental Permitting Is Used for Concrete Batching Plants
Batching plants create environmental risk at almost every stage, not just during mixing.
Where the risk actually comes from
- Aggregate and cement storage: wind-blown dust from stockpiles and silos
- Silo filling: pressure venting that can release fine particulates
- Vehicle movements: tracked-out mud and dust on access roads
- Mixing and washout: alkaline wash water with a pH that can harm aquatic life
- Fuel and chemical storage: spill risk from admixtures, diesel, and hydraulic oil
- Returned or waste concrete: accumulation that counts as controlled waste if mismanaged
Each of these feeds into pollution pathways regulators focus on: airborne dust, contaminated surface water, spills, waste accumulation, noise, and nuisance from traffic or operating hours.
Why regulators ask for specific controls
Permits typically require pollution-prevention measures matched to these risks:
- Enclosed transfer points and silo filtration
- Hardstanding and bunding around fuel tanks
- Drainage segregation, settlement systems, and water recycling
- Routine housekeeping
None of this is arbitrary. It reflects years of enforcement experience showing exactly where batching plants cause harm.
Defra's own process guidance on cement handling identifies particulate matter as the principal pollutant from this type of operation, pointing to enclosed storage, silo filters, and controls on silo overfilling as standard expectations.

Don't assume size or duration makes you exempt
This is where operators get caught out. A plant being small, temporary, or mobile does not automatically exempt it from permitting. The Schedule 1 classification for bulk cement use applies regardless of how long the plant stays on site.
What matters is the activity, not the calendar. A mobile plant brought in for a few months still needs proper screening against current regulations, not an assumption carried over from a previous job.
Permitting is sometimes a hard legal requirement, sometimes a sensible precaution even where no permit is strictly triggered, and sometimes secondary to another controlling authorisation, such as a trade effluent consent from the local water company. Treat every site on its own facts.
How the Environmental Permitting Process Works
Permitting isn't a single form. It's a sequence of decisions that starts well before you contact a regulator.
The process, step by step
Build an activity and site profile. Document plant type, fixed or mobile status, production capacity, cement and aggregate storage, waste inputs, wash-water handling, discharge routes, nearby receptors, and planned operating hours. Use your regulator's screening tool where one exists.
Determine the correct authorisation route. Work out whether the activity is an installation, waste operation, water discharge, abstraction, or some combination. Then check whether a standard-rules permit fits (faster, fixed conditions) or whether you need a bespoke application (slower, tailored conditions). Eligibility criteria change, so verify current terms before relying on them.
Prepare supporting information. Most applications need:
- Site plans and process descriptions
- Drainage plans showing clean and contaminated water separation
- Emissions and pollution-control measures
- Waste handling procedures
- An environmental risk assessment
- Monitoring proposals and an accident-management plan
- Evidence of technical competence, where the regime requires it
Expect a risk-based assessment, not a paperwork tick-box. Regulators assess:
- Environmental risk and compliance with relevant technical standards
- Proximity to sensitive receptors such as homes or watercourses
- Suitability of proposed controls
- Whether the application is complete
Incomplete submissions get bounced back, which costs time. Confirm current fees, consultation requirements, and determination timescales directly with the regulator, as these vary by nation.
- Treat approval as the start, not the finish. Once granted, operators must:
- Follow permit conditions and maintain pollution-control equipment
- Keep monitoring and inspection records
- Report incidents promptly and retain documentation
- Notify the regulator of operational changes
- Apply for variations where the activity changes materially
- Surrender or transfer the permit correctly if operations end or ownership changes
Before you contact the regulator
Have these ready:
- A clear description of what the plant actually does, day to day
- Site plans showing drainage, storage, and discharge points
- A list of materials handled, including anything classed as waste
- Details of nearby watercourses, homes, or protected land
- Proposed pollution-control measures
This isn't exhaustive, and it won't guarantee approval on its own. Site-specific risks always shape what a regulator actually asks for.
Key Factors That Affect Permit Requirements and Compliance
Where permitting issues surface
Permitting questions can arise at several points in a plant's life: initial site development, plant installation, routine batching, equipment maintenance, washout, handling returned concrete, waste storage or treatment, and eventual site closure.
The scenarios that most often need separate consideration:
- A fixed plant with dust-generating storage, transfer, or production activity
- A mobile or temporary plant operating at a construction site, quarry, or development
- A plant storing, treating, or disposing of wash water or waste concrete
- A plant discharging water to a watercourse, sewer, or land
- A plant using fuels or chemicals that add storage and spill risk
Plant configuration, throughput, location, duration, nearby water bodies, and waste arrangements all shift what's actually required. There's no single universal answer. A large fixed plant next to a river faces different questions than a mobile unit on a six-week job inland.
Factors that drive requirements
| Factor | What to check |
|---|---|
| UK nation and regulator | Confirm whether the site is in England, Wales, Scotland, or Northern Ireland |
| Activity classification | Installation, waste activity, water discharge, abstraction, or combination |
| Materials and inputs | Cement, aggregates, admixtures, fuels, returned concrete, wash water |
| Emissions and operating conditions | Dust sources, silo filling, vehicle movements, operating hours |
| Site and environmental receptors | Nearby homes, watercourses, groundwater, protected sites |
| Drainage and water management | Segregating clean and contaminated water, pH monitoring |
| Waste controls | Classification, storage, transfer documentation, disposal routes |
| Compliance systems | Written procedures, staff training, inspection logs, incident plans |
Wash water needs particular attention
England's RPS 287 sets out when the Environment Agency will normally refrain from enforcement over storing, treating, and using waste water containing concrete on a construction site, provided you meet its conditions:
- Secure containment with 10% freeboard
- No more than 30 cubic metres per location
- pH monitoring before reuse
It does not remove the underlying permit requirement; it only describes when enforcement is unlikely if you follow it precisely. It applies in England only, was published in 2024, and is due for review by mid-2027. Check its current status before relying on it.
Common Issues and Misconceptions
Where operators get it wrong
Four assumptions drive most enforcement cases:
- "Every batching plant needs the same permit." Wrong. Requirements depend on the specific activity, location, and nation. A fixed installation and a mobile plant on a short job can face entirely different rules.
- "Planning permission covers it." It doesn't. Planning and environmental permitting address different risks and sit with different authorities.
- "No visible dust means we're compliant." Not necessarily. Conditions also cover drainage, record-keeping, waste documentation, and monitoring—issues that often stay hidden until inspection.
- "A permit works like a business licence." It doesn't. A permit authorises a defined activity at a defined site, subject to specific conditions, not a blanket approval to operate.
One real example: Cherwell District Council reported that Cooper Mixer Hire Limited, trading as Cherwell Concrete, pleaded guilty to operating without an environmental permit, resulting in a £6,000 fine and roughly £40,000 in costs and confiscated funds.
The case centred on the missing permit itself, not a proven pollution incident. The paperwork gap alone was enough to trigger enforcement.
When an exemption might apply, and when it won't help
Some activities qualify for an exemption or regulatory position statement instead of a full permit, but never assume this without checking current conditions against your exact site. Situations that usually need fresh confirmation include:
- A change in plant capacity or throughput
- A new water discharge route
- Use of waste materials as input
- Relocating a mobile plant to a new site
- Extended operating hours
- A change in site ownership
An exemption doesn't remove your duty to prevent pollution, and it won't authorise unrelated activities like uncontrolled discharge or dust nuisance. If in doubt, confirm directly with the regulator rather than relying on what worked at a previous site.
Conclusion
Whether a UK concrete batching plant needs an environmental permit depends on what it does, where it sits, what it stores or discharges, and which UK nation's rules apply. There's no single answer that covers every site.
Treat environmental permits, planning permission, water consents, and waste requirements as separate pieces that need separate checking, not one interchangeable approval. Get this wrong and the cost isn't just a fine. It's lost production time sorting out an application that should have been in place from day one.
Before construction or operation begins, check current regulator guidance and get advice from a suitably qualified UK environmental permitting professional.
If you're an overseas business setting up a construction operation in the UK, the environmental permit is only one part of the compliance picture, alongside entity formation, tax registration, and payroll. VJM Global supports international businesses with that wider setup and compliance work, though the environmental permit itself should always sit with a specialist in that field.
Frequently Asked Questions
What do the Environmental Permitting Regulations 2016 cover?
The Environmental Permitting (England and Wales) Regulations 2016 set the framework for authorising activities that could cause pollution, including certain concrete batching operations. Your exact permit route depends on the activity, so check current official guidance before applying.
What is a pollution permit?
A pollution permit is an authorisation controlling a specific activity that could cause environmental harm, such as dust emissions or contaminated discharge. It's distinct from planning permission and general business licensing, which cover different legal requirements.
Does a concrete batching plant need an environmental permit in the UK?
It depends on the plant's activity, emissions, waste handling, discharges, location, and which UK nation it's in. Check with the relevant regulator, whether that's a local authority, the Environment Agency, SEPA, or NIEA, before operating.
Is planning permission the same as an environmental permit for a concrete batching plant?
No. Planning permission addresses land use, while environmental permitting addresses regulated pollution or waste activities. Many sites need both approvals, secured independently through different processes.
How should concrete batching plant wash water be managed?
Contain wash water securely, treat or reuse it where suitable, and prevent uncontrolled discharge, with pH monitoring where required. Confirm whether a permit, exemption, consent, or current regulatory position statement applies to your site.
