If you're planning a waste facility, industrial installation, or anything involving emissions or discharges, you're probably asking a few core questions: Do I even need this? Which route applies? What evidence will the regulator want? How much will it cost, and how long will it take?
This guide walks UK applicants through the entire bespoke permit journey, from working out whether you need one, through preparing technical evidence, to budgeting realistically and staying compliant after approval. Requirements differ across England, Wales, Scotland and Northern Ireland, so we'll flag those differences throughout.
Key Takeaways
- Bespoke permits are written for your specific site and activity, not pulled from a standard template
- Pick bespoke, standard rules or exemption based on activity, scale, location and receptors—not price
- Build evidence around your activity: risk assessments, management plans and, where needed, BAT comparisons
- Determination periods often run three to four months, but incomplete applications restart the clock
- UK regulators differ by country: EA, NRW, SEPA and NIEA each run separate systems
What Is a Bespoke Environmental Permit and When Is It Required?
A bespoke environmental permit is issued under the UK's environmental permitting framework when a regulator writes conditions specifically for your activity, installation and site.
A standard rules permit, by contrast, applies a fixed set of published conditions to activities meeting a pre-defined description. The applicant can't negotiate or vary those rules.
According to GOV.UK's guidance on checking permit requirements, selecting the wrong route is a common reason applications stall. You'll typically need the bespoke route when:
- No standard rules permit covers your activity
- Your throughput, scale or capacity exceeds standard limits
- You handle unusual waste streams or emissions
- Your site sits near homes, watercourses, or protected habitats
- Your site-specific risks need tailored monitoring or controls
Activities That Commonly Require Permitting
Regulated activities span several categories, including:
- Waste operations (treatment, storage, transfer, landfill)
- Industrial emissions installations (manufacturing, energy generation)
- Water and groundwater discharges
- Mining and extractive operations
- Combustion plants and specified generators
Always verify the precise classification against current regulator guidance. Activity definitions get updated, and misclassifying your operation carries real enforcement risk.
When a Bespoke Permit Isn't the Answer
Not every environmentally relevant activity needs this route. Alternatives include:
- Exemptions for registered, lower-risk activities
- Standard rules permits where activities meet published criteria
- Regulatory position statements for specified circumstances where no permit is required
- Discharge consents for certain water-related activities
Planning permission or building control sign-off doesn't replace an environmental permit. They're separate legal processes serving different purposes.
Example: A composting site might initially look eligible for a standard rules permit. But if it sits within a few hundred metres of residential housing or near a protected watercourse, the regulator may require bespoke conditions to manage odour, bioaerosol or drainage risks that standard rules simply don't address.
England, Wales, Scotland and Northern Ireland each run separate frameworks. Scotland's EASR system and Northern Ireland's licensing regimes don't use the same bespoke-versus-standard-rules split as England and Wales, so confirm the applicable regime before assuming terminology carries across borders.
Choosing the Correct Permit Route Before You Apply
| Route | Flexibility | Evidence required | Regulator scrutiny | Risk if wrong |
|---|---|---|---|---|
| Exemption | None (fixed criteria) | Registration only | Low | Illegal operation if criteria not met |
| Standard rules | None (rules fixed) | Moderate | Moderate | Breach if site doesn't match description |
| Bespoke | High (tailored) | Extensive | High | Delays if evidence incomplete |
A standard rules permit looks like the cheaper, faster option. It only works, though, if your activity meets every published condition and location restriction, not most of them. Miss one criterion (distance to housing, groundwater vulnerability, waste type) and you're in bespoke territory whether you planned for it or not.
Do Your Homework Before Committing to a Site
Before finalising your process design or signing a lease, review:
- Current regulator guidance for your specific activity
- Permit-sector guidance documents
- Maps of nearby sensitive receptors (housing, habitats, water sources)
- Records of protected species or designated sites nearby
This early review often reveals constraints that reshape your site choice or operating design before you've spent money on formal assessments.
When to Seek Pre-Application Advice
Pre-application engagement is worth the time for:
- Novel or unusual activities without clear precedent
- Complex emissions profiles
- Sites near sensitive receptors
- Projects where classification itself is uncertain
Informal discussions with EA, NRW, SEPA or NIEA can flag obvious problems early. They're not approval, though, and they're not a substitute for a complete, evidence-backed application. Treat pre-application advice as a sense check, not a guarantee.
How to Prepare and Submit a Bespoke Environmental Permit Application

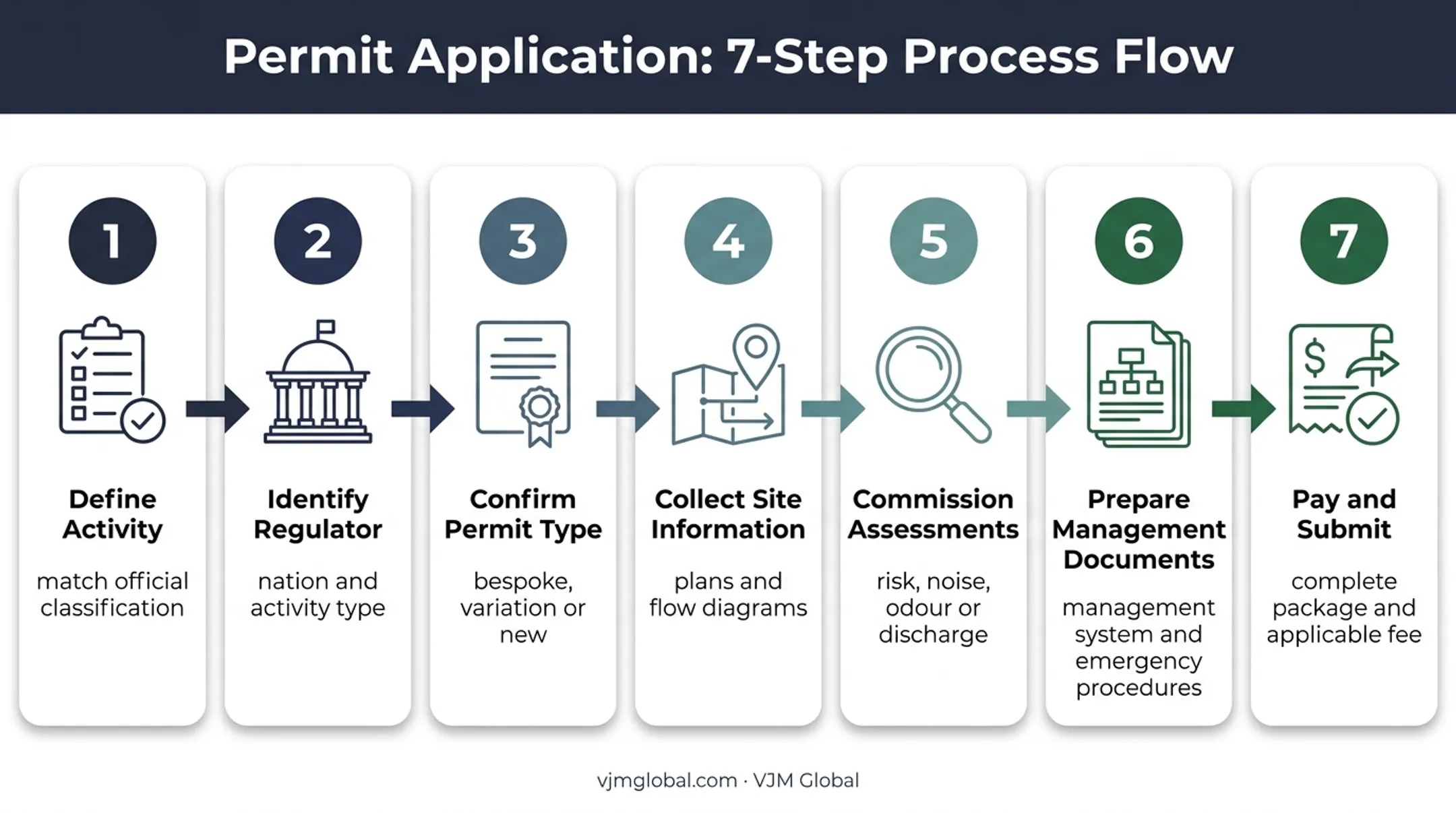

The application sequence generally follows this order:
- Define the regulated activity precisely, matching official classification
- Identify the correct regulator for your nation and activity type
- Confirm the permit type (bespoke, variation, or new)
- Collect site and process information, including plans and flow diagrams
- Commission assessments: risk, noise, odour, or discharge modelling as needed
- Prepare management documents: environmental management system, emergency procedures
- Pay the applicable fee and submit the complete package

What the Regulator Needs to See
Your core project description should cover:
- Site ownership or control evidence
- Site plans and operating boundaries
- Process flow and plant or equipment details
- Materials and waste types handled
- Storage arrangements and operating hours
- Maximum proposed capacities
Building a Risk-Based Case
Regulators assess applications using the source-pathway-receptor model. For each potential pollution source, identify:
- Pathway: how it could travel (air, water, land)
- Receptor: who or what could be affected (people, habitats, watercourses)
- Controls: measures that reduce that risk
Alongside the technical assessment, a clear non-technical summary matters more than applicants often realise. Written in plain language, it explains the activity, principal risks and proposed controls for consultees and affected communities who won't read the full technical submission.
Quality Checks Before You Submit
Before submission, confirm:
- Forms, maps, calculations and assessments tell a consistent story
- Management plans match the actual proposed operation
- Ownership information and fees are correct and complete
Your application only starts its statutory clock once the regulator accepts it as "duly made," meaning all required information and payment have been received. An incomplete submission doesn't start the countdown; it just delays you.
Ask yourself before hitting submit:
- Is the activity correctly classified?
- Are limits and capacities internally consistent across every document?
- Have all sensitive receptors been considered?
- Can every proposed control actually be operated and monitored in practice?
Research current application forms, submission portals, fee schedules and guidance directly from your regulator, rather than relying on older third-party instructions, since portals and forms change periodically.
Technical Evidence and Supporting Documents the Regulator May Require
Supporting documents depend entirely on your activity and site. Not every item below applies to every application.
Foundation Documents
Most bespoke applications include:
- Site plan and, where relevant, a site condition or baseline report
- Technical description of the process
- Environmental management system or management plan
- Accident and emergency procedures
- Monitoring arrangements
- Restoration or surrender information, where applicable
Environmental Risk Assessments
EA guidance on risk assessments confirms that a bespoke application generally requires an environmental risk assessment. It should address sources, pathways, receptors and controls, unless the regulator prepares that assessment. Depending on your activity, this might cover:
- Air emissions and dispersion
- Water and groundwater discharges
- Noise and vibration
- Odour, dust and bioaerosols
- Traffic-related impacts and human health
Generic, copy-pasted assessments are an easy regulator red flag. Reflect your actual site, actual emissions and actual nearby receptors, not a template someone used on a different project.
Activity-Specific Evidence
Depending on your sector, expect additional requests such as:
- Fire prevention plans for sites handling combustible waste
- Odour management plans and bioaerosol assessments
- Water discharge, drainage and containment designs
- Emissions and dispersion modelling
- Noise assessments
- Best Available Techniques (BAT) comparisons for industrial installations

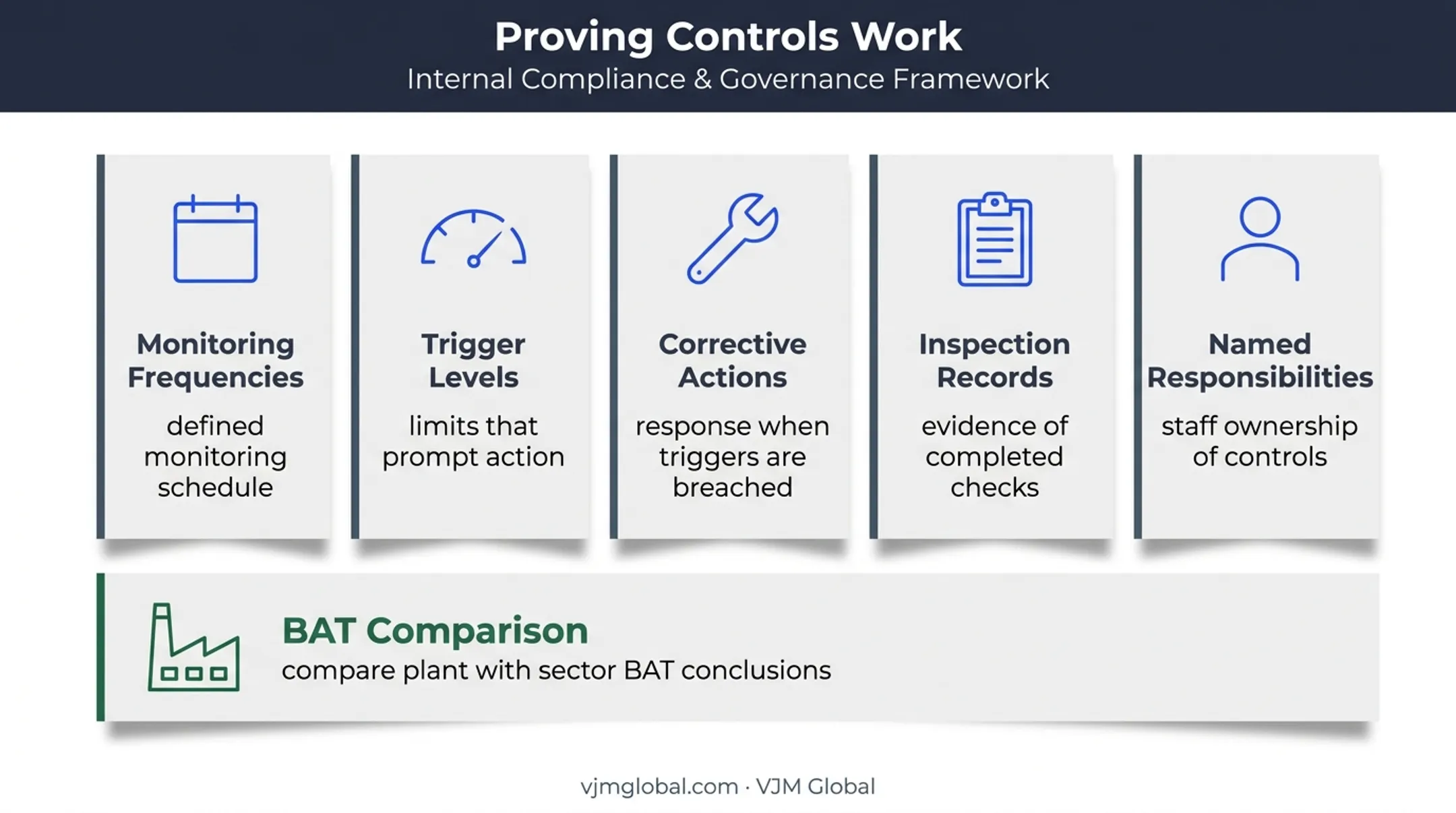

Proving Your Controls Actually Work
Listing controls isn't enough. You need to show they're effective, maintainable and proportionate:
- Monitoring frequencies and trigger levels
- Corrective actions when triggers are breached
- Inspection records
- Named staff responsibilities
For industrial installations, explain how your proposed plant compares against sector-specific BAT conclusions. The regulator expects this comparison, not just a statement that you'll "meet BAT."

Common reasons for regulator questions and delays include:
- Unsupported assumptions
- Inconsistent capacity figures across documents
- Missing receptor information
- Management plans copied from another site
Internal consistency across every submitted document matters as much as the technical content itself.
Costs, Fees and Timescales for a Bespoke Permit
The regulator's application fee is only one line in your budget. The fuller picture often includes:
- Site surveys and laboratory testing
- Modelling (air dispersion, noise, odour)
- Specialist assessments and consultation support
- Legal or technical review
- Monitoring equipment
- Application preparation time
Ongoing Costs After Approval
Approval isn't the end of the spend. Depending on your permit type, you may also face:
- Annual subsistence charges
- Monitoring and reporting costs
- Maintenance and audit expenses
- Fees for variations, transfers or surrender
Verify which charges apply to your permit type with the regulator. Fee schedules update annually and vary by activity category.
Costs can't be responsibly estimated from the activity name alone. Bespoke permit fees can range from a few hundred pounds for simpler activities to tens of thousands of pounds for complex industrial installations.
What drives the total:
- Complexity and project scale
- Site sensitivity and emissions profile
- Required studies and specialist input
- Further information requests during determination
For businesses setting up new UK operations, permit costs should sit alongside entity formation, payroll and tax registration in the same budget. VJM Global supports foreign investors with that multi-workstream planning, so regulatory and compliance costs are timed against the rest of the project.

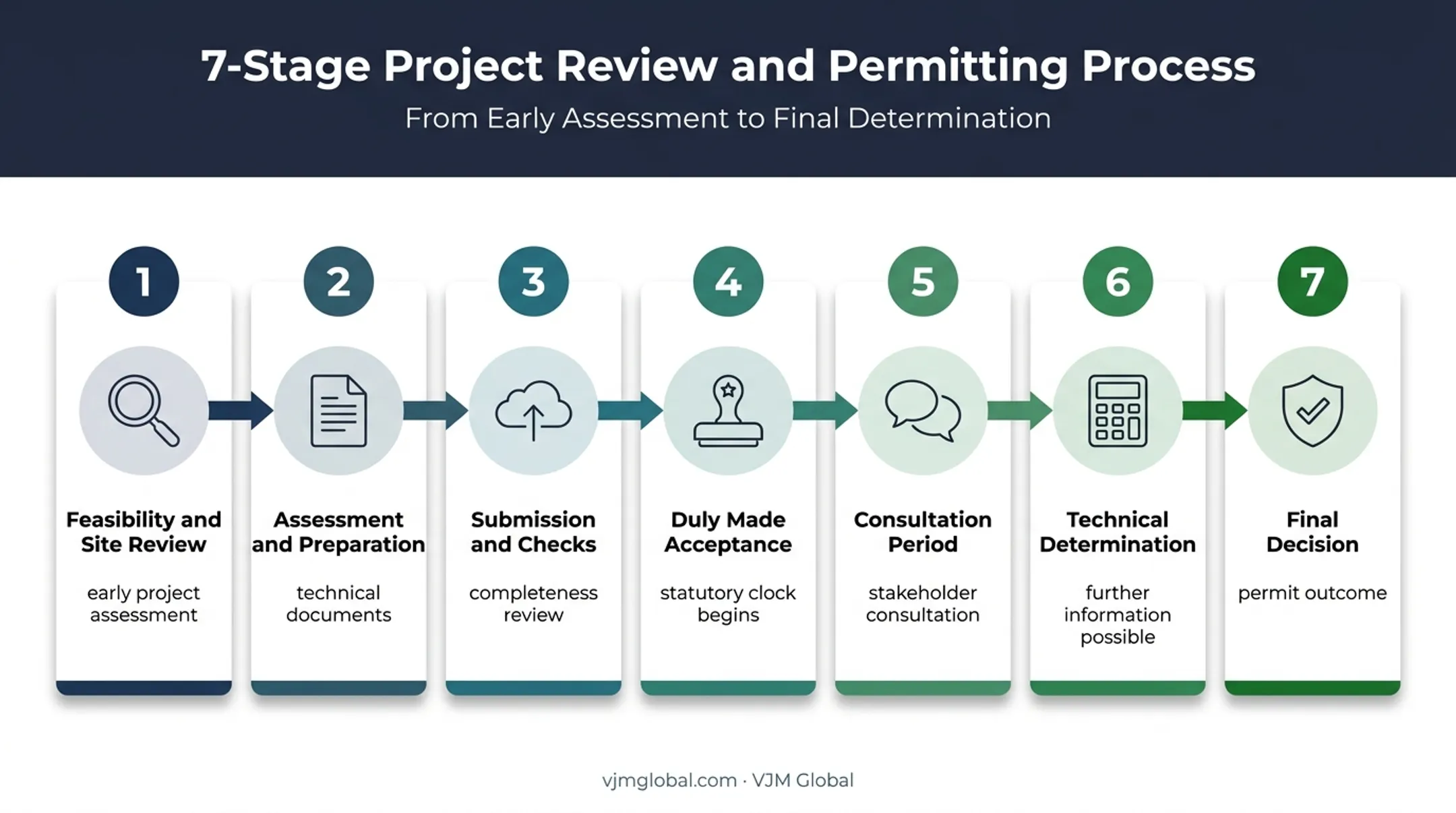

Timescales: A Sequence, Not a Single Promise
Treat timing as stages, not a single number:
- Early feasibility and site review
- Assessment and document preparation
- Submission and completeness checks
- "Duly made" acceptance
- Consultation period
- Technical determination (possibly including further information requests)
- Final decision

Under the Environmental Permitting Regulations 2016, statutory determination periods are generally three to four months from a duly-made application. That clock can pause while the regulator waits for further information, or extend by agreement.
Confirm the current statutory period and service standard for your specific permit and nation before you lock a project schedule.
Practical timing tips:
- Submit well before construction or operation needs to start
- Build in time for seasonally dependent surveys (ecological work often needs a set season)
- Never treat planning approval as proof that environmental permitting is sorted — they run on separate clocks
UK Environmental Regulators and Responsibilities After Approval
UK environmental permitting is split across four national regulators:
| Nation | Regulator | Scope |
|---|---|---|
| England | Environment Agency (EA) | Listed installations, waste, water and specified activities |
| Wales | Natural Resources Wales (NRW) | Welsh EPR permitting routes |
| Scotland | Scottish Environment Protection Agency (SEPA) | EASR authorisations, permits, registrations, general binding rules |
| Northern Ireland | Northern Ireland Environment Agency (NIEA) | Waste licensing, PPC, water discharge consents |
Your regulator's remit can overlap with other bodies: local planning authorities, sewerage and water authorities, local councils, health bodies and conservation organisations. Each approval serves a distinct legal purpose. A planning permission or local authority agreement doesn't substitute for an environmental permit, and vice versa.
Duties After Approval
Once your permit is granted, you're expected to:
- Comply with every permit condition
- Operate within stated limits
- Maintain control measures
- Monitor and record results
- Report incidents and non-compliance promptly
- Submit required returns and retain evidence
- Train responsible staff
Build ongoing compliance into day-to-day operations with regular checks:
- Permit-condition audits
- Document control
- Incident response readiness
- Maintenance records
- Confirmation that actual activity still matches the permit
Variations, Transfers and Surrender
An outdated permit doesn't update itself. You'll need to apply for a variation when your process or scale changes, a transfer when ownership changes, or surrender when operations end.
Never start a regulated activity before the permit is formally granted. Submitting an application doesn't authorise operation; confirm your legal position with the regulator before construction or operation begins.
Frequently Asked Questions
Who are the environmental regulators in the UK?
England's regulator is the Environment Agency, Wales uses Natural Resources Wales, Scotland uses SEPA, and Northern Ireland uses NIEA. The correct regulator depends on where your activity is located.
Do I need a bespoke environmental permit for my business?
It depends on your activity, scale, materials, emissions, discharges and location. If no exemption or standard rules permit fits your operation, you'll likely need the bespoke route.
What is the difference between a standard rules permit and a bespoke permit?
A standard rules permit applies fixed, pre-written conditions to activities matching a published description. A bespoke permit is assessed and conditioned individually for your specific site and operation.
How long does a bespoke environmental permit application take?
Timescales vary by permit type, regulator and technical complexity, though three to four months from a duly-made application is common. Verify the current determination period with your regulator before planning your schedule.
What documents are needed for a bespoke environmental permit?
Typical requirements include site and process information, environmental risk assessments, management plans and monitoring proposals. Activity-specific evidence, such as fire prevention or odour management plans, may also apply.
Can I operate while my bespoke permit application is being assessed?
No. Submitting an application doesn't authorise operation. Confirm your legal position directly with the relevant regulator before starting or changing any regulated activity.
