Environmental Permitting and Compliance for UK Facilities Any UK facility that emits pollutants, handles waste, discharges to water, or operates near sensitive communities may need formal environmental authorisation before work starts. This isn't optional paperwork. It's a legal precondition for operating.

The risks of getting it wrong are practical and immediate. Facilities apply to the wrong regulator, assume planning permission covers everything, or forget to update permits after expanding a process line. Any of these can halt construction, delay commissioning, or trigger enforcement action.

This guide walks through the UK regulators involved, the permit types facilities commonly need, how to prepare an application, and what ongoing compliance actually looks like once the permit is in hand.

Key Takeaways

  • Permit requirements depend on activity type, emissions, waste streams, location and risk—not business size.
  • Standard rules permits use fixed conditions; bespoke permits are built around your specific site and risks.
  • Getting a permit is the start of your obligations, not the end of them.
  • Always confirm current requirements with the relevant regulator before construction, expansion, or process changes.

UK Environmental Permitting: Legal and Regulatory Framework

Environmental permitting exists to control pollution, waste handling, emissions, and water-related activities through legally enforceable conditions attached to a permit. Rather than banning risky activities outright, regulators authorise them under specific, monitored terms.

In England and Wales, the Environmental Permitting (England and Wales) Regulations 2016 (EPR 2016) sets out which facilities count as "regulated facilities" and prohibits operating one without the required authorisation. Schedule 1 of the regulations lists the specific installation activities that fall within scope.

Four Regulators, Four Different Rulebooks

UK environmental regulation isn't one system with regional offices. Each nation runs its own regime:

Nation Regulator Governing framework
England Environment Agency (EA), or local authority for specified installations EPR 2016
Wales Natural Resources Wales (NRW), or local authority for specified installations EPR 2016
Scotland Scottish Environment Protection Agency (SEPA) Environmental Authorisations (Scotland) Regulations 2018 (EASR)
Northern Ireland Northern Ireland Environment Agency (NIEA), within the Department of Agriculture, Environment and Rural Affairs (DAERA) Separate Pollution Prevention and Control (PPC), waste, and water discharge regimes

Scotland's position changed recently. Since 1 November 2025, water, waste management, and industrial activities in Scotland moved under EASR authorisations, replacing the older Pollution Prevention and Control (PPC) framework.

If your facility operates across borders, do not apply an England-only checklist to a Scottish or Northern Irish site. Terminology, exemptions, and application routes differ.

It Rarely Stands Alone

An environmental permit doesn't replace other approvals your facility may need. Depending on the activity, you might also require:

  • Planning permission and building regulations approval
  • Water abstraction or discharge consents
  • Trade effluent consent from the local water company
  • Waste carrier registration
  • Fire prevention plan sign-off
  • Health and safety authorisations

Each sits on a different legal footing, administered by a different body, with its own timeline.

Which Environmental Permits Might a UK Facility Need?

Start by screening your activities, not your industry label. Ask whether your facility:

  • Releases pollutants to air, land, or water
  • Stores, treats, recovers, or disposes of waste
  • Runs combustion plant or handles chemicals and fuels
  • Abstracts water or discharges wastewater
  • Manages potentially hazardous materials

Each answer points toward a different permit category:

Permit type Relevant when
Waste operation permit Keeping, treating, recovering, or disposing of waste (unless a valid exemption applies)
Installation permit (Part A1, A2, or B) Listed industrial activities under Schedule 1 of EPR 2016
Local authority pollution permit Part A(2) and Part B installations, often air emission-focused
Water discharge/groundwater permit Discharging effluent to surface water or onto ground
Radioactive substances permit Keeping, using, or handling radioactive material or waste
Water abstraction/impounding licence Abstracting over 20 cubic metres per day, generally

Standard Rules vs. Bespoke Permits

Standard rules permits use predefined conditions written for a specific activity type that meets published limits and criteria. They're faster to obtain because the risk assessment is already done for you.

Bespoke permits are built around your facility's actual processes, emissions, risks, and location. If your activity falls outside the published standard rules scope, conditions, or throughput limits, you can't simply pick the standard route to save time. You need a bespoke application with a site-specific risk assessment.

Before You Apply: A Practical Checklist

Map your facility thoroughly before contacting any regulator:

  1. Map every process from raw material intake to final output or disposal
  2. Identify all inputs and outputs, including by-products and waste streams
  3. Quantify waste volumes and emissions, not rough estimates
  4. Review nearby sensitive receptors—homes, schools, protected habitats
  5. Confirm exact site boundaries against what you'll actually operate
  6. Note planned future changes, since these affect which permit route fits

Several facility characteristics can still shift which permit route applies:

  • Throughput volume and fuel type
  • Waste classification and number of emission points
  • Proximity to protected sites
  • Cumulative impact with neighbouring operations
  • Temporary versus permanent activity

How to Apply for an Environmental Permit in the UK

Applications follow a broadly consistent sequence, though the exact forms and portals differ by nation.

  1. Identify the activity and correct regulator — confirm whether the Environment Agency, SEPA, Natural Resources Wales, or NIEA covers your activity
  2. Establish whether an exemption applies — not every activity needs a full permit
  3. Select the permit type — standard rules or bespoke
  4. Review pre-application guidance — most regulators publish activity-specific requirements
  5. Prepare supporting evidence — site plans, process descriptions, risk assessments
  6. Submit the application through the relevant regulator's system
  7. Respond to regulator questions promptly and accurately
  8. Receive the final permit with its specific conditions

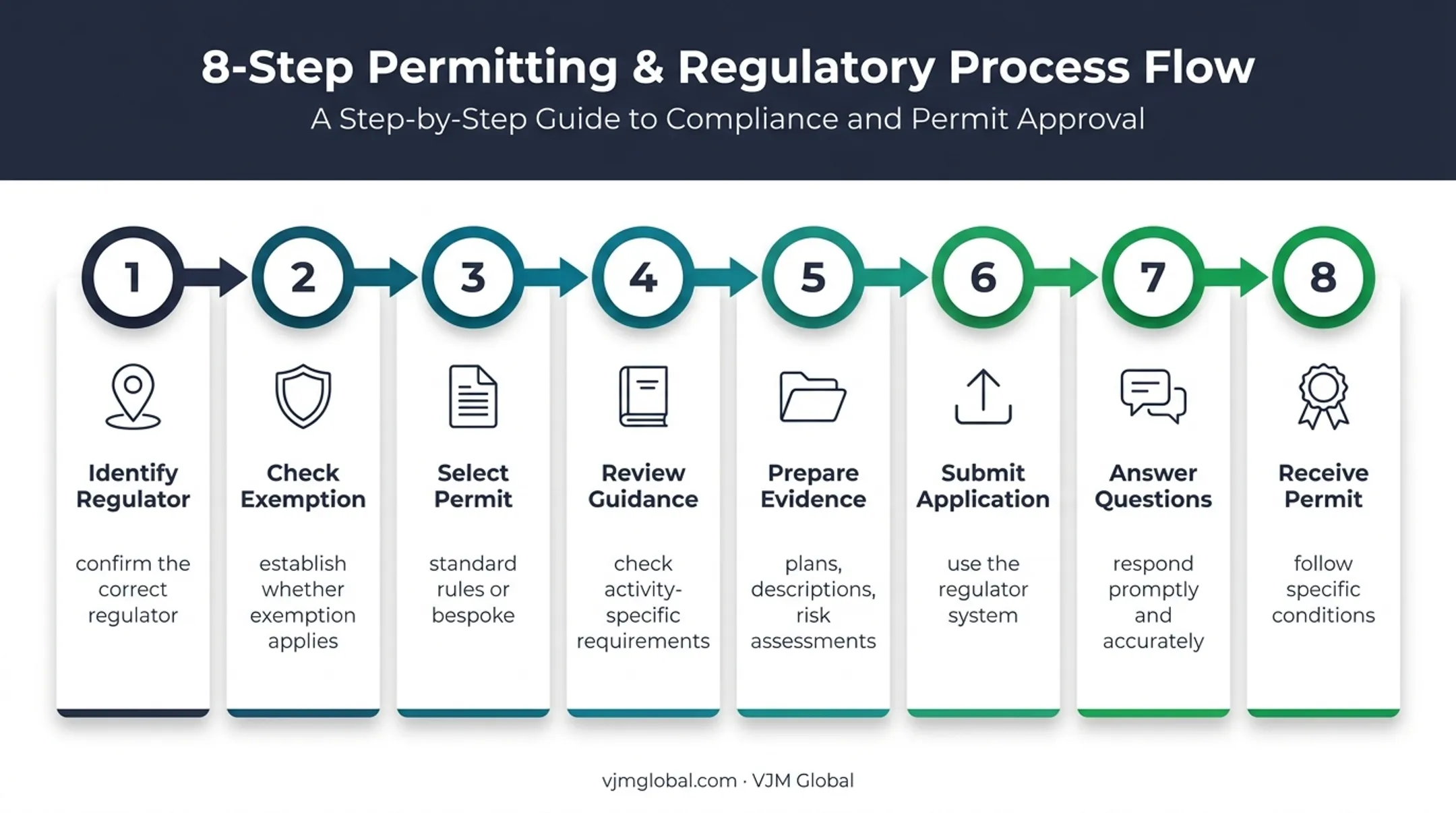

8-step UK environmental permit application process flow

What Goes Into the Application

Expect to prepare:

  • Site plans showing boundaries and activity areas
  • Process descriptions and plant/equipment details
  • Emissions data and waste acceptance procedures
  • Environmental risk assessments
  • Accident management plans
  • Proposed monitoring arrangements

Every document must describe the same site boundary and operating scenario. Inconsistencies between your drawings, risk assessments, and process descriptions are a common cause of delays.

When Specialist Evidence Becomes Necessary

Some applications need technical studies beyond the standard package:

  • Air quality assessments or dispersion modelling (where screening can't rule out impact)
  • Noise or odour assessments
  • Flood risk information
  • Hydrogeological studies
  • Fire prevention plans (for combustible waste storage)
  • Ecological assessments near protected habitats

Once submitted, the regulator's review can involve further information requests, consultation with other bodies, technical assessment, and sometimes a site visit. Public participation may apply for certain bespoke applications.

Answer any information notices within the stated timeframe. Missed deadlines can restart parts of the clock.

Application fees, annual subsistence charges, and typical determination times vary by activity, nation, and permit complexity. Rather than relying on a fixed figure, check the regulator’s current published charging scheme before you budget or schedule construction.

How to Maintain Ongoing Environmental Compliance

A permit isn't a certificate you file away. It's an operating control document. Staff running the facility need to understand its limits, monitoring duties, reporting deadlines, and incident procedures, not just the compliance team.

Building a Compliance Management System

A workable system needs four components:

  • A register of permit conditions with a named owner for each one
  • Monitoring schedules covering emissions, waste, discharges, and control equipment
  • Accurate records of measurements, inspections, maintenance, training, waste movements, complaints, and regulator communications
  • Internal audits and management reviews that catch problems before a regulator does This last point matters more than most facilities realise. VJM Global's internal audit practice, built for financial and process governance, applies a principle worth borrowing here: audits should focus on the controls with material impact, not tick-box coverage of everything. When a deviation surfaces, root-cause analysis (rather than a one-off fix) prevents the same failure recurring. Structuring audit scope and frequency with an oversight body—an audit committee equivalent, or a senior operations lead—keeps the review process disciplined rather than ad hoc.

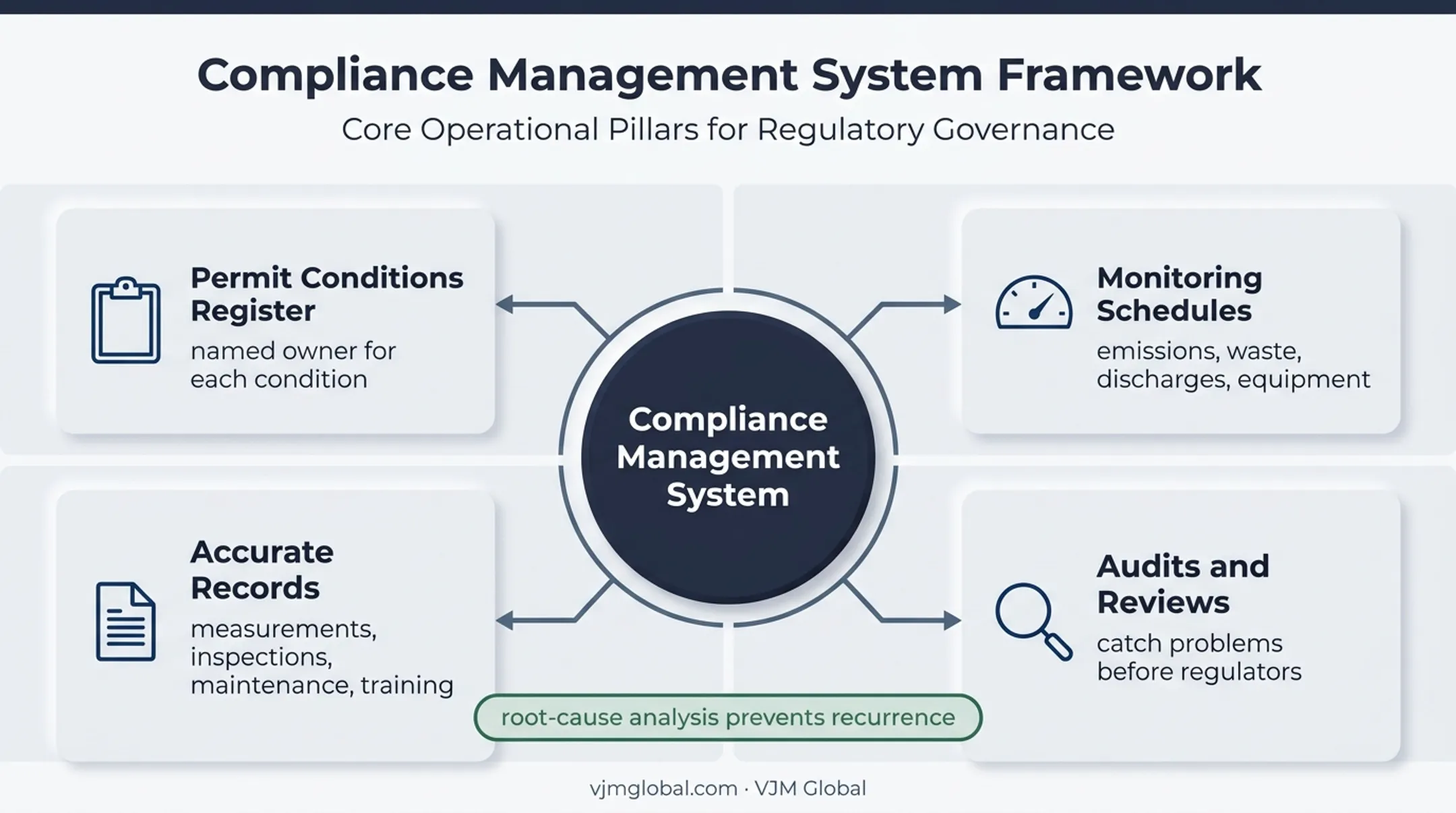

Four-part environmental compliance management system framework

When Something Goes Wrong

If an incident occurs:

  1. Make the site safe immediately
  2. Prevent further environmental harm
  3. Notify the regulator where your permit requires it
  4. Investigate the cause properly, not superficially
  5. Document every action taken
  6. Verify that corrective measures actually worked An oral report to the regulator in an emergency should be followed promptly by a written report referencing it; verbal notification alone rarely satisfies formal requirements.

Change Control and Inspections

Any of the following typically needs a permit variation or regulator notification:

  • New processes, raw materials, fuels, or waste types
  • Increased throughput or new equipment
  • Altered site layout or changed operating hours
  • New pollution controls Regulators assess compliance through desk reviews, site inspections (often unannounced), and sampling. The EA scores non-compliances into risk categories that build into an annual compliance rating, so a poor record compounds over time. Review permits against operational reality regularly, especially after acquisitions, expansions, new production lines, or legislative updates.

Common Environmental Compliance Risks and How to Avoid Them

The same failures show up repeatedly across enforcement cases:

  • Starting regulated activity before authorisation is granted
  • Operating under an outdated permit after a process change
  • Assuming planning permission covers environmental obligations
  • Misclassifying waste streams
  • Omitting emission sources from monitoring
  • Failing to keep required records

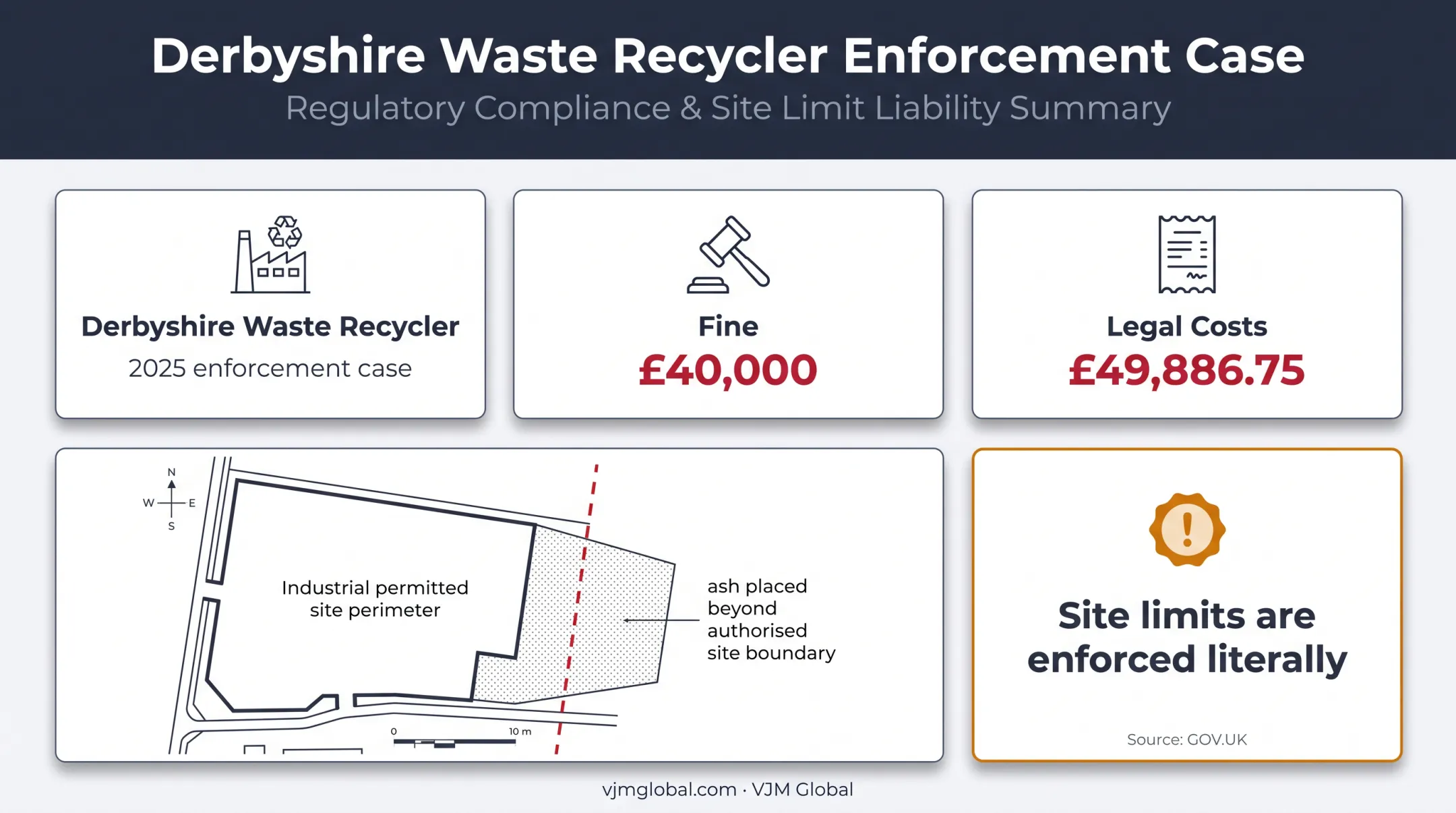

Enforcement isn't theoretical. In 2025, a Derbyshire waste recycler was fined £40,000 plus £49,886.75 in costs after placing ash beyond its authorised site boundary. Site limits are enforced literally, not loosely.

Derbyshire waste recycler environmental enforcement fine and costs

Weak operational controls compound the risk:

  • Poorly maintained pollution-prevention equipment
  • Inadequate spill response plans
  • Untrained staff handling permitted activities
  • Incomplete monitoring records
  • Inconsistent oversight of contractors on site

Run this checklist before operations start and again annually:

  • Permit scope and conditions
  • Monitoring results
  • Incidents and complaints logged
  • Fees and reporting obligations met
  • Emergency arrangements tested
  • Staff competence current
  • Planned changes flagged early

Get specialist advice when the activity is technically complex, the site sits near sensitive receptors, the regulator requests substantial further information, or you're planning a significant process change. In those cases, generic guidance is not enough—get advice tied to your permit and site.

Frequently Asked Questions

How do I ensure compliance with environmental regulations?

Identify the correct permit, document your operating controls, and monitor and record consistently. Train staff, report incidents promptly, run internal audits, and review everything periodically against current regulator guidance.

What do the Environmental Permitting (England and Wales) Regulations 2016 cover?

EPR 2016 sets the permitting framework for specified regulated activities across England and Wales, with enforceable conditions and regulator oversight. Check official government guidance for the definitive, current position on your activity.

What is the difference between a standard rules permit and a bespoke permit?

Standard rules permits use predefined conditions for activities meeting published criteria. Bespoke permits are tailored to your facility's specific risks, processes, and location when standard rules do not fit.

Do I need planning permission as well as an environmental permit?

Usually, yes. Planning permission and environmental permitting control different aspects of a project. Many developments need both, plus other consents depending on activity and location.

What happens if a facility breaches its environmental permit conditions?

Regulators can investigate, require remedial action, issue enforcement notices, impose financial penalties, restrict or suspend the permit, or pursue prosecution. The response depends on the severity of the breach and the jurisdiction involved.
