Introduction
If you're searching for a UK "environmental clearance certificate," here's the reality: it doesn't exist as a single document. What UK developers actually navigate is a combination of planning permission, Environmental Impact Assessment (EIA), environmental permits, and habitats assessments — each governed by separate legislation.
This matters for developers, businesses, investors, and project teams planning activity anywhere in England, Wales, Scotland, or Northern Ireland. Getting the approval pathway wrong doesn't just delay a project. It can trigger enforcement action, halt operations, or derail financing.
The term "environmental clearance" gets used loosely across planning applications and investor decks, but UK regulators don't recognise it as a formal category. This article breaks down the actual authorities, process stages, required documents, and compliance risks you need to plan around.
Key Takeaways
- No single UK certificate covers environmental approval — expect multiple overlapping requirements
- EIA, planning permission, environmental permits, and habitats assessments are separate legal instruments
- Each UK nation (England, Wales, Scotland, Northern Ireland) has its own regulator and legislation
- Confirm approvals before construction, abstraction, emissions, or waste handling begins
- A project-specific approval matrix works better than assuming one clearance covers everything
What Is Environmental Clearance in the UK?
In practical terms, "environmental clearance" means identifying, obtaining, and maintaining every environmental permission a specific project legally requires. That's a process, not a product, and it rarely produces one document.
The Four Instruments You'll Actually Encounter
Four distinct mechanisms typically apply, and none substitutes for another:
- Environmental Impact Assessment (EIA) — a formal process producing an Environmental Statement (England, Wales, Northern Ireland) or EIA report (Scotland) that informs a planning decision
- Planning permission — the legal authorisation to develop land, granted by the local planning authority
- Environmental permit — separate authorisation to operate a regulated activity that may pollute air, land, or water
- Habitats Regulations Assessment (HRA) — required where a project might affect a protected European site
According to GOV.UK's official EIA guidance, the Environmental Statement is evidence that informs the planning decision-maker. It doesn't grant permission on its own. That distinction trips up a surprising number of applicants.
Legislation Varies by Nation
The governing law differs depending on where your project sits:
| Nation | Planning & EIA Instrument | Environmental Permitting |
|---|---|---|
| England | Town and Country Planning Act 1990; EIA Regulations 2017 | Environmental Permitting Regulations 2016 |
| Wales | Same 1990 Act; separate Wales-specific EIA Regulations 2017 | 2016 Regulations; administered by Natural Resources Wales |
| Scotland | Town and Country Planning (Scotland) Act 1997; Scottish EIA Regulations 2017 | SEPA authorisations, amended 2025 |
| Northern Ireland | Planning Act (Northern Ireland) 2011; NI EIA Regulations 2017 | NIEA/DAERA pollution-control permits |
Applying England's Environmental Statement template to a Scottish project, or assuming Welsh regulations mirror England's, causes avoidable rework. Confirm the exact instrument for your nation before you draft anything.
Why Environmental Approval Is Used and Where It Applies
Environmental review exists because certain developments carry a real risk of harming air quality, water resources, land, biodiversity, or nearby communities. The scrutiny isn't arbitrary ; it targets project types and locations where impact is genuinely more likely.
Project Categories That Trigger Extra Scrutiny
Common triggers include:
- Major infrastructure and energy generation schemes
- Mineral extraction and waste management facilities
- Industrial installations and large transport projects
- Intensive agriculture, including livestock installations
- Large-scale construction near sensitive receptors
England's Schedule 2 development list, for instance, covers categories like intensive livestock installations and electricity-generating installations , but meeting a Schedule 2 description doesn't automatically mean EIA is required. The test is whether significant effects are likely, based on the development's nature, size, and location.
Location Changes Everything
Site sensitivity often matters more than project size. A modest extension near a Site of Special Scientific Interest can trigger more scrutiny than a larger scheme on an unremarkable brownfield plot. Watch for:
- Protected habitats (SACs, SPAs, Ramsar sites, SSSIs)
- Flood-risk zones and water environments
- Contaminated land and coastal locations
- Conservation areas and heritage assets
- Proximity to homes or other sensitive receptors
GOV.UK's habitats guidance confirms there's no fixed proximity radius for triggering an HRA. Effects can arise well beyond a site boundary through water, air, or noise pathways.
Planning Permission vs. Operating Permission
These are legally distinct: planning permission authorises developing land. An environmental permit authorises operating an activity that may pollute.
A solar farm illustrates this well. England's NSIP threshold for solar rose from 50 MW to 100 MW from 31 December 2025, shifting many mid-sized projects into local planning routes. Regardless of which planning route applies, a project affecting a SAC may still need a separate HRA, and any polluting operational activity will still need its own permit.
How the UK Environmental Approval Process Works

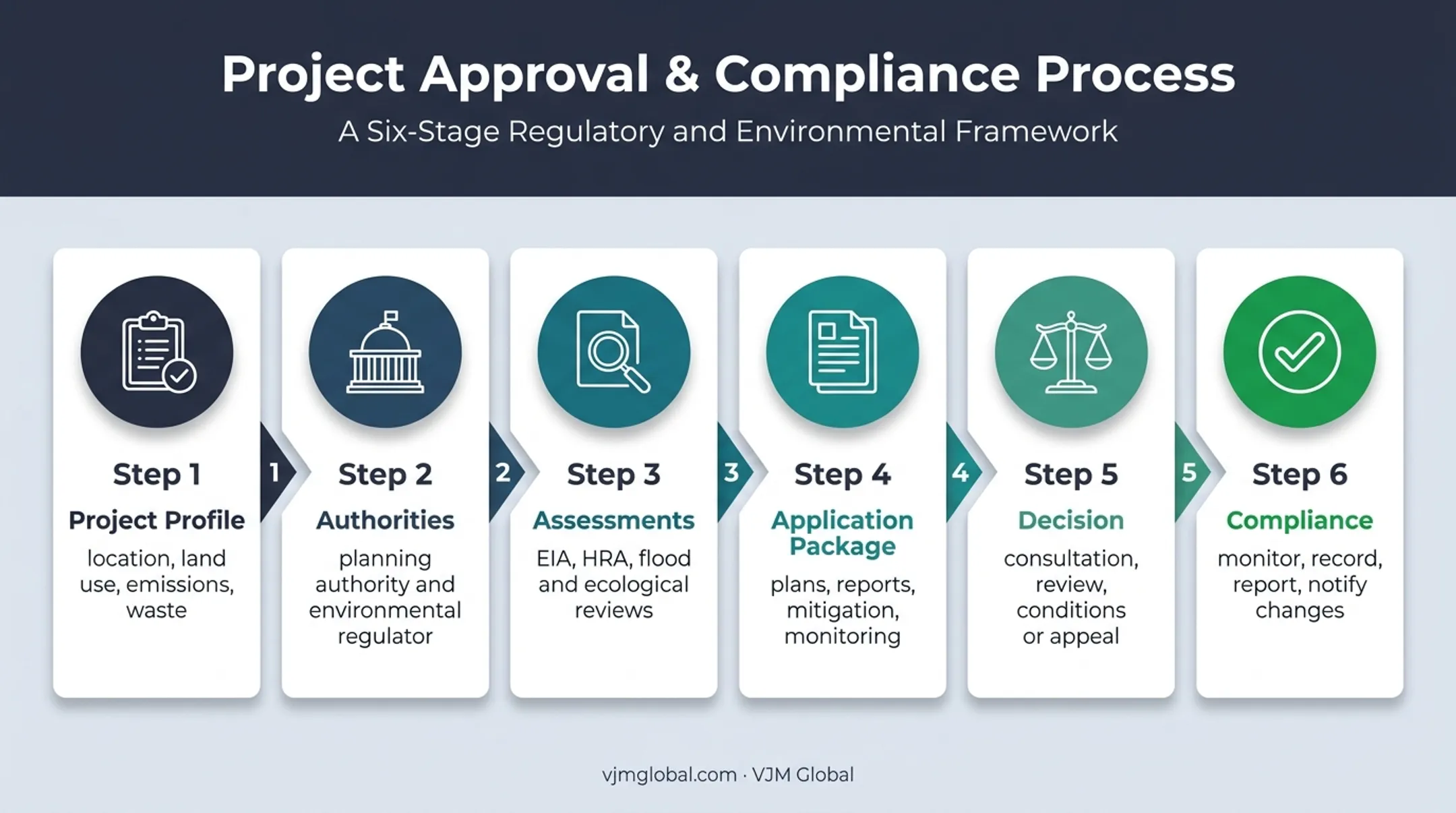

The process generally follows six stages, though the specifics vary by nation and activity.
Establish the project profile: Document location, land use, construction methods, and capacity. Capture emissions, waste streams, resource use, discharge points, and likely effects on people and protected environments.
Confirm competent authorities: Identify the local planning authority and the relevant environmental regulator (Environment Agency, Natural Resources Wales, SEPA, or NIEA). Check whether pre-application discussion or formal EIA screening is available.
Determine required assessments: Decide whether EIA, HRA, flood/drainage review, ecological surveys, or water-related consent applies. Confirm this before committing to a final design.
Prepare the application package: Assemble plans, environmental reports, mitigation proposals, monitoring arrangements, and operator details required by the relevant authority.
Navigate consultation and decision-making: Expect public consultation (commonly 21 days in England), technical review, and possible requests for further information. Decisions may come with conditions, refusal, or a right of appeal.
Manage post-approval compliance: Implement mitigation measures, monitor permit conditions, keep records, report as required, and notify authorities if the project changes.

Timelines Vary Considerably
Don't assume a single UK-wide clock applies:
- English standard planning applications: 8 weeks; major development: 13 weeks; EIA applications: 16 weeks
- NSIP/DCO route: can take around 17 months from submission to decision, per Planning Inspectorate guidance
- Environmental permit determination: typically three months in the residual category under the 2016 Regulations, with longer periods for specified cases
Natural Resources Wales separately notes that complex or high-interest applications can exceed published service levels. Treat these figures as planning benchmarks, not guarantees.
Key Factors, Documents and Compliance Risks
Before submitting anything, map these factors against your specific project:
Project characteristics:
- Scale, capacity, and construction methods
- Operating hours, emissions, and discharges
- Waste types and hazardous substances
- Energy/water use and anticipated traffic or noise
Site sensitivity:
- Protected habitats, species, and water bodies
- Groundwater and flood risk exposure
- Landscape, heritage, and nearby residential areas
- Cumulative effects alongside other developments
Regulatory structure — Which UK nation you operate in determines both the planning authority and environmental regulator, plus any sector-specific body involved.
Evidence quality — Accurate baseline data, impact predictions, and a clear mitigation hierarchy carry real weight with decision-makers. Weak evidence is a common refusal reason.

Timing sensitivity — Ecological surveys are often seasonal. Natural England's guidance flags breeding-bird surveys typically running March–August and great crested newt surveys mid-March to mid-June. Miss the window, and you may need to wait a full year.

Documents commonly required:
- Environmental Statement and non-technical summary (where EIA applies)
- Seasonal ecological and baseline survey reports
- Topic studies such as air quality, noise, water, flood risk, or heritage
- Mitigation, monitoring, and construction environmental management plans
- Habitats Regulations Assessment material where protected sites may be affected
Compliance risks: Operating without required approval carries real consequences. Environment Agency enforcement policy describes enforcement notices, civil sanctions, enforcement undertakings, and prosecution as available enforcement tools.
Common Issues and When a Single Clearance Is Not Appropriate
Misconceptions and mid-project changes cause avoidable delays.
"An EIA report is my permission to build." It isn't. English regulations explicitly prohibit granting planning permission for EIA development without EIA having been carried out, but the Environmental Statement informs the decision; it doesn't constitute the decision.
"Planning permission covers pollution-related activities." It doesn't. The Environmental Permitting Regulations 2016 prohibit operating a regulated facility, or carrying out water-discharge activities, without the requisite separate permit. Planning approval and operational permitting run on parallel tracks.
Requirements can shift mid-project. Watch for these triggers:
- Expanding capacity or output
- Changing fuel type or raw materials
- Relocating to a more sensitive site
- Altering construction or operating methods
Even when formal EIA isn't required, other obligations often still apply — planning conditions, protected-species licences, or water abstraction consents can all bite independently. Natural England is explicit that species licensing sits in addition to, not instead of, planning permission.
Build an Approval Matrix, Not a Single Checklist

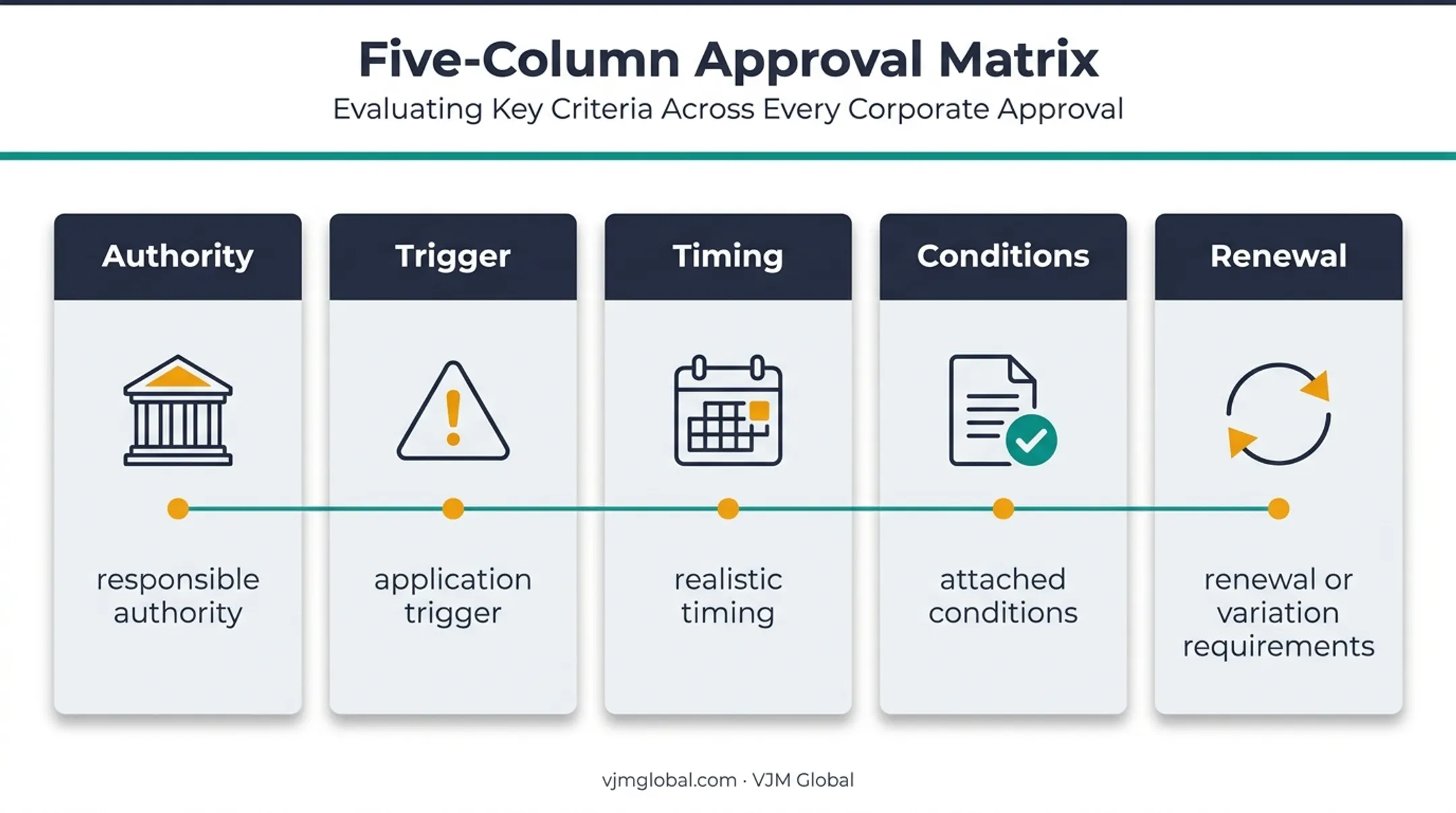

Rather than searching for one clearance, map each requirement against:
- The responsible authority
- The application trigger
- Realistic timing
- Attached conditions
- Renewal or variation requirements

This approach catches gaps that a single "have we got clearance?" question misses.
Conclusion
UK environmental clearance is a coordinated set of assessments, planning decisions, permits, and ongoing compliance duties. Treating it as one box to tick is the most common way projects run into delays, redesigns, or enforcement exposure.
Identifying the correct authority and approval pathway at the design stage, before commitments are locked in, saves both time and money later.
UK approvals also stop at the border. If you expand operations into India, that market applies its own environmental clearance framework, entity registration rules, and FEMA/FDI compliance requirements.
VJM Global supports UK businesses with India market-entry advisory, accounting, tax, and FEMA compliance coordination. It does not issue UK environmental approvals; those remain with the UK planning authorities and regulators covered above.
Frequently Asked Questions
How do I get an environmental clearance certificate in the UK?
Start by identifying your project's UK nation, planning authority, and specific environmental risks. Then confirm whether planning permission, EIA, an environmental permit, or habitats assessment applies. there's no single universal certificate to apply for.
How long is an environmental clearance valid for in the UK?
Validity depends entirely on the specific approval type. there's no single UK-wide period. Check your decision notice or permit conditions directly; England's general planning commencement period is three years, Wales's is five, unless otherwise specified.
Who issues environmental clearance in the UK?
Responsibility splits between your local planning authority and the relevant environmental regulator: the Environment Agency (England), Natural Resources Wales, SEPA (Scotland), or NIEA (Northern Ireland). Specialist bodies may also be involved depending on the activity.
What is environmental clearance in the UK?
It's shorthand for the combined environmental assessments and permissions needed to develop or operate a project lawfully. It isn't one document. it typically involves separate EIA, planning permission, and environmental permitting processes.
