This guide is written for operators, developers, and businesses planning to install or run small-scale incineration or co-incineration equipment. Getting the permit route right matters for three reasons: it keeps you on the right side of environmental law, it controls the pollution risks associated with burning waste, and it protects the people living and working near your site.
Many operators assume capacity alone decides whether they need a permit. It doesn't. Waste type, combustion activity, legal exclusions, and the UK nation where the site sits all factor into the correct classification.
This guide walks through how to establish whether your activity is a SWIP, how to pick the right regulator and application route, what evidence you'll need to assemble, and the mistakes that most commonly derail applications.
Key Takeaways
- Plant size alone never confirms an exemption: waste type and combustion activity matter just as much
- Classification must be confirmed before choosing an application route, not after
- The deciding regulator depends on your UK nation: local authority, Environment Agency, Natural Resources Wales, SEPA, or NIEA
- Applications need consistent data across capacity, waste codes, emissions, and monitoring plans
- Fee schedules and guidance change regularly, so always verify the current version before applying
What Is a SWIP and Why Is a Permit Needed?

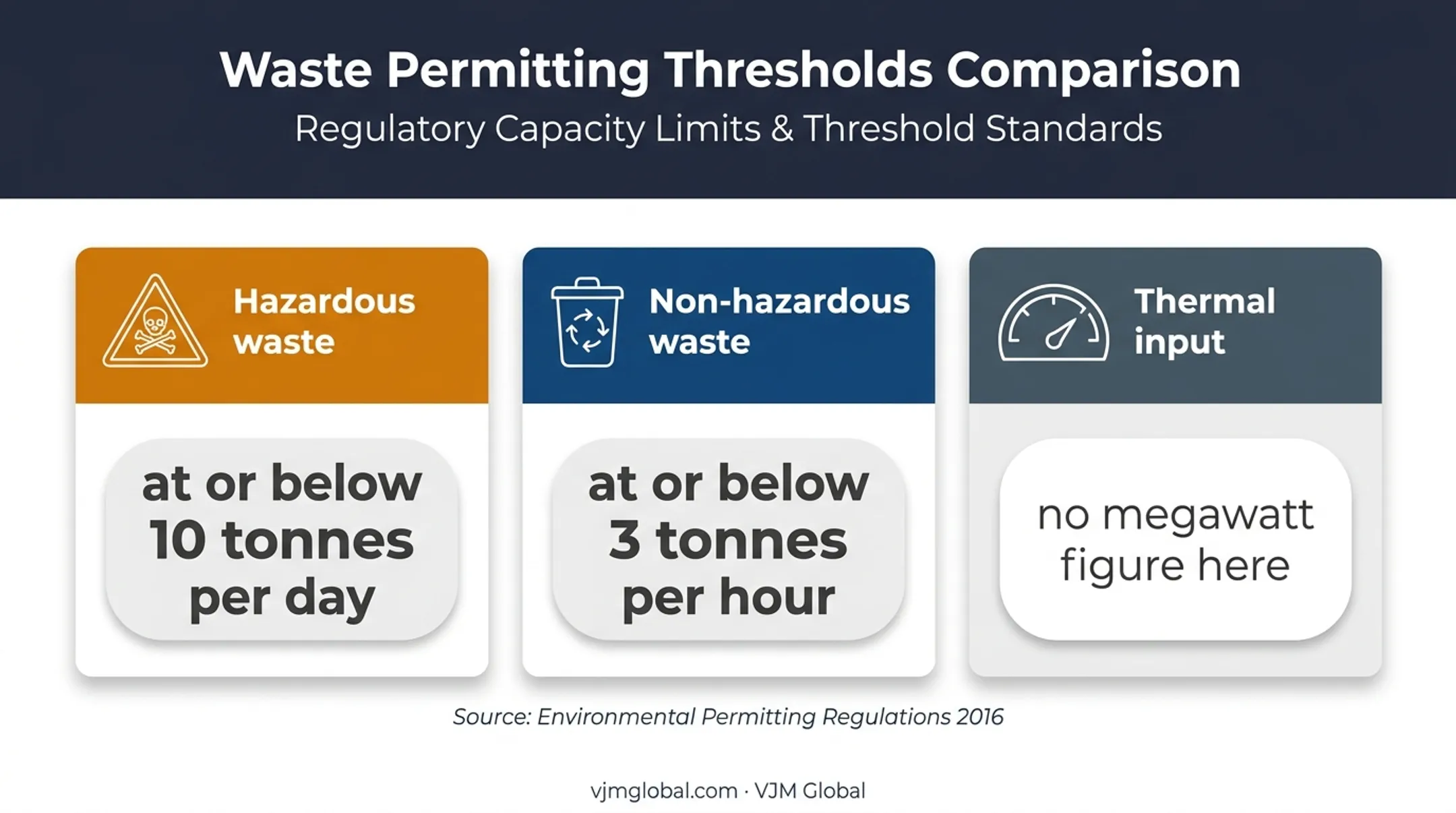

Under the Environmental Permitting (England and Wales) Regulations 2016, a small waste incineration plant is an incineration or co-incineration installation.
Capacity must sit at or below 10 tonnes per day of hazardous waste, or 3 tonnes per hour of non-hazardous waste. Notice there's no thermal-input figure in megawatts here. Capacity and hazardous status are what count.
Older GOV.UK guidance describes these limits as "less than" the thresholds, while the actual regulation says "at or below." If your plant sits exactly on either boundary, rely on the statutory wording and confirm your classification with the regulator directly before you proceed.

Classification Depends on More Than Size
A plant's SWIP status isn't just about tonnage. You also need to establish:
- Waste classification: hazardous or non-hazardous, and whether the material legally remains "waste"
- Combustion type: straightforward incineration versus co-incineration alongside another fuel
- Thermal treatment route: pyrolysis or gasification followed by combustion can still count
- Applicable exclusions: narrow, specific carve-outs rather than a blanket exemption for small equipment
A small waste-oil burner, for instance, can still be classed as a SWIP. GOV.UK's waste incineration guidance treats these burners the same way as larger plant unless a specific exclusion applies.
A Permit Is Not the Same as Other Approvals
An environmental permit is a distinct authorisation. It doesn't replace:
- Planning permission
- A waste exemption (which is a narrower, conditioned route)
- Building-control or fire-safety approval
- A water discharge consent
Each covers a different regulatory concern. Holding one doesn't automatically satisfy the others, and treating them as interchangeable is a common and costly mistake.
The permit itself controls:
- Which waste you're authorised to accept
- How you operate and what you emit
- How you handle residues
- Which records you must keep
Operating without the required permit, or breaching its conditions, is an offence under the Environmental Permitting Regulations. Enforcement action and operational restrictions can follow.

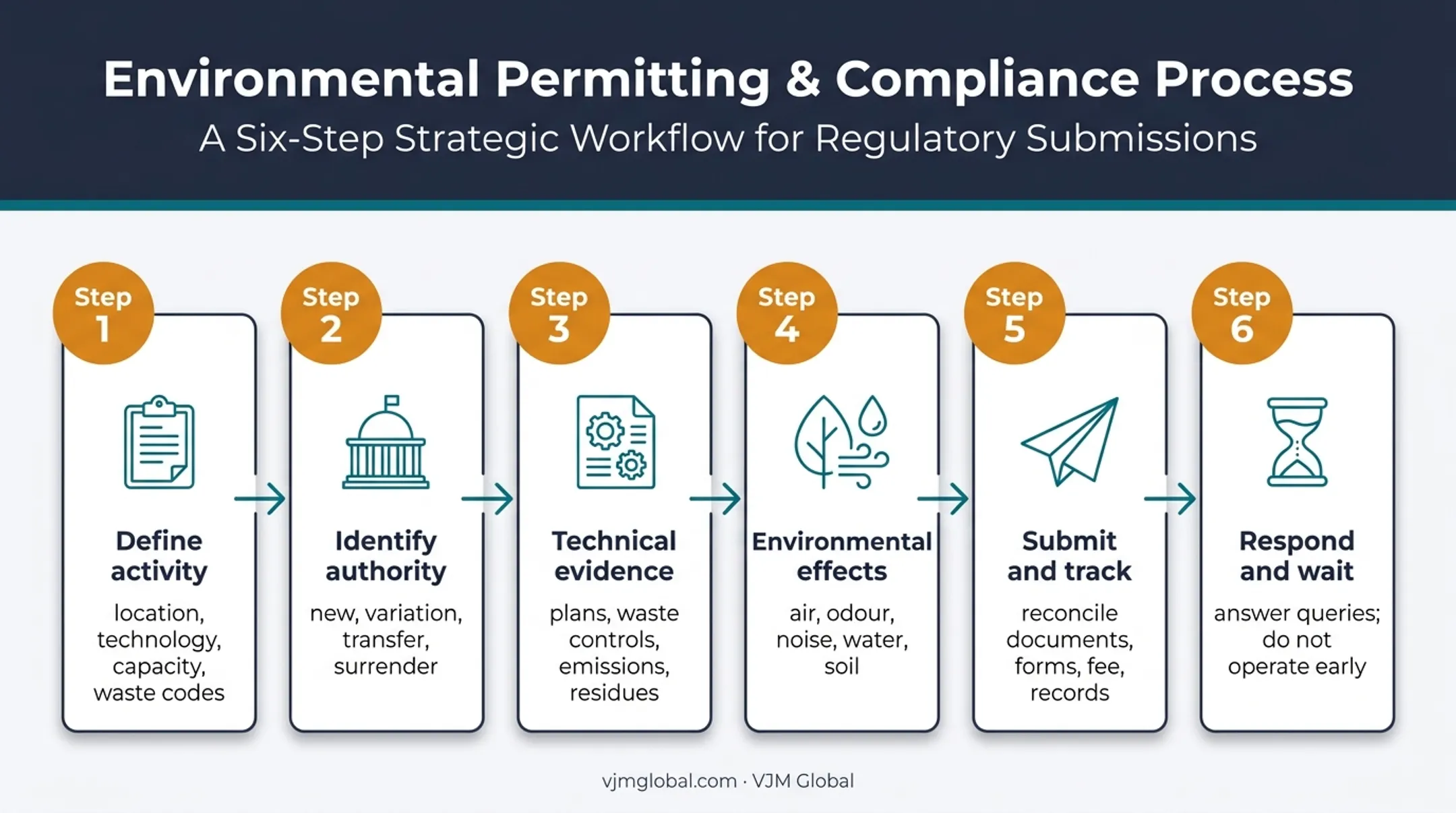

How to Apply for a SWIP Environmental Permit
Getting the application right starts well before you touch a form.
Step 1: Define the Activity Precisely
Record the core details of the proposed activity:
- Site location and plant technology
- Maximum design capacity and expected throughput
- Operating hours
- Waste sources, waste codes, and hazardous properties
- Whether co-incineration is involved
Use the plant's maximum intended capability, not your projected average throughput, when assessing against the statutory thresholds. A plant rated to handle more than it typically processes can still trip into higher regulatory categories based on design capacity.
Also check whether any proposed waste stream has a credible end-of-waste or exemption position. Don't assume calling something a "fuel" changes its legal status as waste.
Step 2: Identify the Correct Authority and Application Type
Confirm whether you need a new permit, a variation, a transfer, a surrender, or a different industrial permit altogether. Submitting to the wrong body wastes time and sometimes resets your position entirely.
Step 3: Assemble Technical Evidence
A solid application typically includes:
- A process description and non-technical summary
- Site plan and plant layout drawings
- Waste acceptance procedures and pre-acceptance checks
- Combustion controls and abatement system details
- An emissions assessment and monitoring plan
- Residue-management arrangements
- Environmental management procedures
Step 4: Assess Potential Environmental Effects
Consider air emissions, odour, noise, traffic, dust, water, soil, groundwater, and ash residues. Whether you'll need dispersion modelling or a specialist odour or noise assessment depends on your specific site and activity. There's no universal trigger here, so agree the scope with your regulator early.
Step 5: Submit and Track
Pre-submission checklist: Before you hit send, reconcile these documents against each other:
- Capacity figures
- Waste codes
- Emissions assumptions
- Site drawings
- Monitoring arrangements
- Operating procedures
Inconsistencies between these documents are one of the most common causes of delay.
Complete the current regulator forms, calculate the fee from the official schedule, and submit all supporting documents together. Keep a version-controlled record of everything you send.
Step 6: Respond and Wait
Reply promptly and consistently to regulator queries. Document any design changes raised during the process. Critically, do not begin operating until the permit is actually in force.

Where the Rules Apply and Which Regulator Is Involved
Environmental permitting is devolved, so the right regulator depends entirely on where your site sits.
| Nation | Deciding Authority | Notes |
|---|---|---|
| England | Local authority (not routinely the Environment Agency) | Stand-alone SWIPs fall to councils under current permitting guidance |
| Wales | Local authority | Natural Resources Wales handles other waste permits, but not routinely the stand-alone SWIP route |
| Scotland | SEPA | Small-scale incineration activity has its own application route and charging schedule |
| Northern Ireland | NIEA / DAERA | Falls under Part A PPC rather than the England-and-Wales SWIP label |
A few points worth flagging:
- SEPA applications need a location plan, infrastructure plan, process description, non-technical summary, protected-site impact assessment, and emissions data
- An odour-management plan is expected if the activity could be odorous
- Waste type matters: hazardous, non-hazardous, waste wood, waste oil, biomass claims, and co-incineration can each change how the regulator treats the installation
- Fees and forms change regularly — confirm publication dates on official regulator pages before relying on any figure
Your environmental permit sits alongside, not instead of, other approvals you might need: planning permission, fire-safety sign-off, or a separate water discharge consent. Check these requirements during project planning, not after construction starts.

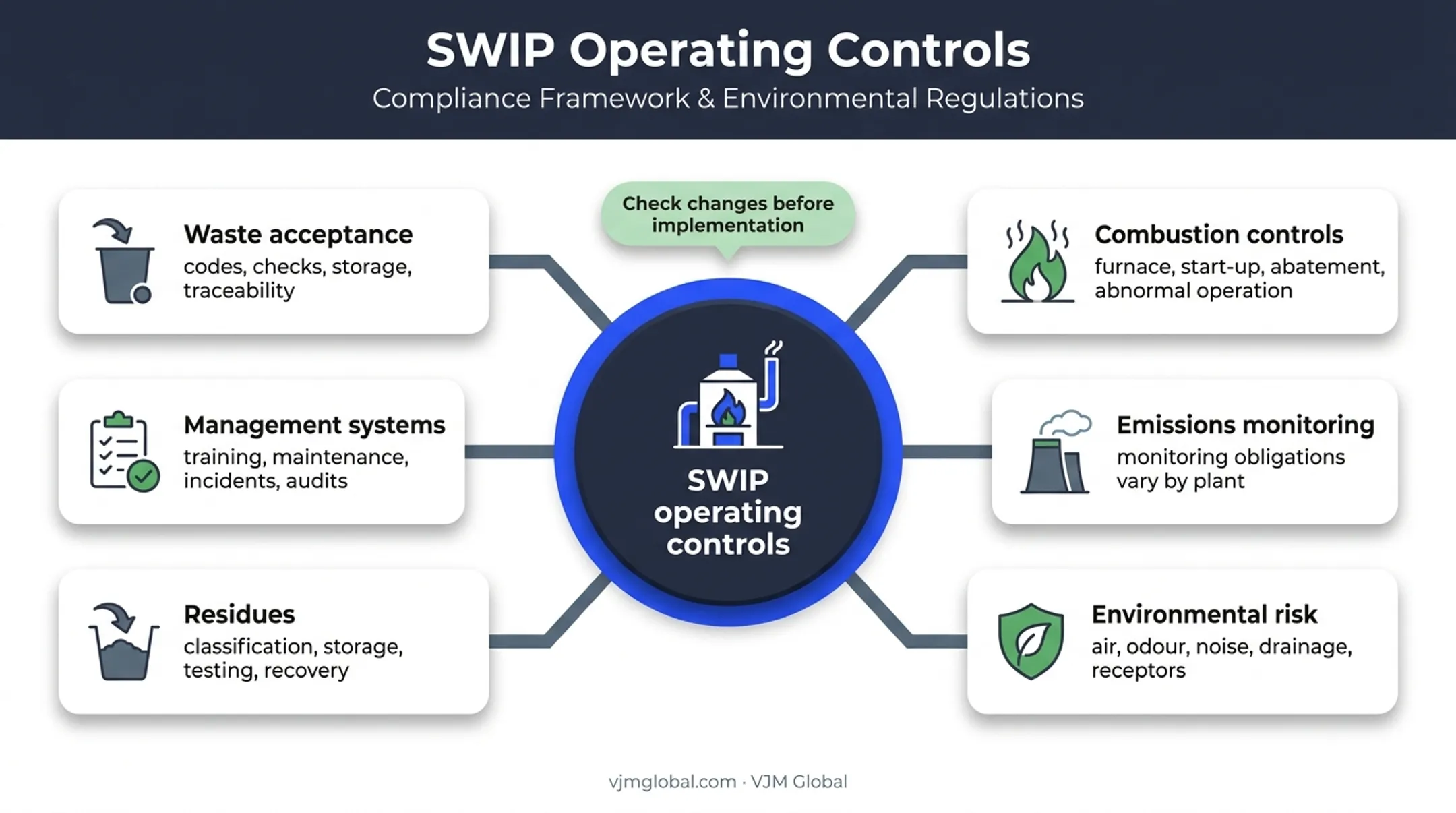

Key Application and Operating Requirements
Once the regulator has your application, several operational areas get scrutinised closely.
Waste acceptance and storage needs clear controls and full traceability. Cover at least:
- Permitted waste types and codes
- Contamination controls and pre-acceptance checks
- Storage limits and rejected-load procedures
- Traceability records end to end
Combustion and plant controls should cover:
- Furnace design and combustion conditions
- Start-up and shutdown procedures
- Residence or retention time controls where applicable
- Abatement equipment specifications
- Responses to abnormal operating conditions
Emissions and monitoring requirements vary by plant and permit. There is no single universal list. The Environment Agency's current guidance confirms that BS EN 14181 applies to permanently installed continuous emissions monitoring systems used for compliance purposes, but that does not mean every SWIP needs one installed. Confirm your monitoring obligations with the deciding regulator rather than assuming a standard set.
Environmental risk evidence is set case by case, not as a fixed checklist. Depending on the site, you may need:
- Air-quality assessment and dispersion modelling
- Odour assessment and noise information
- Drainage controls
- Sensitive-receptor review
Residues such as bottom ash, fly ash, and air-pollution-control residues each need their own classification, storage, testing, and recovery or disposal route. Don't assume the input waste's classification automatically transfers to the ash it produces.
Management systems should document the operating controls regulators expect to see:
- Training, maintenance, and calibration
- Monitoring and incident reporting
- Complaint handling and record retention
- Internal audits
Finally, changes matter. A shift in waste streams, plant capacity, abatement equipment, site layout, operating hours, or monitoring arrangements may require a formal permit variation or at least regulator notification. Check before you implement, not after.

Common Issues and When a SWIP Route May Not Be Appropriate
One misconception comes up again and again.
"It's small, rural, or generates energy, so it must be exempt." Not true. Burning waste for heat or power is still a regulated waste-incineration activity. Energy recovery doesn't remove the classification.
Even when the activity is correctly classed as a SWIP, weak filings still get held up. Common application weaknesses include:
- Vague waste descriptions or incorrect waste codes
- Inconsistent capacity figures across different documents
- Incomplete site plans
- Unsupported biomass or end-of-waste claims
- Missing sensitive-receptor information
- Inadequate monitoring proposals
A standard rules route may not fit every situation. If your activity can't meet every standard condition, involves unusual waste streams, exceeds normal limits, or needs site-specific controls, a bespoke permit or variation is often the more realistic path.
Sometimes a different route altogether is more appropriate: a qualifying exemption, a different Part A or Part B regime, or a separate fuel assessment. Confirm the correct path with your regulator before you draft the application.
Don't rely on an old permit, informal advice, or guidance that predates recent regulatory changes. Rules, plant designs, and accepted waste streams all evolve. A documented regulatory review before commissioning or modifying your plant saves far more time than it costs.
Conclusion
A successful SWIP permit application starts with accurate classification and the right regulatory route for your UK nation, then builds out complete technical and environmental evidence from there.
Permit conditions don't stop at approval. They continue to govern:
- Waste acceptance and combustion controls
- Emissions monitoring and residue management
- Reporting duties and any future operational changes
Where waste type, technology, emissions profile, or cross-border regulatory questions get complex, lean on current regulator guidance and professional technical input.
Environmental permitting is one strand of the broader compliance picture UK businesses manage alongside tax, corporate governance, and reporting. VJM Global works with UK businesses on that wider compliance and administrative load, so operational teams can stay focused on getting the technical permit right.
Frequently Asked Questions
How much is a waste permit in the UK?
Fees depend on permit category, regulator, and application type. Check the current schedule with your local authority, SEPA, or DAERA. Technical assessments, monitoring, and consultancy sit outside the application fee.
Does a small waste incineration plant need an environmental permit?
Most SWIPs require an environmental permit unless a specific legal exclusion or exemption applies. Waste type, capacity, technology, and location all need assessing together before you can confirm your position.
Which regulator issues a SWIP permit in the UK?
Local authorities handle stand-alone SWIPs in England and Wales; SEPA covers Scotland; NIEA/DAERA covers Northern Ireland. Confirm the current route with the relevant regulator.
What information is needed for a SWIP permit application?
You need site and process details, waste types and codes, capacity, combustion and abatement descriptions, and emissions data. Add a monitoring plan, residue-management arrangements, and environmental-risk evidence where relevant.
How long does a SWIP environmental permit application take?
Timescales vary with application completeness, technical complexity, regulator workload, and consultation needs. Check the current service standard with your regulator rather than assuming a fixed timeframe.
Can a SWIP permit be varied after the plant is approved?
Yes. Changes to waste streams, throughput, plant design, abatement, or operating conditions may require a formal variation or other regulator action. Get confirmation from your regulator before implementing any change.
