Landfill Environmental Permit Guidance in the UK Operating, developing, modifying or closing a landfill in the UK rarely involves just one approval. Many site operators assume that planning permission covers the full regulatory picture, only to discover that waste disposal also needs a separate environmental permit from the relevant national regulator.

This creates genuine confusion. Do you need a permit at all? Which regulator do you contact? What evidence does the application require? And how do landfill restrictions on specific waste streams affect what you're proposing to do?

This guide walks through the answers for England, Wales, Scotland and Northern Ireland, each of which runs its own permitting framework with different forms, timelines and terminology. The regulatory detail changes often, so treat this as a starting map rather than a final answer for your specific site.

Key Takeaways

  • Site- and activity-specific rules apply: waste type, disposal method and site engineering decide the permit route.
  • Planning permission, the environmental permit and waste carrier/broker registration are three separate approvals, often held by different parties.
  • Check current Environment Agency, NRW, SEPA or NIEA guidance before relying on older summaries.
  • Obligations continue after tipping stops: closure, aftercare, monitoring and permit surrender.

What Does a Landfill Environmental Permit Cover?

An environmental permit is regulatory authorisation to carry out an activity that poses a pollution risk. Landfill disposal sits firmly in that category because buried waste can generate leachate, gas and long-term groundwater contamination decades after the last load is tipped. That's why landfill is controlled far more tightly than most other waste activities.

Permit, Planning and Registration Are Not Interchangeable

It's a common mistake to assume one approval covers everything. It doesn't.

  • Planning permission addresses land use and development — not pollution control.
  • Environmental permits authorise the specific waste or emissions activity on site.
  • Waste carrier, broker or dealer registration covers moving or arranging waste, not operating the receiving facility.
  • Abstraction or discharge consents may apply separately if the site affects water resources.

Northern Ireland's DAERA is explicit that planning permission must be secured before NIEA will issue a landfill permit — one doesn't substitute for the other.

What the Regulator Actually Assesses

Regulators examine the proposal as a whole, not a single checklist item. Expect scrutiny of:

  • Waste classification (inert, non-hazardous or hazardous) and specific waste codes
  • Site location, geology and groundwater sensitivity
  • Containment design and engineering standards
  • Waste acceptance procedures and controls
  • Restoration and aftercare proposals
  • Risk to nearby people, water bodies and ecosystems

Bespoke Versus Standard Rules

This is where many applicants get caught out. The Environment Agency is direct on this point: a new landfill requires a bespoke permit, not a standard rules permit, according to its current landfill operator guidance.

Natural Resources Wales also handles landfill applications through its bespoke waste permit route. No current landfill-specific standard rules route was confirmed for Wales, Scotland or Northern Ireland. Don't assume a standard permit designed for another waste activity will cover landfilling. Always verify the category with the regulator before building a project timeline around it.

How to Apply for a Landfill Environmental Permit in the UK

Start With a Decision Stage

Before touching an application form, nail down four things:

  1. Define the activity: new development, variation, restoration of a historic site, or temporary deposit?
  2. Confirm waste types and disposal route: what's accepted, how is it classified, where does it go?
  3. Identify the site: boundary, location, surrounding sensitivities.
  4. Check linked permissions: is planning permission already in place or still required?

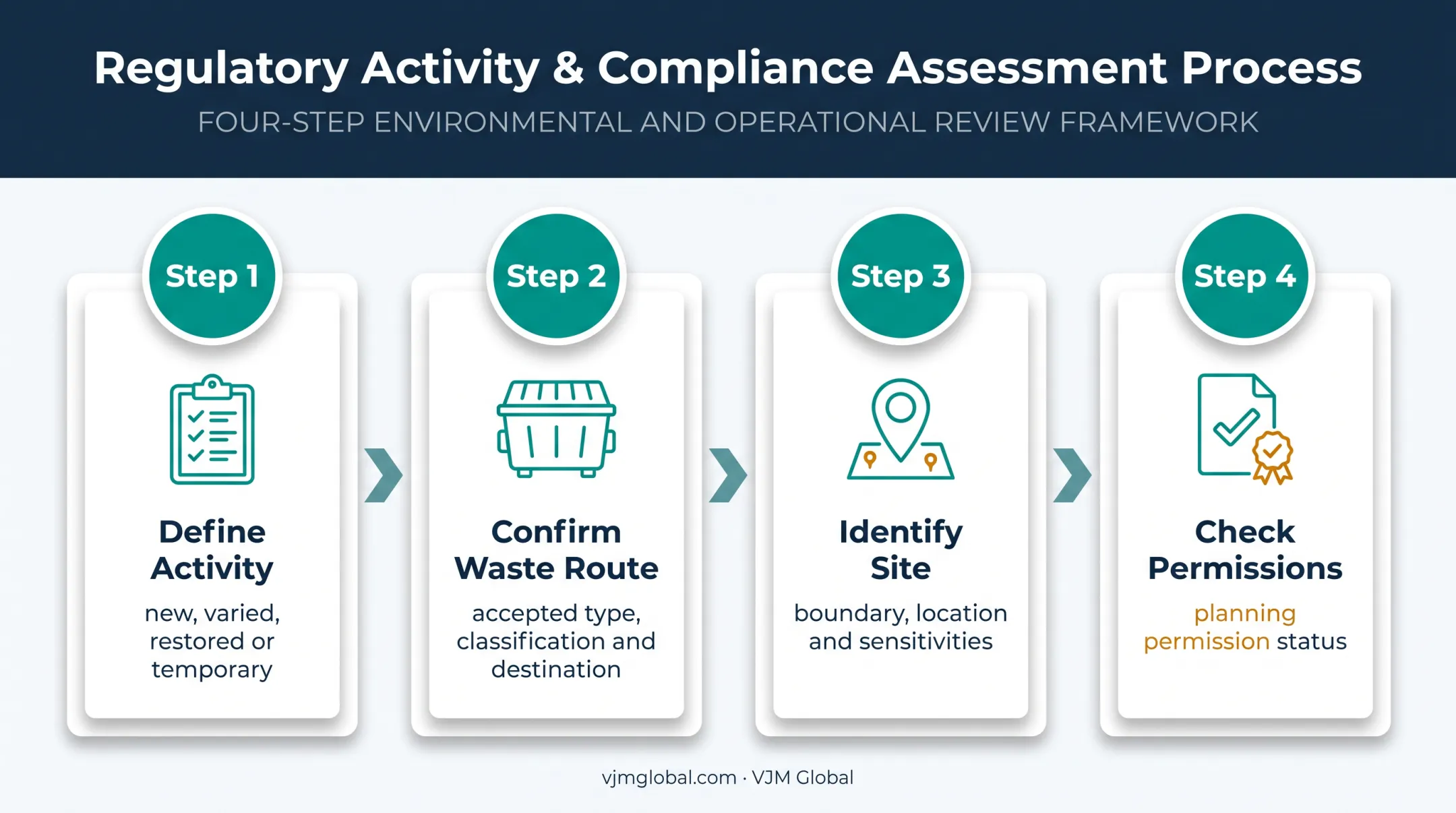

Four-step UK landfill environmental permit application decision process

Find the Right Regulator

Nation Regulator Starting Point
England Environment Agency Waste environmental permits service
Wales Natural Resources Wales Bespoke waste permit application service
Scotland SEPA Landfill activity pages; contact [email protected] for new non-hazardous landfill permits
Northern Ireland NIEA (via DAERA) Part A PPC(IE) application forms

Each nation uses different forms, fees and portals. Don't assume a process you've used in England will translate directly to Wales or Scotland.

Build Your Document Pack

Regulators generally want to see:

  • Site location and boundary plans
  • Site condition and baseline information
  • Waste types, quantities and classification data
  • Waste acceptance procedures
  • Operating techniques and infrastructure design
  • Restoration proposals
  • Management system documentation

NRW's inert-landfill guidance also asks for monitoring plans and closure/aftercare procedures specifically. Don't treat one regulator's checklist as universal across all four nations.

Risk Assessments Carry the Weight

Supporting technical reports need to address every credible pathway:

  • Groundwater and surface water
  • Landfill gas migration
  • Leachate generation and management
  • Odour, dust, noise, litter and pests
  • Fire risk
  • Traffic and nearby receptors

A generic amenity statement won't satisfy a regulator looking for site-specific pathway analysis.

What Happens After Submission

The Environment Agency consults for 20 working days on bespoke applications and typically aims to decide within four months, though complex sites take longer. NRW quotes a similar four-month statutory period. SEPA requires pre-application public consultation for new non-hazardous landfill activities. None of these timelines are guarantees. Treat them as planning assumptions, not commitments.

Before you submit, check that your planning documents, engineering drawings, risk assessments, waste acceptance criteria and management systems all tell the same story. Inconsistencies between these documents are one of the most common reasons applications stall. For complex or high-risk sites, specialist UK environmental permitting advice is worth the investment before submission, not after a refusal.

What Evidence and Controls Must a Landfill Operator Maintain?

Getting the permit is the start, not the finish. Ongoing compliance depends on evidence you generate and keep for the life of the site, and beyond.

Containment, Monitoring and Management Systems

Engineered containment, drainage, leachate management and landfill gas controls must match the design approved in your permit, supported by construction quality assurance records.

Specific liner thicknesses, gas extraction rates and monitoring frequencies vary by site and risk assessment. Check the regulator's current technical guidance rather than assuming a standard specification applies.

A sound operational management system typically includes:

  • Trained staff and clear inspection routines
  • Incident response and fire prevention procedures
  • Complaints handling processes
  • Contingency planning for equipment failure or extreme weather
  • Clear routes for reporting non-compliance to the regulator

Waste Acceptance and Recordkeeping

Every load needs correct classification and characterisation before it's accepted. That means checking documentation, confirming the waste matches its stated code and origin, and rejecting anything that doesn't conform to your permit's acceptance criteria.

  • Classify incoming waste against the applicable landfill class (inert, non-hazardous, hazardous)
  • Verify documentation before acceptance, not after
  • Reject prohibited or non-conforming loads and record why
  • Maintain traceability and keep records in the format and retention period your permit specifies

Monitoring That Never Really Stops

Permits typically specify monitoring for groundwater, surface water, leachate, landfill gas, settlement and relevant emissions. Reporting obligations (frequency, format, exceedance thresholds) sit within the permit itself, so check your specific conditions rather than a generic template.

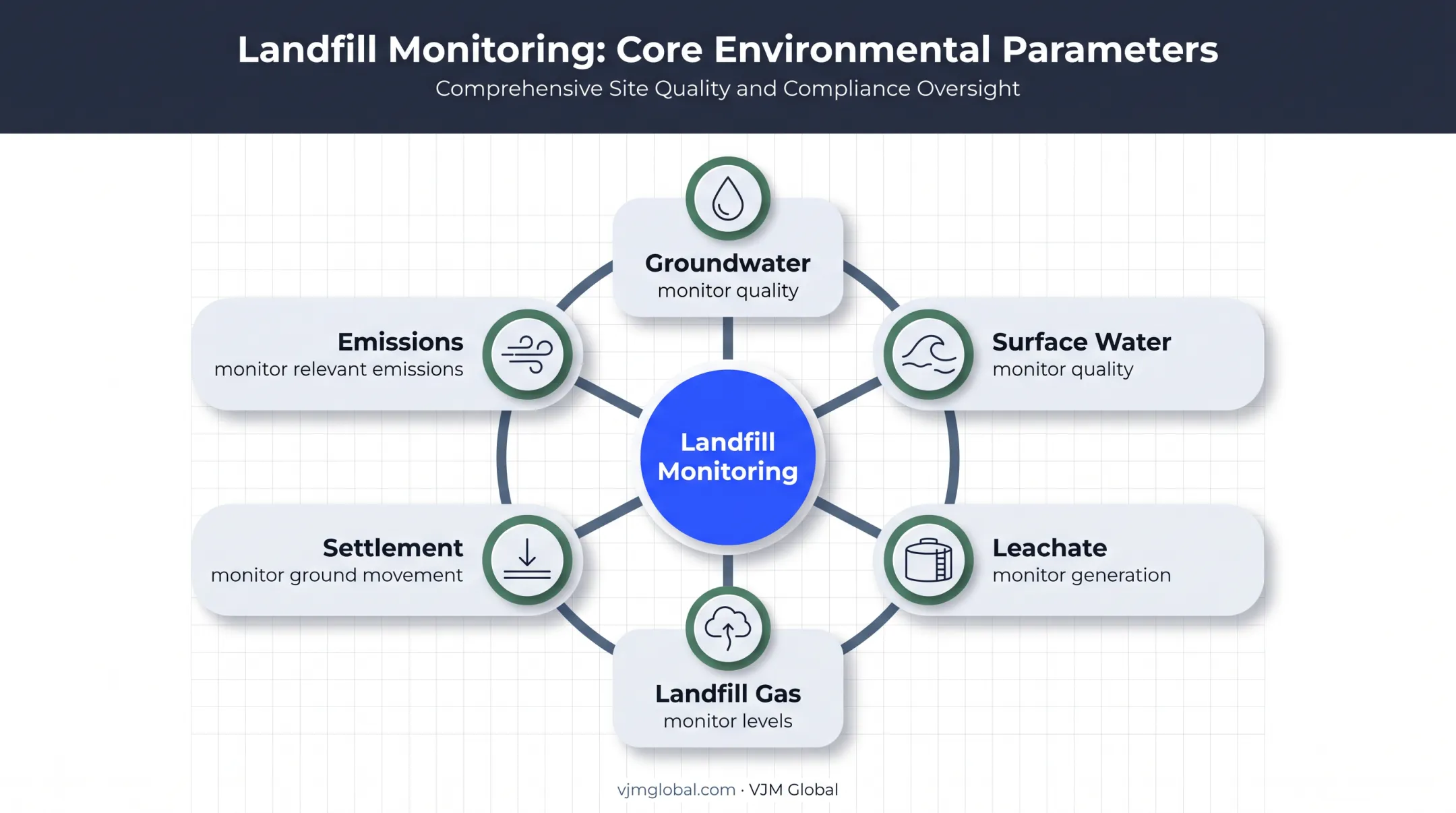

Six landfill environmental monitoring areas operators must track

Closure Is Not the Same as Surrender

This trips up a surprising number of operators. Stopping tipping doesn't end your permit obligations. Restoration, aftercare and continued monitoring of containment systems carry on afterward, sometimes for decades.

Surrender requires:

  • A risk-based surrender report
  • Monitoring and engineering evidence
  • Proof that residual pollution risk meets completion criteria

Only once the regulator accepts this evidence is the permit formally surrendered. Closure and restoration alone don't achieve that outcome.

Historic landfill redevelopment warning: Approaches like the Definition of Waste: Development Industry Code of Practice (DoWCoP) are sometimes assumed to automatically clear site-won soils for reuse. That's not a safe assumption. Treat reuse of potentially contaminated material from a former landfill as a site-specific question for your regulator, not a blanket exemption from permitting risk.

Landfill Restrictions and Regulators Across the UK

There's no single, UK-wide "landfill ban" covering every waste stream. Restrictions depend on waste type, jurisdiction, exemptions and available treatment capacity, and they genuinely differ by nation.

Nation Current restriction position
England Bans liquid waste (other than sludge), certain reactive/infectious wastes, and most whole or shredded tyres; check the full exceptions list for your waste stream
Wales Wood waste is barred from landfill entirely; separated recycling streams face restrictions too
Scotland Biodegradable municipal waste ban began 31 December 2025, though SEPA operates a conditional, temporary non-enforcement position for qualifying material ahead of full effect from 1 January 2028
Northern Ireland PPC permit controls apply; no confirmed exhaustive banned-waste list — check the specific permit conditions with NIEA

Scotland's position is easy to misread: the legal ban date and SEPA's conditional enforcement approach aren't the same thing. If you're relying on that distinction operationally, check SEPA's current landfill ban position directly rather than a second-hand summary.

Restrictions also interact with cost. From April 2026, standard Landfill Tax across England, Northern Ireland, Scotland and Wales sits at £130.75 per tonne, with a lower rate of £8.65 per tonne for qualifying inert waste, according to HMRC's published 2026-27 rates. Paying this tax never substitutes for holding a valid permit. The two obligations run in parallel.

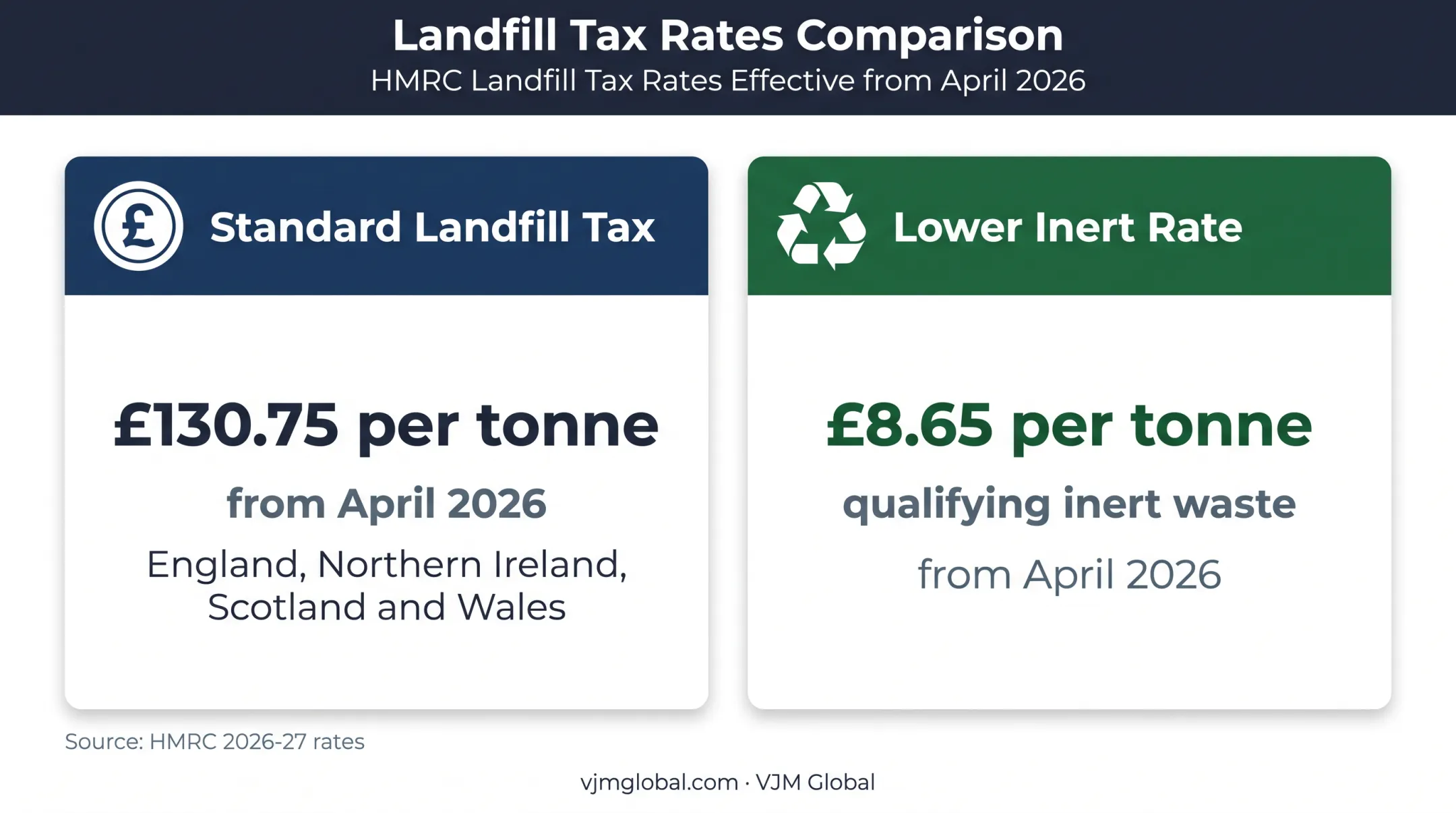

2026 UK landfill tax rates for standard and inert waste

For operators, the practical upshot is this: apply the waste hierarchy before assuming disposal is the default route, and confirm a waste stream is legally acceptable before you transport or accept it.

  • Prevention
  • Reuse
  • Recycling
  • Recovery

This is also where the compliance burden often extends beyond the permit itself. Landfill Tax has to be accounted for correctly in your bookkeeping, filed on time, and reconciled against site records, separate from (but running alongside) the environmental permitting process.

VJM Global supports UK-based waste and landfill operators with the tax accounting, payroll and corporate compliance work that sits alongside permit conditions, so technical teams can focus on the regulator relationship.

Frequently Asked Questions

How do I get a waste disposal licence in the UK?

Identify the specific waste activity and the correct regulator for your nation, then apply for the matching environmental permit. This is separate from waste carrier, broker or dealer registration, so check current national guidance before assuming one covers the other.

Is there a landfill ban in the UK?

Restrictions vary by waste type and nation rather than applying as one blanket ban. Verify current rules, exemptions and transitional arrangements with your relevant regulator before relying on older summaries.

Do I need an environmental permit to operate a landfill in the UK?

Landfill disposal will generally require environmental authorisation. The exact route (bespoke application, variation, or another category) depends on your activity, site and waste streams involved.

Which UK regulator issues landfill environmental permits?

The Environment Agency covers England, Natural Resources Wales covers Wales, SEPA covers Scotland, and the Northern Ireland Environment Agency covers Northern Ireland. Confirm the current application process for your specific nation before applying.

What documents are needed for a landfill environmental permit application?

Core categories include site plans, waste type and quantity data, risk assessments, engineering and monitoring proposals, management systems, and restoration details. Exact requirements vary by regulator, so check their current application forms.

Can an environmental permit for a landfill be surrendered?

Yes, but only through a risk-based process involving closure evidence, aftercare records, monitoring results and proof the site no longer poses an unacceptable pollution risk. Simply stopping operations does not achieve surrender on its own.
