Many applicants run into trouble for reasons that have nothing to do with their actual environmental footprint:
- Applying to the wrong authority
- Submitting incomplete technical information
- Starting regulated activities before approval lands
- Failing to maintain the conditions attached to an approval
This guide covers who needs clearance, what documents and assessments are typically involved, how the application process works, what happens after approval, and how renewals are managed. Requirements change, so always confirm current details against Dubai Municipality's live service information before you submit anything.
Key Takeaways
- Environmental clearance applies based on activity classification and project impact, not company size
- Industrial projects follow an A/B/C assessment route; development projects use mandatory and exclusion lists
- Free zones and special development areas often have their own EHS authority, separate from Dubai Municipality
- Approval conditions continue after issuance, covering waste, emissions, noise, and reporting
- Submit renewal applications at least 30 days before expiry unless the clearance states otherwise
What Environmental Clearance Means and When It Is Required
Environmental clearance is an approval confirming that a proposed project or activity has been reviewed against applicable environmental requirements. It's distinct from a trade licence, a building approval, an EIA report, or a waste-management permit. These are separate instruments that may operate alongside each other, not substitutes for one another.
Dubai Municipality's 2024 guidance describes the clearance as an environmental licence containing project-specific conditions that apply throughout the project's life cycle. For covered development and infrastructure activities, clearance is expected before commencement.
Who Typically Needs to Engage With Dubai Municipality
The activities most likely to require clearance include:
- Industrial and manufacturing operations (paper, petrochemicals, organic waste treatment)
- Construction and infrastructure projects, including fuel-filling stations and waste-to-energy facilities
- Waste and recycling operators
- Selected food or service businesses with environmental impact
- Activities involving emissions, chemicals, or regulated waste
Not every construction project is covered. Some activities, such as an access road within a development or standard labour accommodation, sit on Dubai Municipality's exclusion list. Uncertain cases go through a screening process rather than an automatic requirement.
Why Size Alone Doesn't Decide It
Requirement status depends on activity classification, project scale, location, construction or operational phase, and potential environmental impact, not headcount or revenue. A small dry-cleaning operation and a large petrochemical plant sit in entirely different categories, but both fall under the same classification framework.

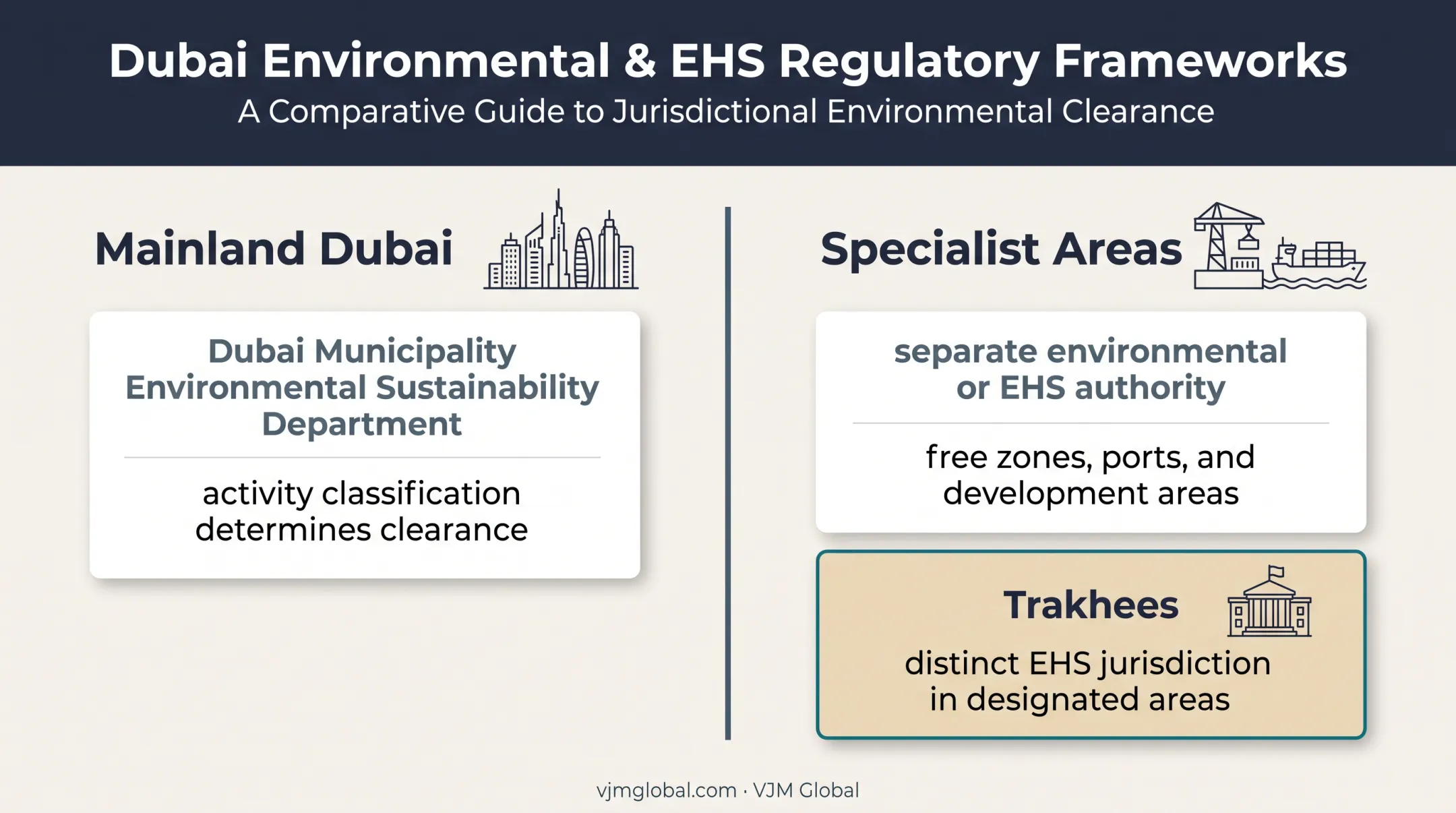

Jurisdiction matters as much as activity type. Mainland Dubai projects generally fall under Dubai Municipality's Environmental Sustainability Department. Free zones, ports, and specialist development areas can have a separate environmental or EHS authority.
Trakhees, under the Ports, Customs and Free Zone Corporation, holds a distinct EHS jurisdiction over its own designated areas, so a licensing address alone doesn't settle which authority you're dealing with. Confirm the competent authority for your specific site before preparing anything.
Operating without a required clearance can expose a business to corrective action notices, fines, or other enforcement measures once Dubai Municipality identifies the activity. Not every business operating in Dubai automatically requires the same certificate. The trigger is the activity and its classification, not blanket geography.

Documents and Technical Requirements
Document needs vary by activity, but most applications draw from a common pool. Always verify the exact list with Dubai Municipality before submission.
Corporate and licensing documents typically include:
- Valid Dubai trade licence, or initial approval and trade-name reservation for new or amended licences
- Company memorandum and commercial register details
- Owner-to-applicant appointment letter where someone other than the licence holder applies
Site and tenancy documents typically include:
- Tenancy contract or affection plan matching the project location
- Site layout or master plan where specified
- For major industrial EIARs, a location map showing sensitive receptors within one kilometre of the site
The Technical Information Authorities Ask For
Beyond paperwork, Dubai Municipality needs a clear picture of on-site operations:
- Process or service descriptions and operating hours
- Machinery, equipment, and workforce numbers
- Production or service volumes
- Raw materials, chemicals, fuels, and hazardous substances
- Storage arrangements and transport or handling procedures
On the environmental baseline side, expect requests covering air emissions, wastewater, solid and hazardous waste, noise, odour, and energy use. Construction projects also need build-phase impact details.
When a Full EIA Is and Isn't Required
Not every applicant submits a full Environmental Impact Assessment. Dubai Municipality's industrial framework sorts activities into three tiers:
| Category | Assessment required |
|---|---|
| A (major) | Full Environmental Impact Assessment Report (EIAR) |
| B (medium) | EIA Summary Report (EIAS) |
| C (light) | EIA Checklist |
Development and infrastructure projects instead use mandatory and exclusion lists, with case-by-case screening for anything unclassified.
A credible EIA submission generally covers:
- Project purpose and alternatives
- Site conditions and impact identification
- Mitigation measures and assigned responsibilities
- Monitoring indicators
- Incident response procedures for construction and operational phases
Before you submit, cross-check consistency across every document:
- Trade licence activity matches the process description
- Site plans match the tenancy contract
- Equipment list matches what's described in the process flow
- Chemical inventory matches storage and handling details
- Waste plan matches the EIA's predicted waste streams
Mismatched details between these documents are one of the most common triggers for clarification requests, which adds weeks to a timeline that didn't need to be long.

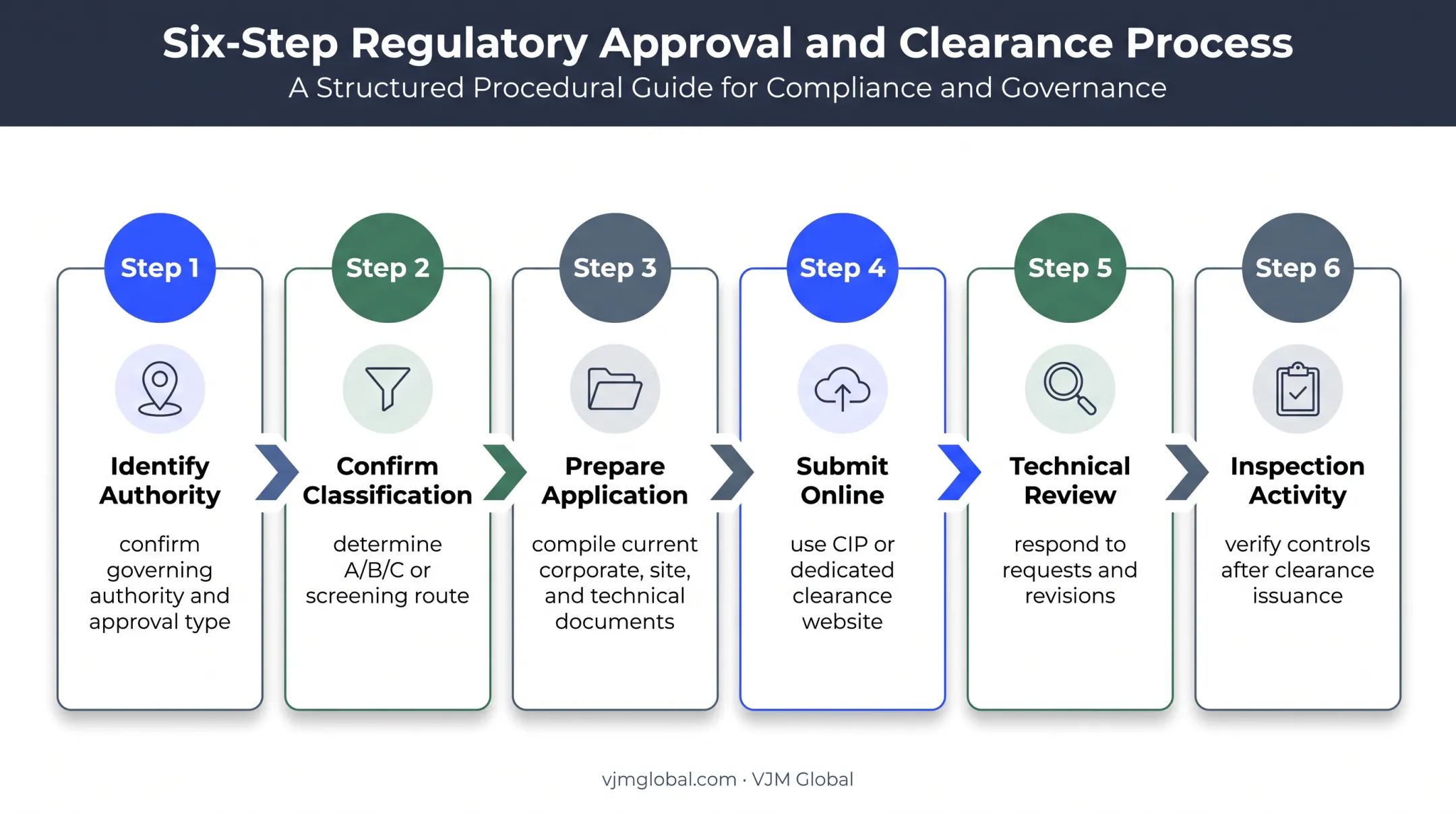

How to Apply for Environmental Clearance in Dubai Municipality
The process is activity-dependent, so the first task is figuring out which route applies to your project.
- Identify the authority and approval type. Confirm whether Dubai Municipality or a zone-specific authority like Trakhees governs your site, then check whether your activity falls under the industrial A/B/C framework or the development/infrastructure screening process.
- Confirm your classification. For an unclassified or uncertain development project, Dubai Municipality's screening checklist and supporting documents can be sent to its EIA review channel, which will determine whether an EIAR, EIAS, more information, or no assessment at all is needed.
- Prepare your application. Compile corporate, site, licensing, technical, and environmental documents in the current required format. Use up-to-date versions of every form, and identify authorised signatories or appointed environmental consultants where the submission calls for one.
- Submit online. Industrial projects typically go through the CIP Online EC Application System; development and infrastructure projects use the dedicated website request for environmental clearance. Upload supporting documents and pay any published fee where applicable. Fees are charged in UAE dirhams and vary by application type, so confirm the current rate with the service rather than an old quote.
- Respond to technical review. Reviewers may come back asking for a full EIA, revised drawings, additional pollution-control details, waste-management arrangements, or evidence of coordination with other Dubai authorities.
- Expect inspection activity. Site visits in Dubai Municipality's framework are mostly documented after clearance issuance, used to verify that actual controls match the approved assessment, not as a universal pre-approval step for every application.

What the Approval Outcome Looks Like
You'll receive one of four outcomes: clearance, clearance with conditions, a request for amendments, or a refusal requiring redesign and resubmission. Read any approval carefully for its validity period, the exact scope of activity it covers, monitoring duties, and reporting requirements. Those conditions don't disappear once the certificate is issued.
On timelines: Dubai Municipality's published evaluation targets are 10, 5, and 3 working days for industrial categories A, B, and C respectively, and 20 and 15 working days for development EIAR and EIAS reviews. These are stage-specific response periods, not guaranteed submission-to-certificate timelines. Revisions, missing documents, and payment delays all add time on top.
Foreign investors setting up in the UAE often juggle this process alongside entity formation, payroll setup, and tax registration at the same time.
VJM Global supports clients establishing a presence in the UAE across mainland, free zone, and offshore structures, helping organise the broader business setup and compliance documentation that typically runs in parallel with an environmental clearance application. That support covers document organisation and coordination. It does not extend to Dubai Municipality's own approval authority, and no outcome should ever be presented as guaranteed.
Ongoing Compliance, Monitoring, and Renewal
Clearance approval is not the end of the process. It locks in the approved activity, process, site, equipment list, and capacity, and the business must stay inside those boundaries.
Practical controls that keep an operation compliant:
- Waste segregation and disposal through authorised handlers
- Chemical and hazardous-material storage meeting approved conditions
- Functioning pollution-control equipment and wastewater handling
- Noise and odour controls matching the approved assessment
- Spill response procedures and maintenance records kept up to date

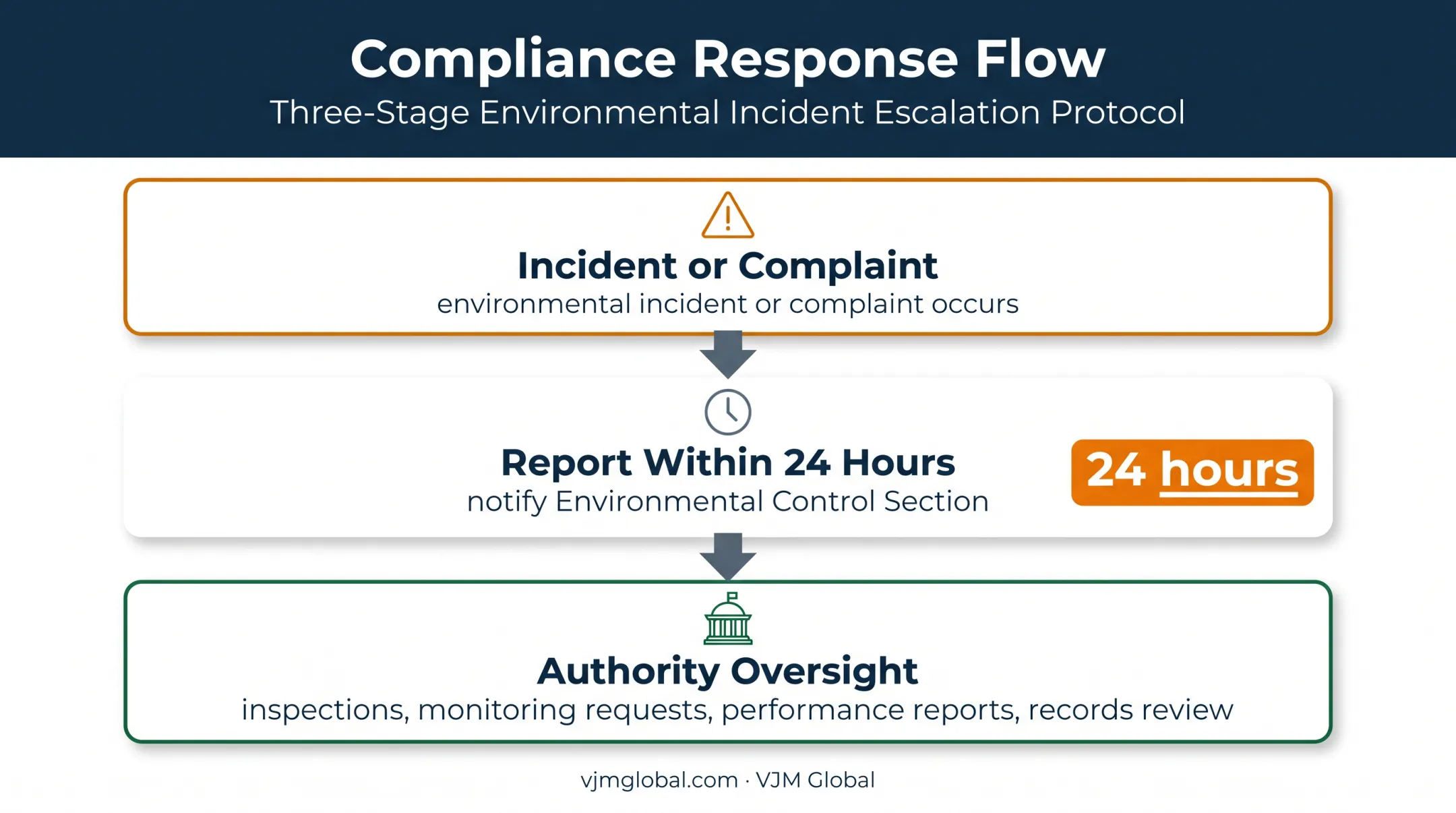

Dubai Municipality's industrial conditions require environmental incidents or complaints to be reported to its Environmental Control Section within 24 hours. Authorities may also inspect sites, request monitoring or performance reports, and review environmental records at any time.

Confirm current inspection frequency and reporting deadlines from official sources before you rely on prior practice.
Changes That Require Prior Approval
Several scenarios typically need an amendment or reassessment before they happen, not after:
- Relocation or expansion of the operation
- New machinery or significant process changes
- Increased production capacity
- New chemicals or altered waste streams
- Changes in ownership or licensed activity
Apply for amendments at least 30 days before the proposed change where possible.
Renewal Timing and Expiry
Each clearance states its own expiry and renewal conditions. There is no single standard validity period across all certificates.
Unless the document says otherwise, submit renewal applications at least 30 days before expiry, with updated reports or audits where required. Treating an expired clearance as automatically continuing is a violation, not a grey area.
Common Mistakes and Practical Preparation Tips
Most clearance problems trace back to a handful of recurring errors:
- Assuming a trade licence replaces the need for environmental approval
- Applying to the wrong authority for the site's actual jurisdiction
- Using an activity description that doesn't match the trade licence
- Omitting waste or chemical details from the technical submission
- Submitting site documents that don't match the tenancy contract
- Starting fit-out or operations before the required approval arrives
A pre-submission review should cross-check:
- Licence activity against the process description
- Tenancy and location details against the site plan
- Equipment list against the chemical inventory
- Waste streams and emissions against proposed mitigation measures
- Working hours against noise and odour assumptions in the EIA
Keep every submission receipt, approval letter, technical report, inspection record, monitoring result, and piece of correspondence on file. These records demonstrate ongoing compliance if a question comes up later.
For complex industrial, infrastructure, or high-risk construction projects involving modelling, baseline studies, or specialist audits, an environmental consultant is usually worth the cost.
Always confirm current fees, forms, and timelines directly with Dubai Municipality or the relevant zone authority rather than relying on a checklist that might be out of date.
Conclusion
Dubai's environmental clearance process is project- and activity-specific. It isn't a universal substitute for a trade licence or other operational permits, and it doesn't apply identically to every business operating in the emirate.
The practical sequence holds up across most cases:
- Identify the correct authority
- Classify the activity
- Prepare consistent corporate and technical documents
- Submit through the current channel
- Respond properly to review comments
- Maintain every condition after the certificate is issued
If you're setting up a project in Dubai as a foreign investor, verify these requirements early rather than after signing a lease or ordering equipment. Where the broader business setup is complex, pairing environmental compliance planning with professional support on entity formation, documentation, and coordination often prevents costly delays once operations begin.
Frequently Asked Questions
How do I get an environmental clearance certificate from Dubai Municipality?
Classify the activity, prepare the required documents and any EIA, then submit through Dubai Municipality’s online service. Address review comments or inspections, pay the fees, and collect the certificate once approved—always confirm current requirements first.
Is environmental clearance mandatory?
It's mandatory when the relevant activity, project type, location, or environmental risk profile triggers the requirement under Dubai Municipality's classification framework. Free zones and specialist authorities may apply different procedures for the same activity.
What is meant by environmental clearance?
It's an authority approval confirming that a project's environmental risks have been assessed and that any required controls or conditions have been addressed before specified development or operations proceed.
Which businesses need environmental clearance in Dubai?
Industrial, manufacturing, construction, infrastructure, waste, and recycling operators typically need it, along with other activities involving emissions, chemicals, wastewater, noise, or regulated waste, depending on the applicable classification.
What documents are required for environmental clearance in Dubai?
Expect trade licence and corporate papers, site or tenancy records, process and equipment details, chemical inventories, waste-management plans, and EIA or pollution-control reports if required. The exact list depends on the activity and authority.
How long does environmental clearance take in Dubai?
Timing depends on complexity, document completeness, EIA scope, comments, and inspections. Published targets often run 3–20 working days by category—confirm the current estimate with the relevant authority.
