Environmental Permit Application Process in the UAE (2026) An environmental permit in the UAE is a regulatory approval that allows a proposed activity, facility, project, or development to proceed, subject to specific environmental conditions set by the competent authority. That single sentence hides a lot of complexity.

This guide is for foreign investors, startups, contractors, developers, and industrial operators planning activity in any UAE emirate in 2026. Getting environmental approval wrong doesn't just risk a fine. It can delay fit-out, block a trade license renewal, or halt operations entirely.

Environmental permitting gets lumped in with trade licensing and "environmental clearance" as if they're interchangeable. They're not. The responsible authority, the permit category, whether a study is required, and the document list all shift depending on the emirate, the activity, and the risk level involved.

This article walks through how to identify the right authority, determine whether an environmental impact assessment applies, prepare a submission, handle review and inspection, and stay compliant once you're approved.

Key Takeaways

  • Permit requirements hinge on environmental impact (air, water, waste, noise, hazardous materials), not company size.
  • Correct permit route depends on your emirate, free zone, and activity under federal plus local rules.
  • Trade licenses, environmental permits, and Civil Defence approvals are separate requirements, each with its own process.
  • Start environmental screening before signing a lease or beginning fit-out, not after.
  • Confirm 2026 fees, timelines, and renewal cycles with the relevant authority before you apply.

What Is an Environmental Permit and Why Is It Required in the UAE?

An environmental permit, environmental license, or equivalent approval is the regulator's authorization for a specific activity or project to operate under defined environmental controls. It exists to catch foreseeable impacts before they happen, require mitigation up front, and give the authority a legal basis to monitor and enforce compliance afterward.

It's easy to confuse this with other approvals that sound similar:

  • A trade license authorizes your business activity legally. It says nothing about emissions, waste, discharge, or hazardous-material storage.
  • An environmental clearance (EC) or NOC often confirms a project can proceed at the planning stage; a separate permit may then impose ongoing operational conditions.
  • An EIA, IEE, or screening report is evidence used to assess impact. It's rarely the permit itself.

Requirements vary enormously by activity. An administrative office with no industrial process typically carries minimal environmental risk. A restaurant with a grease trap and food waste, a workshop generating used oil, and a warehouse storing chemicals each sit on a different risk tier. A major infrastructure project sits higher still, and each triggers distinct documentation requirements.

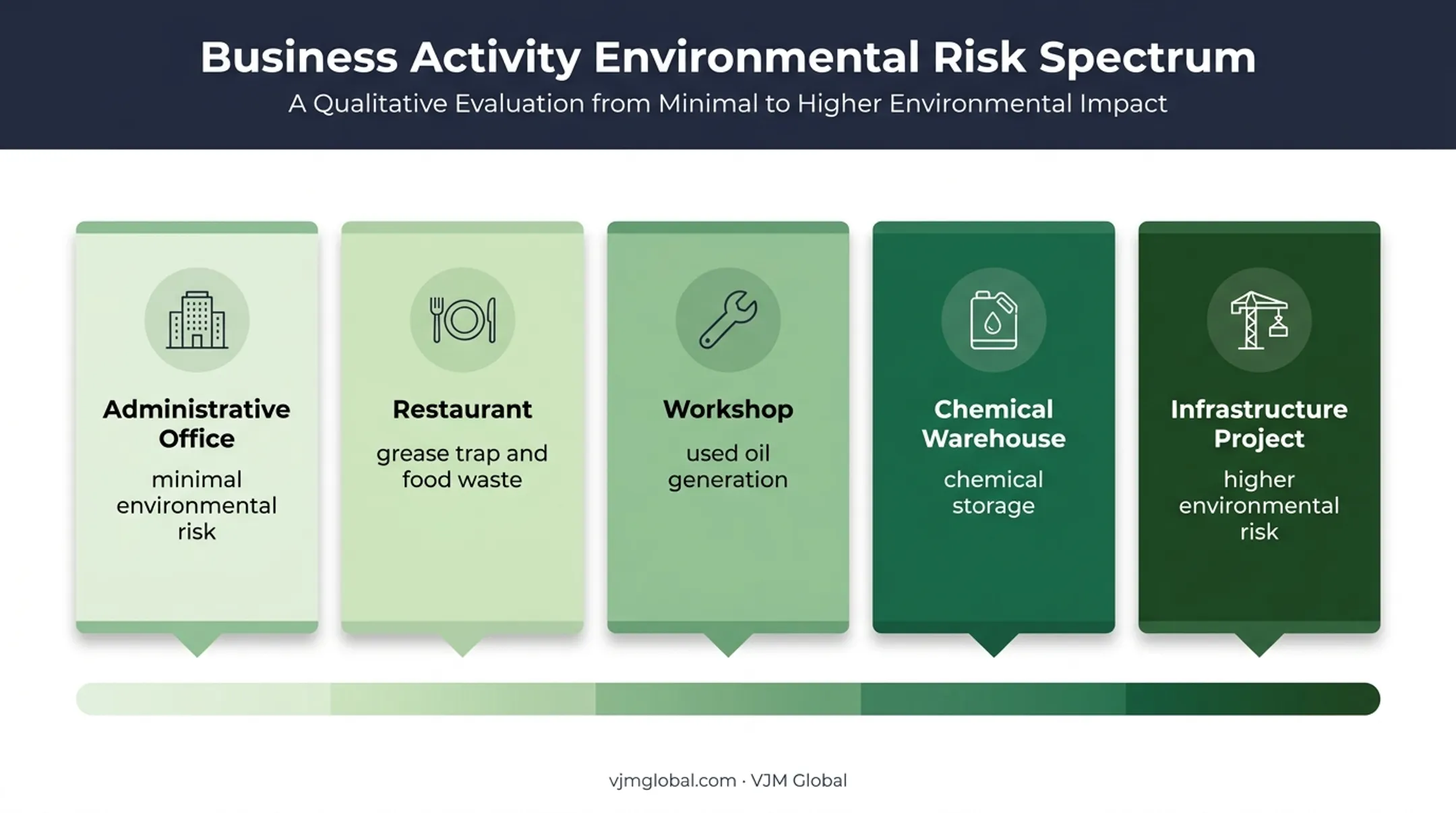

Five UAE activity types arranged by environmental risk level

The Legal Backbone

Federal Law No. 24 of 1999 on the Protection and Development of the Environment remains the foundational federal framework, with Articles 3 and 4 requiring that projects likely to harm the environment be assessed and licensed before activity begins. This is confirmed as active legislation on the UAE Legislation portal.

On top of this baseline, several newer instruments apply to specific activities rather than every business:

  • Federal Law No. 12 of 2018 on integrated waste management, with its implementing Cabinet Resolution No. 39 of 2021, requiring EIA approval before licensing new landfills.
  • Federal Decree-Law No. 11 of 2024 on reducing climate change effects, active from May 2025, which extends to free zones and requires emissions reporting from designated sources.
  • Federal Law No. 5 of 2025, effective January 2026, governing international trade in endangered species and assigning the Ministry of Climate Change and Environment (MOCCAE) as the CITES certification authority.

Treating environmental approval as paperwork you'll sort out later is a costly mistake. Operators who skip screening commonly face delayed fit-out, rejected applications, redesign costs, failed inspections, or suspension of related licenses.

How the UAE Environmental Permit Application Process Works

The sequence below reflects how most emirates structure their review. The exact portal, forms, fees, and study requirements must still be confirmed with your specific authority.

Step 1: Classify the Activity and Confirm the Premises

Define the following before applying:

  • Legal business activity, process, and facility type
  • Site location, scale, and proximity to sensitive areas
  • Materials used, emissions, and waste streams

Before signing a lease or starting fit-out, verify the premises is zoned appropriately. This matters most for manufacturing, food service, workshops, storage, construction, and chemical-handling operations.

Step 2: Identify the Authority and Screening Route

Determine whether your application goes to an emirate municipality, environmental agency, free-zone authority, federal body, or some combination. High-impact activities, cross-emirate operations, protected-area proximity, or anything involving pesticides or transboundary waste may pull in additional federal or specialist review.

Dubai's current guidance, for instance, divides industrial projects into three assessment tracks:

  • Category A (major impact): requires a full Environmental Impact Assessment Report
  • Category B (medium impact): requires an EIA Summary
  • Category C (light impact): requires an assessment checklist

This structure is set out in Dubai Municipality's 2024 Environmental Clearance guidance. The guidance also notes that administrative offices generally don't need an EC on that basis alone, but must obtain one before commencing any industrial activity at the same premises.

Step 3: Prepare the Technical and Corporate Documents

Expect to assemble:

  • Application form and trade-license information
  • Project description, site plans, and process flow diagrams
  • Equipment details and raw-material/chemical inventory
  • Emissions, waste, and discharge estimates
  • Mitigation measures and emergency response procedures
  • Lease or land documents and responsible-person details

Higher-risk projects may need baseline environmental data, modeling, specialist surveys, or a study prepared by a consultant accepted by the relevant authority.

Step 4: Submit and Respond to Regulatory Review

Most authorities now run submissions through an online portal or service center. Expect a completeness check, technical review, clarification requests, and fee payment, sometimes alongside coordination with municipal, waste, health, or Civil Defence bodies. Track your application reference, answer queries consistently, and never change the activity, site, or process without notifying the authority first.

Step 5: Inspection, Decision, and Permit Conditions

Site inspections verify that layout, storage, ventilation, pollution controls, and emergency measures match what was approved on paper. Approval may be unconditional, conditional, time-limited, or staged. Read every condition before starting operations. Conditions often include ongoing monitoring obligations that aren't obvious from the application stage.

Step 6: Operate, Monitor, Renew, and Report

Ongoing duties typically include emissions or effluent monitoring, authorized waste transfer, equipment maintenance, incident reporting, and periodic renewal. Dubai's guidance, for example, requires environment-related incidents to be reported within 24 hours and EC renewal applications at least 30 days before expiry, unless the EC states otherwise.

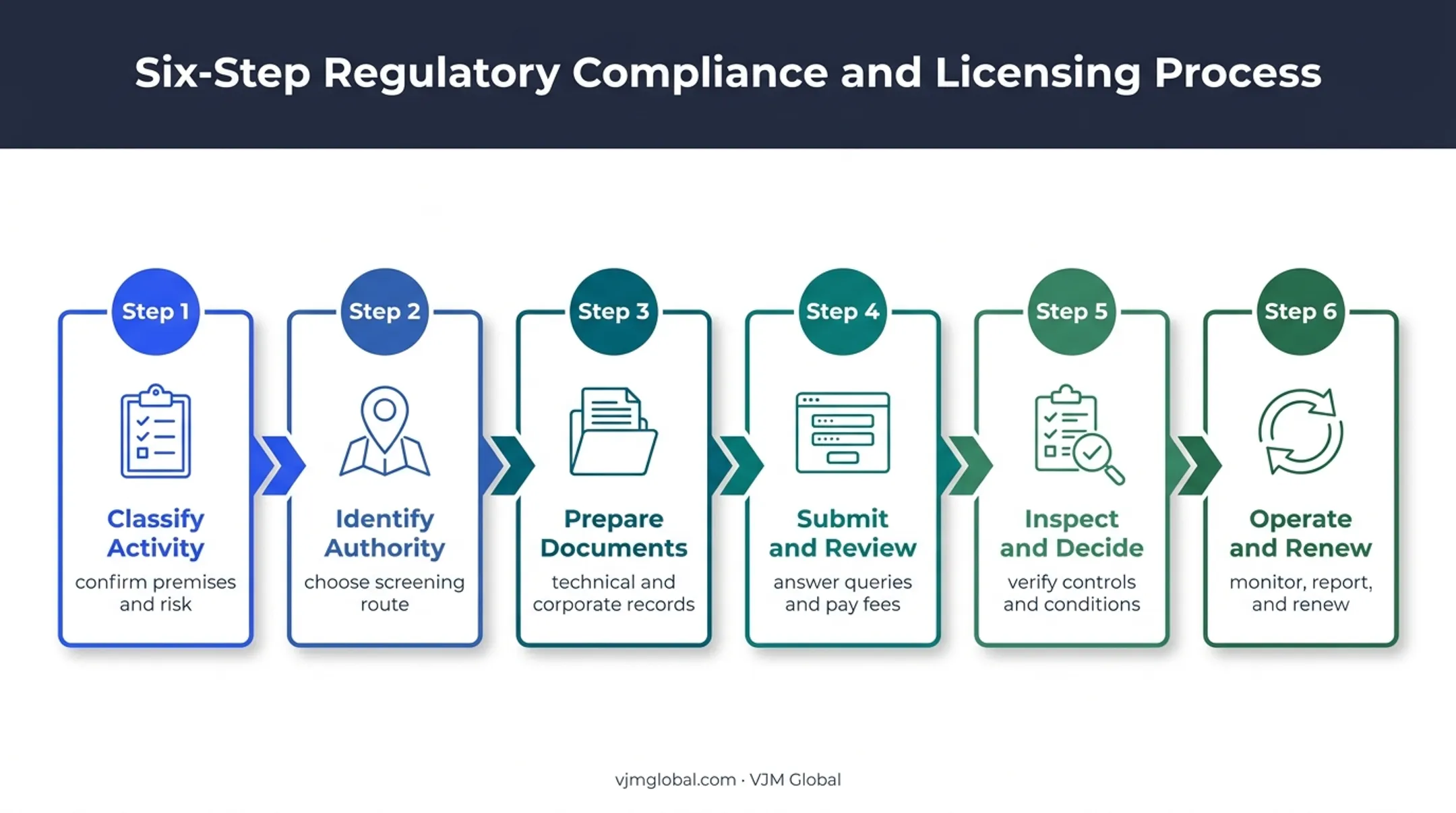

Six-step UAE environmental permit process from classification to renewal

Validity periods, reporting frequency, and penalties differ by authority and activity. Verify current figures directly with your regulator rather than assuming a standard timeframe applies.

Where Environmental Permits Apply and Which Authority Is Responsible?

There's no single national counter for environmental permits in the UAE. Responsibility depends on the emirate, whether you're mainland or free zone, the activity type, and the environmental risk involved.

Emirate Authority to Confirm With
Dubai Dubai Municipality, Environmental Sustainability Department, plus relevant free-zone channels
Abu Dhabi Environment Agency – Abu Dhabi (EAD), which issues industrial-facility licences via the TAMM portal
Sharjah Sharjah City Municipality's environmental-permit service and the Environment and Protected Areas Authority (EPAA)
Ajman Ajman Municipality & Planning Department
Ras Al Khaimah Environment Protection and Development Authority (EPDA)
Fujairah Fujairah Environment Authority (FEA)
Umm Al Quwain Department of Umm Al Quwain Municipality

Abu Dhabi's industrial licensing process is a useful example of how specific these requirements get. EAD's service on the TAMM platform requires an existing industrial licence and a process-flow diagram before it will even log an application — details that differ from what Dubai or Sharjah ask for.

Common triggers that bring an activity under environmental regulation include:

  • Air emissions or wastewater discharge
  • Hazardous-substance storage or handling
  • Waste generation, transport, or disposal
  • Construction and demolition work
  • High-noise operations near residential areas
  • Food service operations with grease or organic waste

Free-zone status doesn't exempt you from environmental controls. A free zone may run its own approval process, but it typically still applies municipal, federal, or technical standards underneath. DMCC's HSE Regulations are one example of a zone-specific framework layered on top of, not instead of, broader requirements.

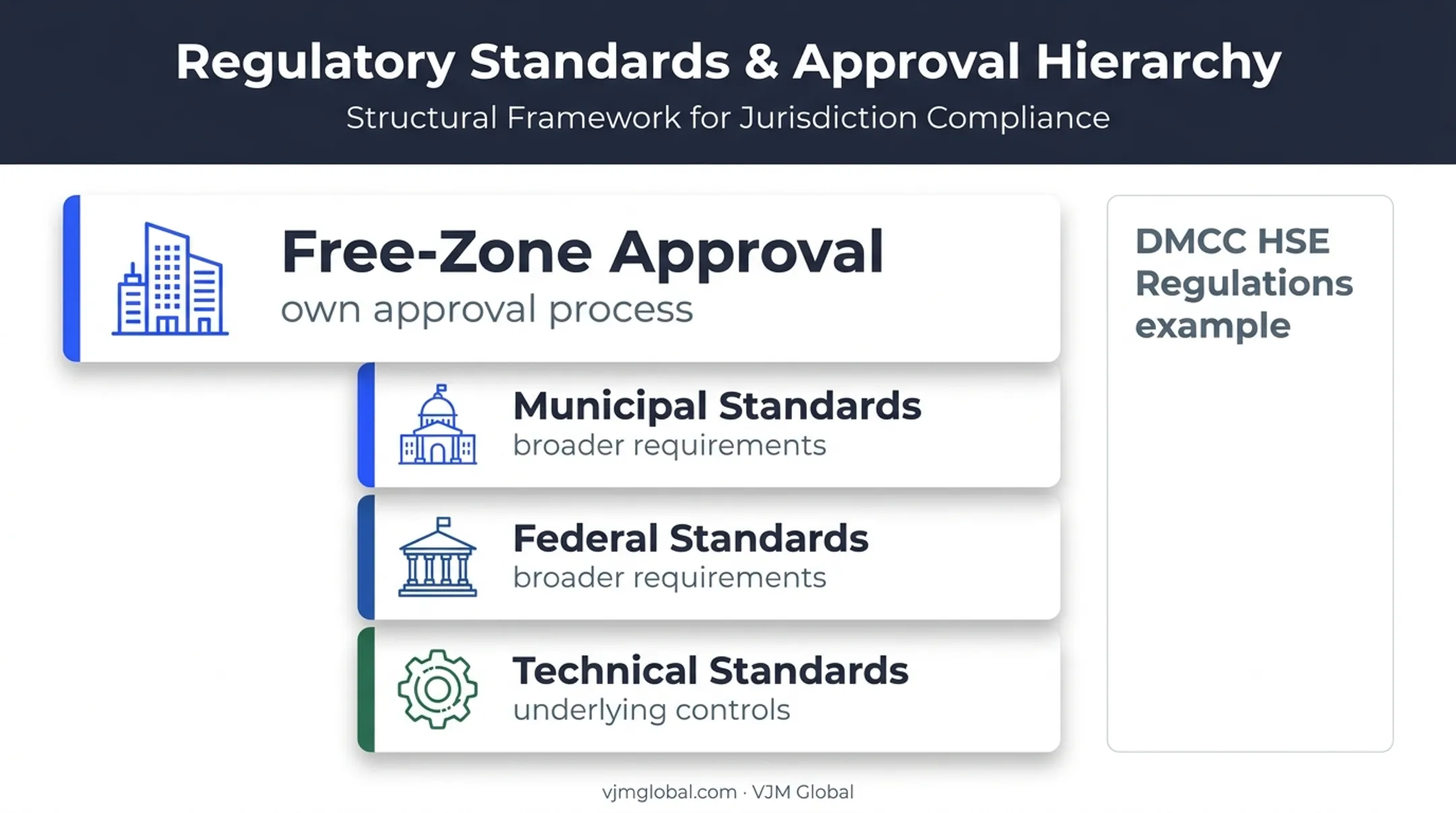

UAE free-zone environmental regulation framework layered by authority

Before applying anywhere, confirm four points with the authority:

  • Is the activity regulated?
  • Which permit or clearance applies?
  • Is a technical study required, and must it come from an approved consultant?
  • Must approval come before lease, fit-out, import, or operations begin?

For foreign investors setting up in the UAE, coordinating entity formation, tax, and compliance timelines with an adviser like VJM Global can keep the broader setup aligned. UAE-specific technical studies and authority submissions still need direct confirmation from the relevant local regulator or a qualified environmental professional in the UAE.

Key Factors, Documents, Ongoing Compliance, and Common Mistakes

Factors that affect your application outcome:

  • Activity classification and facility size
  • Emirate, free zone, and site zoning
  • Raw materials and hazardous substances used
  • Emissions, wastewater, and waste volumes
  • Proximity to communities or ecologically sensitive areas
  • Proposed mitigation controls

Documentation quality matters as much as quantity. Your project description, drawings, process flow, chemical inventory, and licensed activity should all reference the same names, capacities, and locations. Inconsistencies between documents are one of the fastest ways to trigger extra review rounds.

Keep these records on file after approval:

  • Permit and renewal certificates
  • Inspection reports and corrective-action closures
  • Waste transfer notes from authorized contractors
  • Laboratory results and equipment calibration logs
  • Incident reports and staff training records

Even with these records on file, a few misconceptions still catch applicants off guard:

Common misconceptions worth correcting:

  • A trade license does not replace an environmental permit.
  • An EIA isn't required for every business — but confirm this in writing rather than assuming exemption.
  • Approval in one emirate doesn't transfer to another.
  • Free-zone incorporation doesn't eliminate environmental duties.
  • The permit marks the start of ongoing compliance obligations that continue well past approval day.

These assumptions often lead straight to the process errors below.

Mistakes that create avoidable delay:

  1. Applying to the wrong authority for the location or activity
  2. Signing a lease before confirming the premises is suitable
  3. Starting fit-out before approval is granted
  4. Omitting waste or chemical details from the application
  5. Using a consultant not accepted by the authority
  6. Missing an inspection condition after approval

Requirements, fees, portals, and enforcement policies shift. Always check current official sources before submitting in 2026 rather than relying on last year's guidance.

Conclusion

The UAE's environmental permit process links activity classification, site suitability, assessment, documentation, review, inspection, and ongoing monitoring into one risk-based pathway. Identifying the responsible emirate or free-zone authority early matters just as much as preparing the application itself — the wrong classification or submission route creates delay that's entirely avoidable.

Low-impact businesses should confirm, in writing, whether approval is even needed. Regulated or high-impact projects should plan environmental requirements before leasing, construction, importing, or operating begins. Guessing is the most expensive option on the table.

Frequently Asked Questions

How do I comply with an environmental permit in the UAE?

Follow each permit condition, maintain required controls and records, complete monitoring or reporting on schedule, use authorised waste routes, and renew on time. Check your issuing authority's current conditions directly, as they vary by permit.

How do I get an environmental clearance certificate from Dubai Municipality?

Confirm your activity and premises route with Dubai Municipality first, then prepare the required plans and environmental documents. Submit through the current official channel and respond to any review comments or inspection requirements before approval.

What are the main environmental laws in the UAE?

Federal Law No. 24 of 1999 forms the foundational framework, supplemented by waste, climate, and species-trade legislation that applies to specific activities. Verify current federal and emirate-level regulations, since implementing rules update regularly.

What is the environmental authority in the UAE?

Responsibility is distributed across federal bodies, emirate-level agencies, and free-zone authorities. Examples include Dubai Municipality and the Environment Agency – Abu Dhabi, but no single authority handles every application.

What documents are required for an environmental permit application in the UAE?

Expect to submit a project description, site and layout plans, process details, materials and emissions information, waste and mitigation plans, and ownership or lease documents. An EIA or technical report may also be required depending on the activity.

How long does it take to obtain an environmental permit in the UAE?

Timing depends on activity risk, authority, and how complete your submission is. Dubai's published guidance cites 10, 5, and 3 working days for its three industrial review tracks, but get a current written estimate from your specific authority rather than assuming a universal timeline.
