Environmental Clearance in India: Process and Requirements Environmental Clearance (EC) is the prior regulatory approval required in India before specified projects, expansions, or modernisation activities that could significantly affect the environment can proceed. It isn't optional paperwork. It's a legal precondition for construction, operations, or scaling up in sectors ranging from mining and power to large-scale manufacturing and infrastructure.

This guide is written for Indian project proponents, foreign investors, infrastructure developers, manufacturers, and compliance teams handling mining, power, and industrial projects. Getting the correct approval before work begins sits at the centre of lawful project development in India. Skip it, and you risk delays, penalties, or a stalled project.

EC gets mentioned constantly in business circles, yet how it actually works, who needs it, what triggers it, and how it differs from related approvals, remains widely misunderstood. This article walks through applicability, the step-by-step process, documentation, authorities involved, related clearances, and what happens after approval is granted.

Key Takeaways

  • Check EC applicability against category, scale, expansion, location, and EIA Notification, 2006 conditions
  • Follow screening, scoping/ToR, impact assessment, public consultation, appraisal, then the final decision
  • Gather technical, land, environmental, and pollution-control documents before filing on PARIVESH
  • Treat EC as separate from CTE, CTO, forest, wildlife, and CRZ clearances
  • Confirm current thresholds, fees, and authorities on official sources before you submit

What Is Environmental Clearance and Why Is It Required?

Environmental Clearance is a regulatory decision based on the likely environmental impact of a proposed project, or a specified change to an existing one. The authority issuing EC isn't rubber-stamping a project. It's weighing predicted impacts against acceptable limits before giving a green light.

The process exists to catch problems early. It identifies foreseeable impacts on air, water, soil, forests, and communities, then requires the proponent to build in avoidance measures, mitigation plans, monitoring systems, and an environmental management plan before a single brick gets laid.

The Legal Framework

EC in India flows from a specific legal chain:

  • Environment (Protection) Act, 1986 gives the central government power to take environmental-protection measures
  • EIA Notification, 2006 (S.O. 1533(E)), issued under this Act, makes prior EC mandatory for covered new projects and specified expansions or modernisations. Review the original EIA Notification, 2006 for the governing text
  • Subsequent amendments have changed appraisal committees, exemptions, and procedural timelines repeatedly since 2006. Always check the latest consolidated version before relying on a specific clause

Which Projects Fall Under EC, and What Doesn't

Broad categories that may require EC include:

  • Mining and mineral processing
  • Thermal and other power projects
  • Large manufacturing units
  • Infrastructure such as highways and ports
  • Area-development or building projects crossing specified built-up thresholds

This list isn't exhaustive, and thresholds shift. A project that was exempt last year could require EC today because of a schedule amendment. Verify your specific Schedule entry rather than assuming based on a general category.

EC Is Not the Same as EIA or Pollution Consent

Two distinctions trip up a lot of first-time applicants:

  • EIA vs EC: an Environmental Impact Assessment is the technical study that feeds into the decision. EC is the approval itself, issued after the authority reviews that study (where one is required) along with other submissions
  • EC vs CPCB/SPCB consent: Environmental Clearance has nothing to do with Consent to Establish or Consent to Operate issued by state pollution control boards. These are separate approvals under different laws, and most projects need both

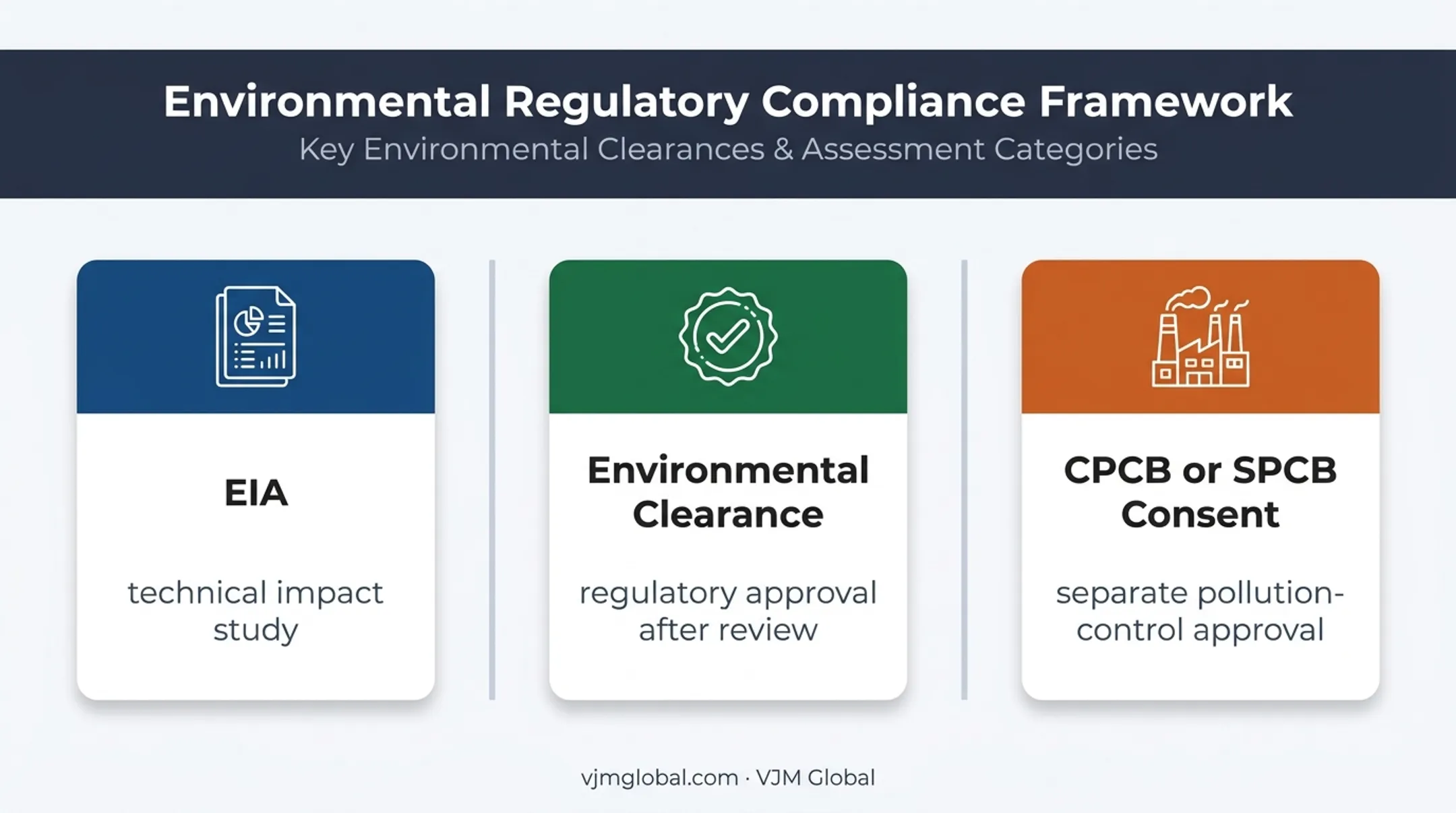

Environmental Impact Assessment versus clearance and pollution consent comparison

How the Environmental Clearance Process Works

The EC process isn't an identical six-step checklist applied to every project. The applicable authority, category, portal requirements, and procedural rules depend on your specific project. Confirm these before you submit anything.

Step 1: Preliminary Project and Site Assessment

Before determining whether you need EC at all, define the basics: project capacity, products or activities, land requirement, utilities, resource consumption, pollution sources, waste streams, expansion plans, and proposed location.

Site screening matters just as much as project specs. Check whether your site sits near:

  • Protected or ecologically sensitive areas
  • Forests, wetlands, or wildlife habitats
  • Coastal zones
  • Water bodies or settlements
  • Heritage or archaeological sites

Use official maps and government records for this. Don't rely on assumptions about what counts as "sensitive."

Step 2: Screening and Categorisation

Authorities assess your project against the Schedule to the EIA Notification, which sets thresholds, location conditions, and category requirements. Category A proposals go to the central Ministry of Environment, Forest and Climate Change; Category B proposals are typically handled by the State Environment Impact Assessment Authority (SEIAA).

Within Category B, there's a further screening split:

  • B1 projects require a full EIA
  • B2 projects do not require an EIA report, but this is not an exemption from EC itself

Categorisation rules change through amendments and court directions, so verify current status for your specific project type.

Step 3: Scoping, Terms of Reference, and Studies

For Category A and B1 projects, the appraisal committee issues Terms of Reference, the framework for your EIA study. Scoping identifies which issues and studies actually need addressing for your project, rather than applying a generic template.

Studies typically cover:

  • Baseline environmental data and impact prediction
  • Alternatives and risk assessment
  • Environmental management plan
  • Resource and waste management planning
  • Rehabilitation or community measures, where relevant

Step 4: Public Consultation, Where Applicable

Public consultation gives affected communities and other stakeholders a chance to review project details and raise concerns before appraisal. It typically includes a public hearing near the project site plus a window for written responses from other stakeholders.

Not every project goes through this stage. Certain categories, including all B2 projects and some specified exemptions, skip public consultation. That said, skipping consultation doesn't mean skipping EC altogether. Confirm your project's exact consultation requirement before assuming either way.

Step 5: Online Application and Scrutiny

Applications go through PARIVESH, the central portal for environmental, forest, wildlife, and CRZ clearances. The PARIVESH 2.0 registration process involves registration, e-KYC verification, and electronic submission of the project along with supporting documents, maps, studies, and fee details.

Once submitted, the authority scrutinises the application. They may request additional information, seek clarifications, conduct a site visit, or return the application for correction if it's incomplete.

Step 6: Appraisal and Decision

The relevant Expert Appraisal Committee or State Expert Appraisal Committee reviews the complete application and recommends an outcome to the decision-making authority (central or state, depending on category).

Possible outcomes include:

  • Grant of EC with specific conditions attached
  • Request for further information or revisions before a decision
  • Deferral pending additional clarity
  • Rejection, with reasons documented

Approval isn't the finish line. Post-approval conditions, monitoring obligations, and reporting requirements need careful attention. Breaching them can trigger enforcement action, suspension, or cancellation of the clearance itself.

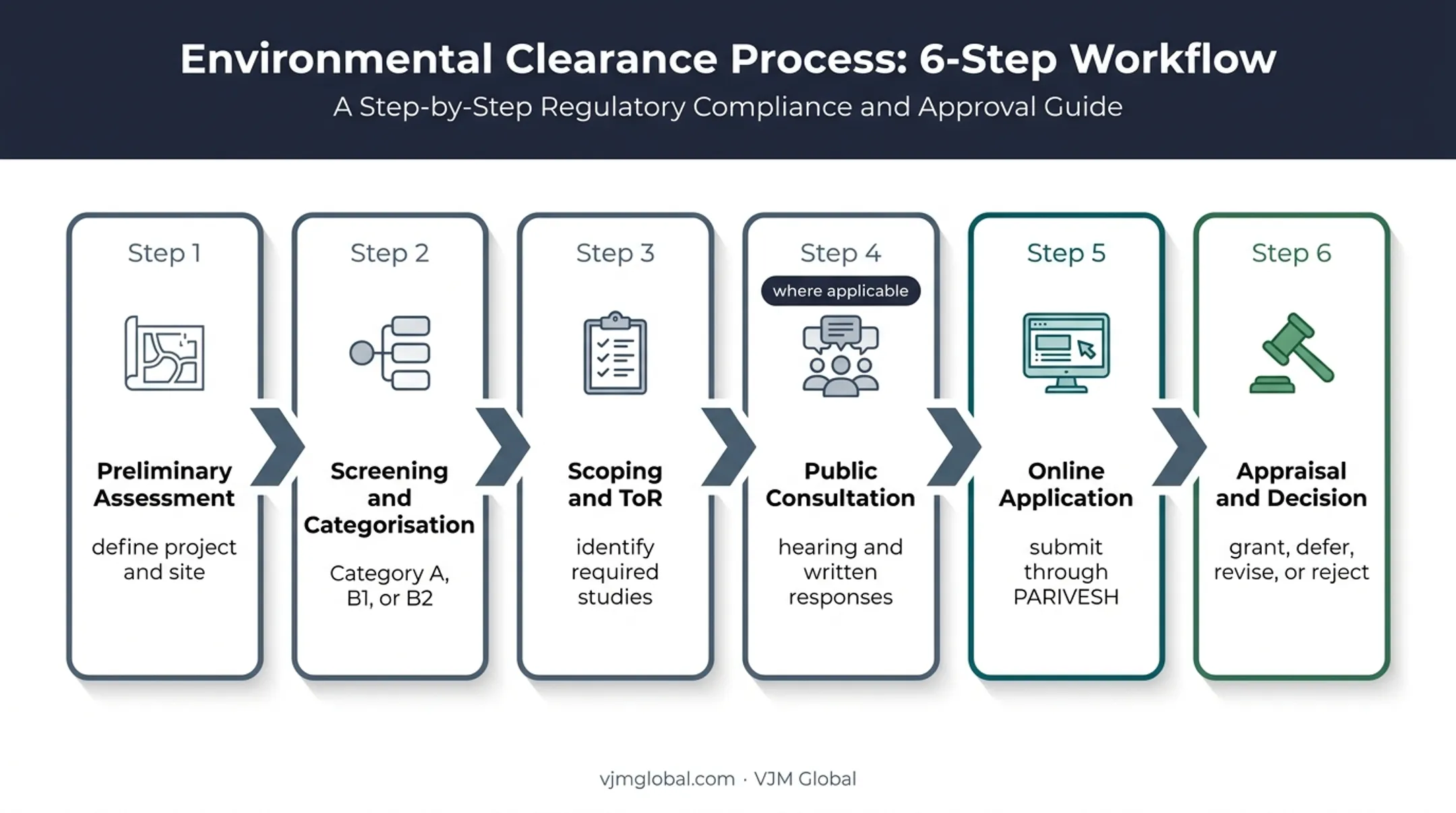

Six-step Environmental Clearance process from assessment to decision

Environmental Clearance Requirements and Applicability

Pre-Application Checklist

Before applying, gather documentation across five areas:

  • Project profile: ownership documents, land records, location and site plans, layout, and process description
  • Resource details: raw materials, water and energy consumption, capacity figures
  • Emissions and waste: effluent discharge, solid and hazardous waste streams, transportation plans
  • Pollution control: proposed control systems and technology
  • Technical studies: baseline monitoring data, impact predictions, alternatives analysis

Technical and Environmental Documentation

Beyond the checklist above, applications typically also need:

  • An environmental management plan
  • Risk and disaster management provisions
  • Occupational and community safeguards
  • Rehabilitation measures and a response plan for identified impacts, where applicable The statutory application is Form 1, with Form 1A required as a supplementary document for certain building and construction projects. Most applications also need a pre-feasibility project report, though item 8 construction-related projects submit a conceptual plan instead. Where an EIA is required, work with an accredited consultant organisation. NABET maintains the register of accredited EIA consultants and their approved sector scope.

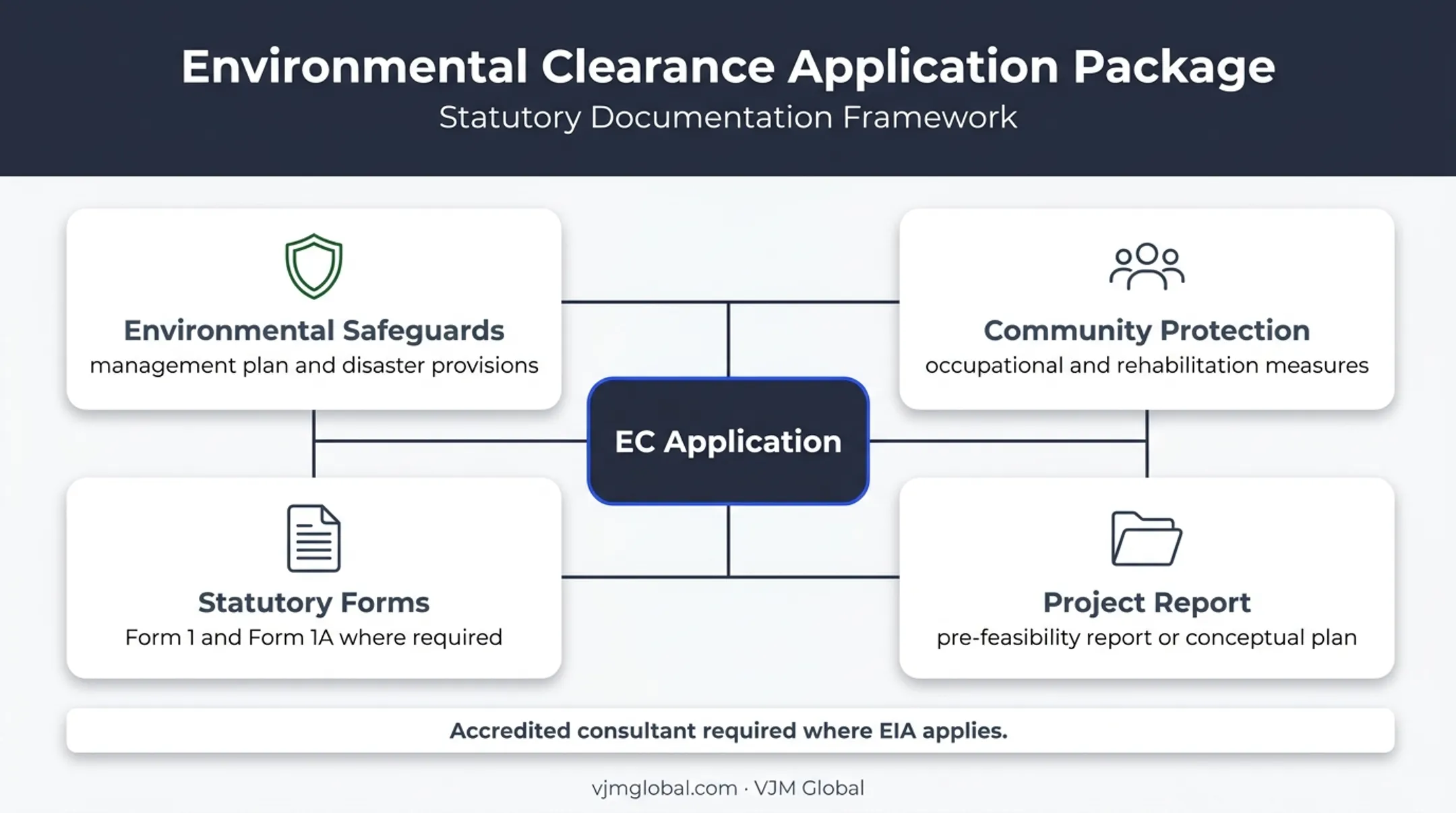

Environmental Clearance application documentation package and statutory forms

What Determines Your Pathway

Several factors decide whether you need a full assessment or a simplified route:

  • Project sector and production or built-up capacity
  • Whether it's a new project, expansion, or modernisation
  • Location and distance from ecologically sensitive features
  • Pollution potential and cumulative impacts with nearby projects
  • Whether separate environmental regulations (forest, wildlife, coastal) also apply Some projects qualify for exemption or simplified procedures. Don't assume your project is exempt without checking the latest notification, amendments, and any applicable conditions. Exemption lists get revised.

After You Get Clearance

EC isn't a one-time event. Ongoing obligations include:

  • Complying with every condition attached to the approval
  • Submitting periodic compliance reports, typically half-yearly
  • Renewing related consents as they expire
  • Filing environmental statements and other applicable returns
  • Keeping records and responding promptly to inspection notices For foreign companies and multinationals entering India, technical EC work (studies, Form 1 preparation, and consultant coordination) needs specialist environmental professionals. On the business side, VJM Global supports Indian entity setup, RBI and RoC registration for a project office, GST registration, FEMA/FDI compliance, and ongoing tax and accounting while environmental approvals move through the system in parallel.

Common Issues, Misconceptions, and Related Approvals

The "One Process Fits All" Myth

A common misconception: every project follows the same four-step or six-step EC journey. In reality, screening outcomes, consultation requirements, study scope, and even the deciding authority shift based on your project's specific facts and the current version of the law.

Don't Start Before You've Confirmed Clearance

Starting construction, land development, or production before confirming whether EC is required carries real risk. The Supreme Court's 2026 ruling in Vanashakti v. Union of India reaffirmed that prior clearance remains the governing rule, quashing routes that previously allowed ex post facto EC for projects that started without it.

CPCB Colour Categorisation Isn't EC Categorisation

CPCB's Red, Orange, Green, White, and Blue classification relates to pollution-control regulation, determining things like consent renewal frequency. It does not determine whether your project needs Environmental Clearance. Keep these two systems separate in your compliance planning.

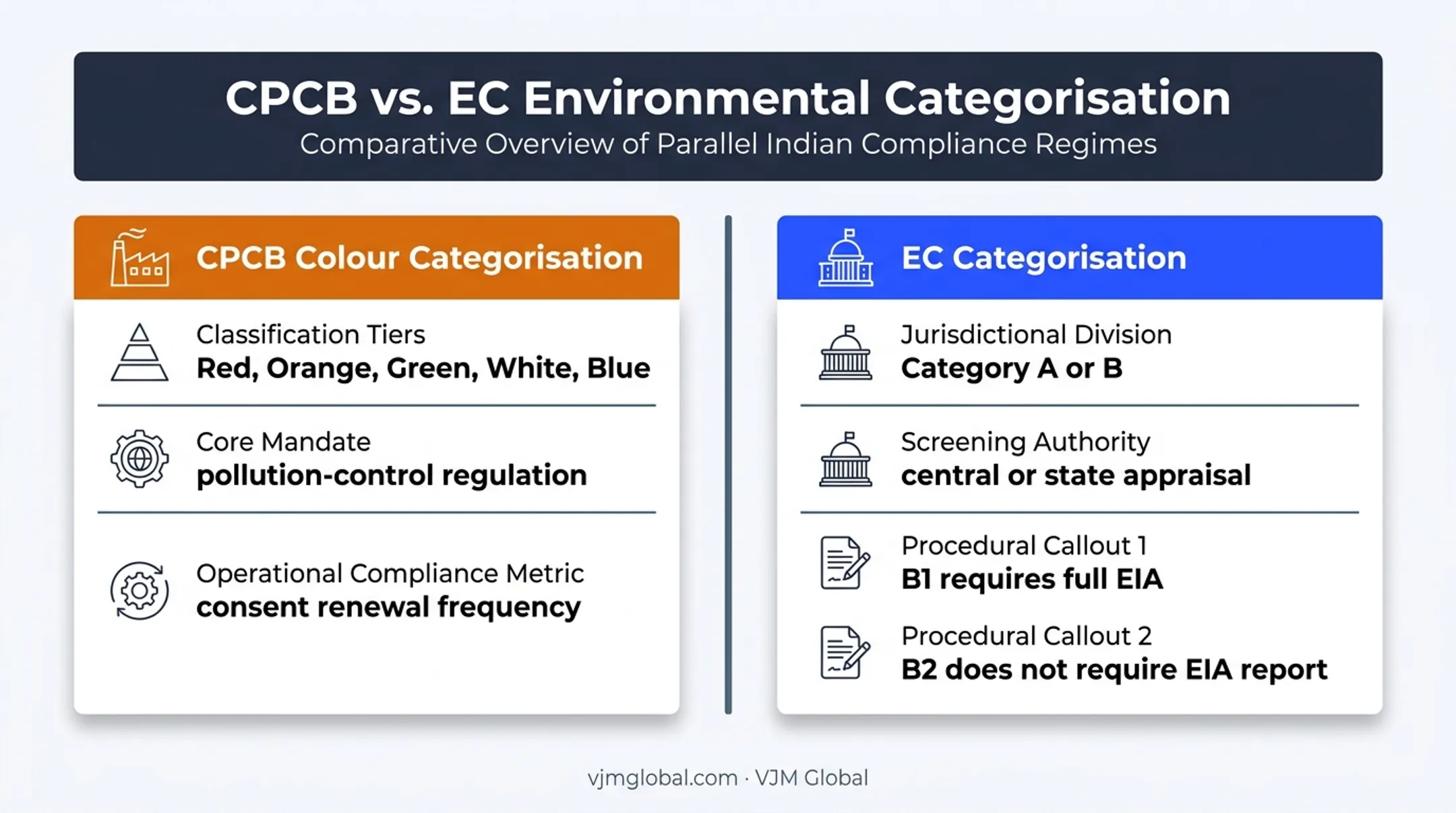

CPCB pollution categories versus Environmental Clearance categories comparison

EC vs Related Approvals

Approval What It Covers
Consent to Establish / Operate Pollution-control compliance (state board)
Forest Clearance Non-forest use of forest land
Wildlife Clearance Projects affecting protected areas
CRZ Clearance Coastal zone activities

Warning Signs of a Weak Application

Watch for these red flags before submission:

  • Inconsistent capacity figures across documents
  • Inadequate or outdated site maps
  • Missing land ownership or baseline data
  • Unsupported claims of "low impact"
  • Incomplete responses to public concerns or authority queries

Fees, timelines, validity periods, and exemption thresholds change regularly. Confirm all of these against current official sources, including PARIVESH, MoEFCC notifications, and your state authority, before submitting.

Conclusion

Environmental Clearance is a project-specific regulatory assessment designed to catch environmental and community impacts before development or operations begin.

Getting it right depends on a few disciplined steps:

  • Early applicability screening
  • Accurate technical studies
  • Complete documentation
  • The right level of public consultation
  • Timely responses when the appraisal committee raises questions

EC is also just one piece of the compliance puzzle. Pollution board consents, forest or wildlife approvals, CRZ clearance, and ongoing reporting obligations continue well after the EC certificate is issued. Treat the EC certificate as the start of your environmental compliance journey in India, and plan for the approvals and reporting that follow.

Frequently Asked Questions

Is environmental audit mandatory in India?

Environmental audit obligations depend on your project, industry, applicable rules, and consent conditions. It's distinct from Environmental Clearance itself, so check your pollution control board's current reporting requirements, including the annual environmental statement.

What are the fees for environmental clearance in India?

Fees vary by project category, deciding authority, and application type, and they're revised periodically. Verify the current fee schedule with MoEFCC or your State Environment Impact Assessment Authority before submitting.

Who needs Environmental Clearance in India?

New projects, expansions, and modernisation activities that meet the applicable Schedule entry's capacity, scale, or location criteria under the EIA Notification generally require EC. The exact trigger depends on your sector and project specifics.

What is the difference between Environmental Clearance and EIA?

An Environmental Impact Assessment is the technical study examining likely impacts. Environmental Clearance is the regulatory approval issued after the authority reviews that study and other submissions.

How long does it take to obtain Environmental Clearance in India?

Timelines depend on project category, study requirements, whether public consultation applies, document completeness, and how quickly you respond to authority queries. There's no guaranteed fixed period.

Is Environmental Clearance the same as Consent to Establish?

No. EC and Consent to Establish are separate approvals under different laws, usually issued by different authorities. Most projects need both, plus other sector-specific permissions depending on the activity.
