This guide is written for project proponents, developers, manufacturers, infrastructure companies, mining operators, foreign investors, and multinational businesses planning projects in India. Environmental approval decisions affect project design, financing timelines, construction schedules, and ongoing operations, often earlier in the planning cycle than proponents expect.
EC gets mentioned constantly alongside EIA, public hearings, SPCB consent, and forest approval. Yet many businesses entering India struggle to understand how these pieces actually connect at an operational level.
This guide covers eligibility, Category A/B classification, the authorities involved, application stages, timelines, documentation, compliance obligations, and common mistakes. Environmental rules and portal procedures change periodically, so confirm current requirements with a qualified advisor or the latest official notification before acting on anything specific here.
Key Takeaways
- EC applicability depends on project type, capacity, location, and site sensitivity under the EIA framework
- Category A goes to MoEFCC; Category B to state SEIAA/SEAC (B1 needs EIA; B2 usually exempt)
- The process covers screening, scoping, baseline studies, public consultation, appraisal, and a conditional decision
- EC is separate from Consent to Establish/Operate, forest clearance, and other sector approvals
- Never assume construction without prior EC can be regularised later; confirm the legal position first
What Is Environmental Clearance?
Environmental Clearance is the prior regulatory approval that specified projects need before proceeding, granted only after regulators assess the project's likely impact on air, water, land, ecology, and nearby communities.
The process exists to catch environmental risks before they become physical problems. It puts mitigation measures on the table early, gives regulators a documented basis for review, and attaches enforceable conditions to the project's design and operations. The proponent must meet those conditions for years afterward.
EC vs. EIA: Not the Same Thing
These terms get used interchangeably, but they aren't the same:
- EIA (Environmental Impact Assessment): the technical study, meaning the baseline data, modelling, and impact predictions compiled into a report
- EC (Environmental Clearance): the regulatory decision itself, built on the EIA, the application, consultation records where applicable, and expert appraisal
Think of the EIA as the evidence file and the EC as the verdict.
EC vs. SPCB Consent
Environmental Clearance is also separate from Consent to Establish (CTE) and Consent to Operate (CTO), which the State Pollution Control Board (SPCB) issues under the Water and Air Acts. One does not substitute for the other.
Most projects that need EC also need CTE and CTO. A new manufacturing plant or industrial facility in India, for example, may require EC plus state-level pollution consents, depending on the activity.
Why Environmental Clearance Is Required and Who Needs It
Environmental Clearance (EC) is required so projects with material environmental impact are assessed and approved before construction or operation starts.
Its legal foundation sits in Section 3 of the Environment (Protection) Act, 1986, operationalised through the EIA Notification, 2006, as amended. The notification lists scheduled activities (project types, capacities, and thresholds) that trigger prior EC, including covered expansions and modernisations.
Whether a project needs EC comes down to four screening questions:
- What sector does the project fall under (mining, manufacturing, infrastructure, or similar)?
- What's the proposed capacity or production level?
- Is this a new project, an expansion, or a modernisation crossing a threshold?
- Where is the site located, and is it near a sensitive zone?
Category A vs. Category B1 vs. Category B2
Category A projects are decided by the Ministry of Environment, Forest and Climate Change (MoEFCC), advised by an Expert Appraisal Committee (EAC). Category B projects go through the state-level State Environment Impact Assessment Authority (SEIAA), advised by a State Expert Appraisal Committee (SEAC).
| Category | Appraised By | EIA Report Required? | Public Consultation? |
|---|---|---|---|
| Category A | MoEFCC, on EAC recommendation | Yes | Generally yes |
| Category B1 | SEIAA, on SEAC recommendation | Yes | Generally yes |
| Category B2 | SEIAA, on SEAC recommendation | Ordinarily no | Exempt |
B2 status doesn't automatically mean no EC is needed. It just means a lighter documentation and appraisal path. Check the schedule entry for the specific activity rather than assuming based on project size alone.
Why Location Can Change Everything
A Category B project can get bumped to Category A treatment if it sits wholly or partly within a notified distance of a sensitive zone. That typically means 5 km of protected areas, critically polluted areas, eco-sensitive zones, or interstate/international boundaries (10 km for certain river-valley, thermal-power, and hazardous-waste entries).
Coastal sites follow a separate track: CRZ clearance under the 2019 CRZ Notification, independent of the EIA-based EC pathway.
Don't treat any location as automatically disqualifying without checking the applicable rule; trigger distances and exceptions vary by schedule entry.
Project types that commonly require scrutiny:
- Mining and mineral extraction
- Industrial manufacturing (chemicals, pharma, cement, metallurgy)
- Thermal power and infrastructure projects
- Construction and area-development or township projects
- River-valley and other scheduled activities
Beyond EC, most projects also need separate approvals:
- SPCB consent to establish and operate
- Forest or wildlife clearance where applicable
- Coastal permissions under the CRZ regime
- Groundwater NOC from the Central Ground Water Authority
- Hazardous-waste authorisation
- Local land-use or building permissions
How the Environmental Clearance Process Works

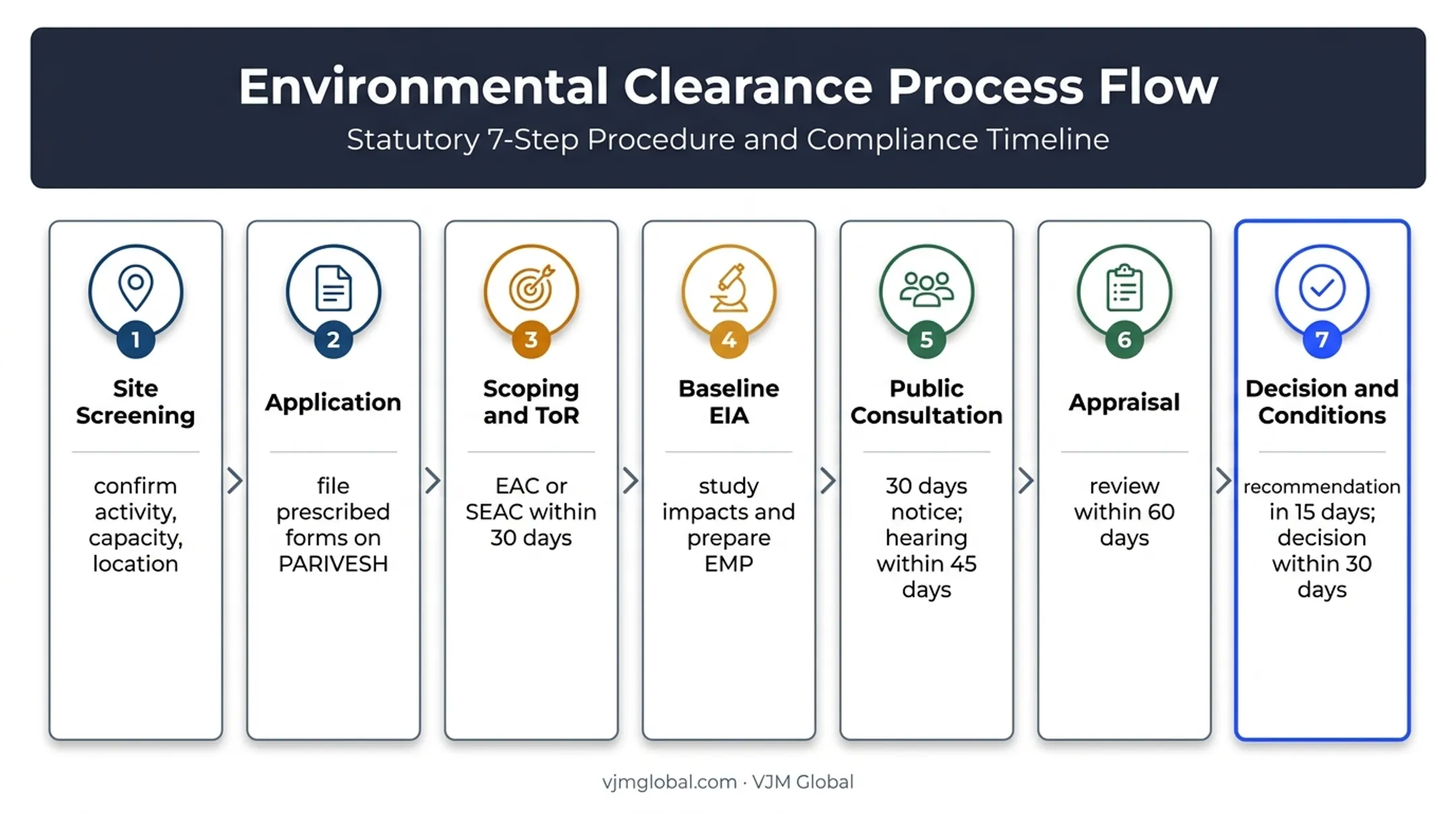

The EC process runs largely in sequence, though some technical studies and parallel approvals can proceed together where legally permitted.
Preliminary screening and site due diligence - Confirm the activity, capacity, location, land status, and any environmental sensitivities before filing. Check expansion history and map the likely approval route: Category A, B1, or B2.
Application and categorisation - File the prescribed Form 1 (plus Form 1A and a conceptual plan for certain projects) through the PARIVESH portal, which tracks proposals through each workflow stage. The regulator determines category treatment from here.
Scoping and Terms of Reference (ToR) - For applicable new applications, the regulator refers the matter to EAC or SEAC within 30 days for project-specific ToR. If none are issued, standard sector ToR apply automatically on day 30. ToR set the EIA scope, including modelling, alternatives, and risk assessment.
Baseline studies and EIA preparation - Monitor air, water, soil, noise, ecology, traffic, and socio-economic conditions at the site. Predict impacts, analyse alternatives, prepare disaster-management plans, and prepare the Environmental Management Plan (EMP), the document that turns findings into actual commitments.
Public consultation, where applicable - Category A and B1 projects ordinarily need a public hearing plus written responses. The SPCB gives at least 30 days' public notice, and the hearing must happen within 45 days of the applicant's request. Notified exemptions include B2 projects, certain irrigation modernisation, and projects in approved industrial estates.
Final submission, appraisal, and decision - The committee reviews the final EIA, EMP, consultation outcomes, and supporting documents. It may ask for clarifications, extra studies, or a site visit. Appraisal runs within 60 days of final documents; recommendations reach the regulator within 15 days, and the decision follows within another 30 days.
Grant or refusal, with conditions - Approval typically carries project-specific environmental conditions, monitoring requirements, reporting obligations, and implementation commitments, with compliance verification to follow through inspections.

On timelines: these stage clocks are real, but they aren't a guaranteed total elapsed time from first filing to final EC. Actual timelines still vary by:
- Category, state, and sector
- Document completeness and monitoring season
- Hearing schedules and clarification rounds
VJM Global helps project proponents coordinate screening, EIA studies, submission, and follow-up queries—especially foreign investors new to PARIVESH's workflow. That support reduces documentation errors that cause delays, though it doesn't guarantee approval or a fixed timeline.
Where Environmental Clearance Applies and What Affects the Outcome
EC isn't only a new-project requirement. It can also apply to:
- Expansions or capacity increases beyond a notified threshold
- Modernisation projects
- Changes in product or raw-material mix
- Any modification crossing an applicable schedule threshold
Not every change needs fresh clearance. Minor modifications within existing parameters typically don't, but "minor" is a legal question, not a business judgement call, so confirm it against the current schedule.
What Shapes Appraisal and Keeps Clearance Valid
Several inputs shape how smoothly an application moves through appraisal:
- Accurate project configuration, land records, and site information
- Capacity figures, raw material, fuel, and water requirements
- Emissions, effluent, and waste stream data
- Technology choices and alternatives considered
- Community and socio-economic impact data

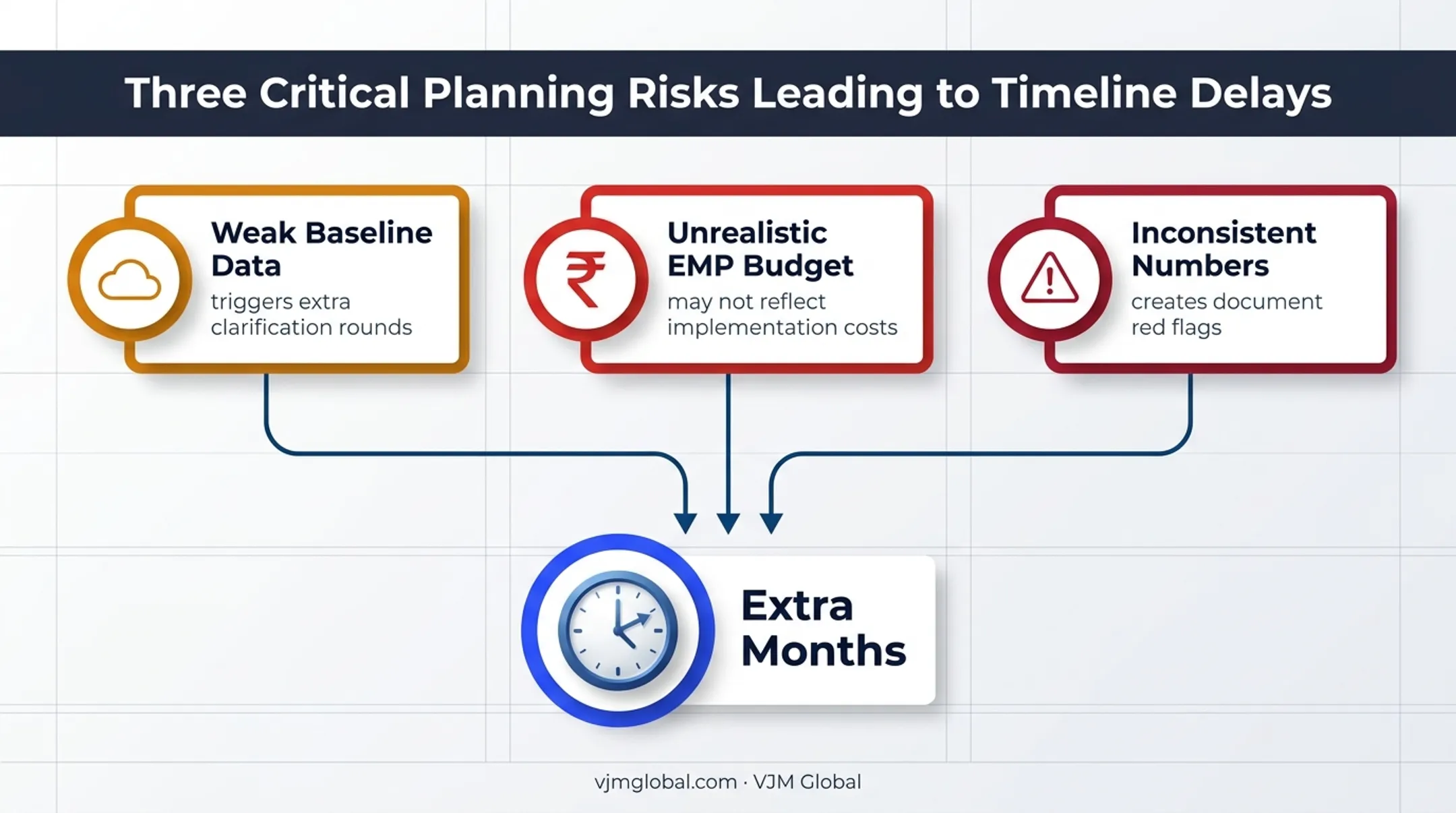

Weak baseline data, unrealistic Environmental Management Plan (EMP) budgets, or inconsistent numbers across documents are the fastest way to trigger extra clarification rounds, and extra rounds mean extra months.

Pre-application checklist:
- Land and site ownership records
- Layout, process flow, and production or occupancy figures
- Utility requirements (water, power, fuel)
- Pollution-control system specifications
- Baseline environmental data and risk studies
- Water and waste management plans
- Alternatives analysis and stakeholder information
One detail that trips up otherwise well-prepared applicants: numbers in the EC application, EIA report, State Pollution Control Board (SPCB) filings, land documents, and financial or technical plans all need to match. Regulators cross-check, and inconsistencies read as red flags even when they're clerical errors.
Clearance is not the finish line. Keeping the approval valid depends on what you do after the letter arrives.
Post-clearance obligations include:
- Complying with every condition attached to the approval
- Ongoing environmental monitoring
- Half-yearly compliance reports, due 1 June and 1 December under the current notification
- Implementing the EMP as designed, not as budgeted on paper
- Maintaining records for inspections and audits
Common Issues and When Environmental Clearance Is Not Enough
EC gets mistaken for a general "environment certificate," a one-time licence covering every environmental obligation a business will ever face. It isn't. EC is project-specific, and its conditions stay relevant for the entire project lifecycle.
Mistakes that show up repeatedly:
- Starting construction before securing prior EC
- Picking the wrong category (A vs. B1 vs. B2) without proper screening
- Incomplete site due diligence, missing sensitive-zone distances or land-status issues
- Inconsistent capacity figures across documents
- Weak baseline monitoring data and thin alternatives analysis
- EMP budgets that don't reflect real implementation costs
- Treating public consultation as a box-ticking exercise
Environmental due diligence at the site-selection stage, checking for past spill or fire incidents, adjacent-facility operations, and nearby resource availability, catches many of these issues before they become appraisal problems.
EC also doesn't replace other mandatory approvals. Each sits on its own legal footing:
- Consent to Establish and Consent to Operate
- Forest or wildlife clearances
- Building and land-use permissions
- Other sector-specific licences

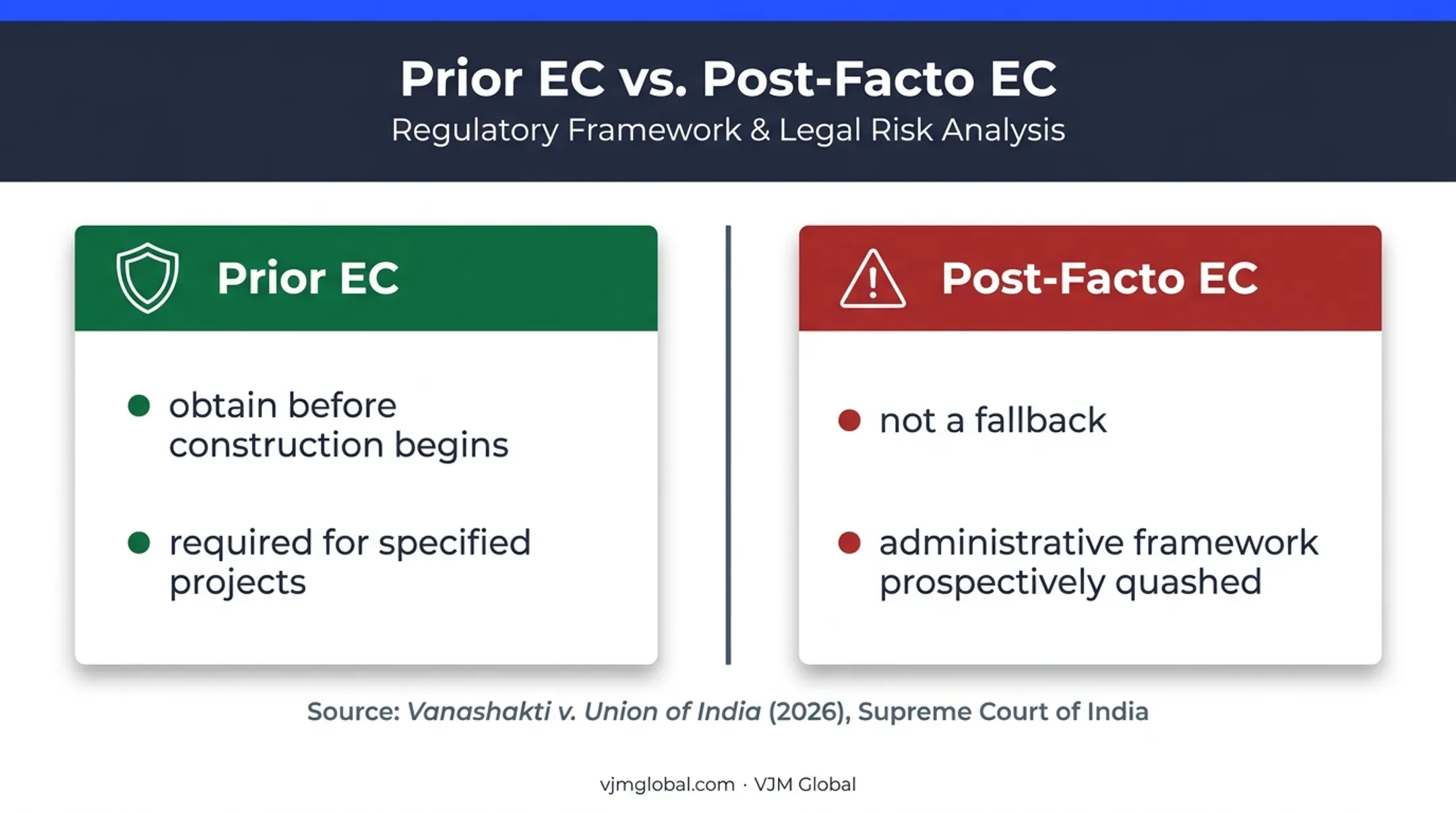

Post-Facto Clearance Is Not a Fallback
Don't assume construction can start now and get regularised later. The Indian judiciary has actively narrowed this route.
In Vanashakti v. Union of India (2026), the Supreme Court prospectively quashed the administrative framework governing ex-post-facto EC applications, ruling that any future framework needs a proper statutory notification rather than an office memorandum.

Obtain prior approvals before construction begins, and seek current professional and official guidance—court decisions and notifications on this point keep shifting.
Conclusion
The Environmental Clearance process in India is a project-specific pathway: eligibility screening, categorisation, technical studies, stakeholder consultation where applicable, expert appraisal, and a condition-based decision.
Early site due diligence, accurate project data, realistic environmental planning, and coordinated documentation save far more time than fixing approval problems after construction has already started.
VJM Global has spent decades helping foreign businesses navigate India's regulatory requirements, from entity formation through FEMA filings and ongoing compliance. Project work often runs in parallel with tracks such as EC and SPCB consent, where organised documentation and realistic timelines matter more than last-minute fixes.
If you're planning a project in India and want a second set of eyes on how environmental clearance sits within your broader India compliance pathway, sort that coordination early. No firm can guarantee an approval outcome.
Frequently Asked Questions
What is an environmental clearance?
Environmental Clearance is the prior regulatory approval required for specified projects in India, granted after environmental assessment and expert appraisal. It's distinct from the EIA (the underlying technical study) and from SPCB consent (a separate pollution-control approval).
How do I get an environmental clearance certificate?
The process covers eligibility screening, categorisation (A, B1, or B2), application filing, and Terms of Reference where applicable. It then moves through EIA studies, public consultation where required, expert appraisal, and compliance with the granted conditions.
Who is responsible for issuing an environmental clearance?
Category A projects are decided by MoEFCC on the Expert Appraisal Committee's recommendation. Category B projects go through the state-level SEIAA, advised by the SEAC.
How long is an environmental clearance valid in India?
Validity depends on project type under the current notification, with different periods applying to mining, river-valley, and nuclear projects versus other categories. Verify the applicable period rather than assuming a single universal duration.
Is EIA mandatory in India?
Not for every EC application. Category A and B1 projects generally require a detailed EIA report, while Category B2 projects ordinarily don't need one, though they may still require EC.
What is category A and B in EIA?
Category A projects are appraised centrally by MoEFCC; Category B projects are appraised at the state level by SEIAA/SEAC. Category B splits further into B1 (EIA required) and B2 (usually exempt from EIA and public consultation).
