Kerala's coastline, wetlands, forests, and hill tracts invite stricter environmental scrutiny than many other states. A project that clears appraisal quickly elsewhere can face months of additional study here.
Environmental clearance (EC) often gets confused with Kerala State Pollution Control Board (KSPCB) consent, Coastal Regulation Zone (CRZ) clearance, and other approvals. These are separate legal requirements, and mixing them up causes real delays. This guide covers Kerala's EC authorities, the application process, documents, fees, timelines, and what happens after approval.
Key Takeaways
- Project type, scale, location, and expansion status under the EIA Schedule set EC needs—not fixed thresholds.
- File through MoEFCC or SEIAA-Kerala and SEAC on the PARIVESH portal.
- Treat KSPCB consent, CRZ, forest, and wildlife clearances as separate from EC.
- Confirm fees, timelines, and validity against current notifications and rulings before filing.
What Is Environmental Clearance?
Environmental clearance is formal, written government approval granted before specified projects begin, expand, or change in ways covered under India's Environmental Impact Assessment Notification. It gets issued after the appraising authority reviews documented environmental and social impacts, not before.
The clearance process exists to:
- Identify likely impacts on air, water, soil, biodiversity, and nearby communities
- Evaluate whether proposed mitigation measures hold up
- Attach enforceable conditions the project must follow
- Create a documented basis for development decisions
EC is often confused with other approvals it does not replace. Here's how they differ:
| Approval | What it decides |
|---|---|
| Environmental Clearance (EC) | Whether a scheduled project may proceed, subject to assessed conditions |
| EIA report | The technical study used during appraisal, not an approval in itself |
| KSPCB Consent to Establish / Operate | Whether the installation meets pollution-control requirements under the Water Act and Air Act |
| CRZ clearance | Whether the activity is permissible under Kerala's Coastal Zone Management Plan |
| Forest / wildlife clearance | Whether forest-land diversion or protected-area activity is permitted |
Under the EIA Notification, 2006, as consolidated through July 2026, prior clearance is required before construction or land preparation begins on any scheduled project. A coastal manufacturing unit, for instance, may need EC, KSPCB consent, and CRZ clearance running as three separate approvals in parallel.
Getting an EC does not exempt a project from other laws. Every condition attached to the clearance is enforceable, and proponents still need KSPCB consent, water permissions, local-body approvals, and any applicable CRZ, forest, or wildlife clearance. Treating EC as a one-stop approval is one of the costliest misunderstandings among first-time project proponents in Kerala.
Environmental Clearance Applicability and Authorities in Kerala
Whether your project needs EC, and who decides it, depends on five factors:
- Sector
- Capacity or built-up area
- Mining lease area
- Pollution potential
- Proximity to protected, coastal, forest, or wetland areas
There's no shortcut around checking the current EIA Schedule and its amendments. Generic thresholds circulating online are frequently outdated.

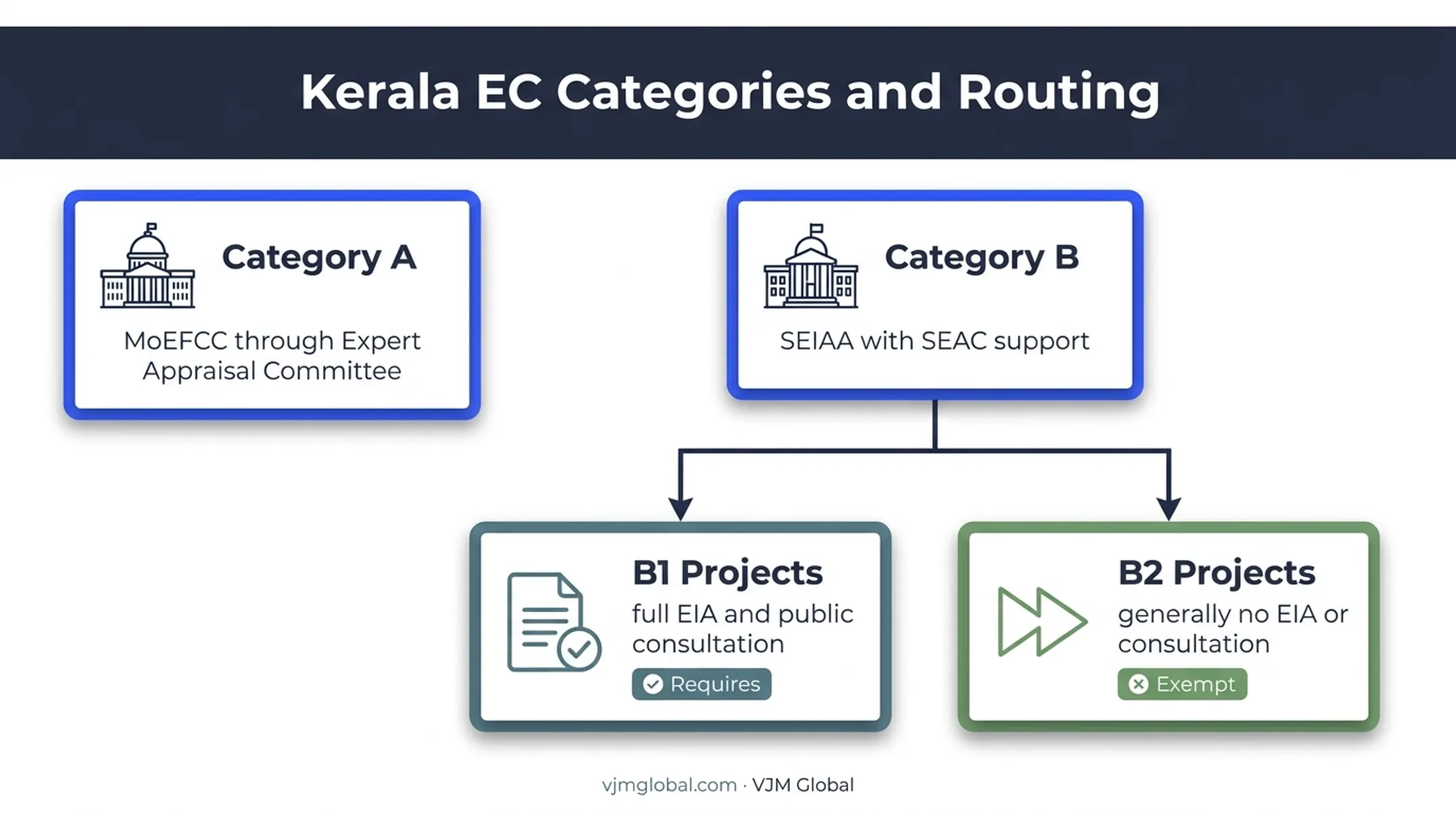

Category A vs Category B Projects
Category A projects are generally appraised centrally by the Ministry of Environment, Forest and Climate Change (MoEFCC) through its Expert Appraisal Committee. Category B projects typically go to Kerala's State Environment Impact Assessment Authority (SEIAA), supported by the State Expert Appraisal Committee (SEAC).
Category B splits further:
- B1 projects require a full EIA report and public consultation
- B2 projects generally skip the EIA report and consultation requirement

Scale drives the classification more than labels do.
Building and construction examples:
- Item 8a (building/construction): 20,000 m² to under 150,000 m² built-up area sits in Category B
- Item 8b (township/area development): at least 50 hectares and/or 150,000 m² needs a full EIA report
Mining follows a similar graduation:
- Minor-mineral lease up to 5 hectares: may qualify for district-level appraisal
- Leases between 5 and 25 hectares: typically stay with SEAC/SEIAA
- Above 100 hectares: moves to the central EAC
KSPCB's role gets misunderstood often. The board administers pollution-control consents under the Water Act and Air Act, and it facilitates public hearings during EC appraisal, but it does not grant environmental clearance. Treating KSPCB as the EC-granting authority delays filings unnecessarily.
Where to Apply
PARIVESH is the online portal for EC applications, tracking, and committee correspondence. Select the correct project type and Kerala routing before uploading documents; the workflow differs depending on whether MoEFCC, SEIAA-Kerala, or a district authority handles your case.
Depending on your site, you may also need:
- CRZ clearance, if the project falls within Kerala's Coastal Zone Management Plan area
- Forest or wildlife clearance, for land diversion or protected-area proximity
- Water-related permissions and local-body approvals
- Mining lease and quarry-specific permits
Map every applicable approval before mobilising site work. Missing one doesn't just risk a fine; it can halt an otherwise cleared project entirely.
How the Environmental Clearance Process Works in Kerala

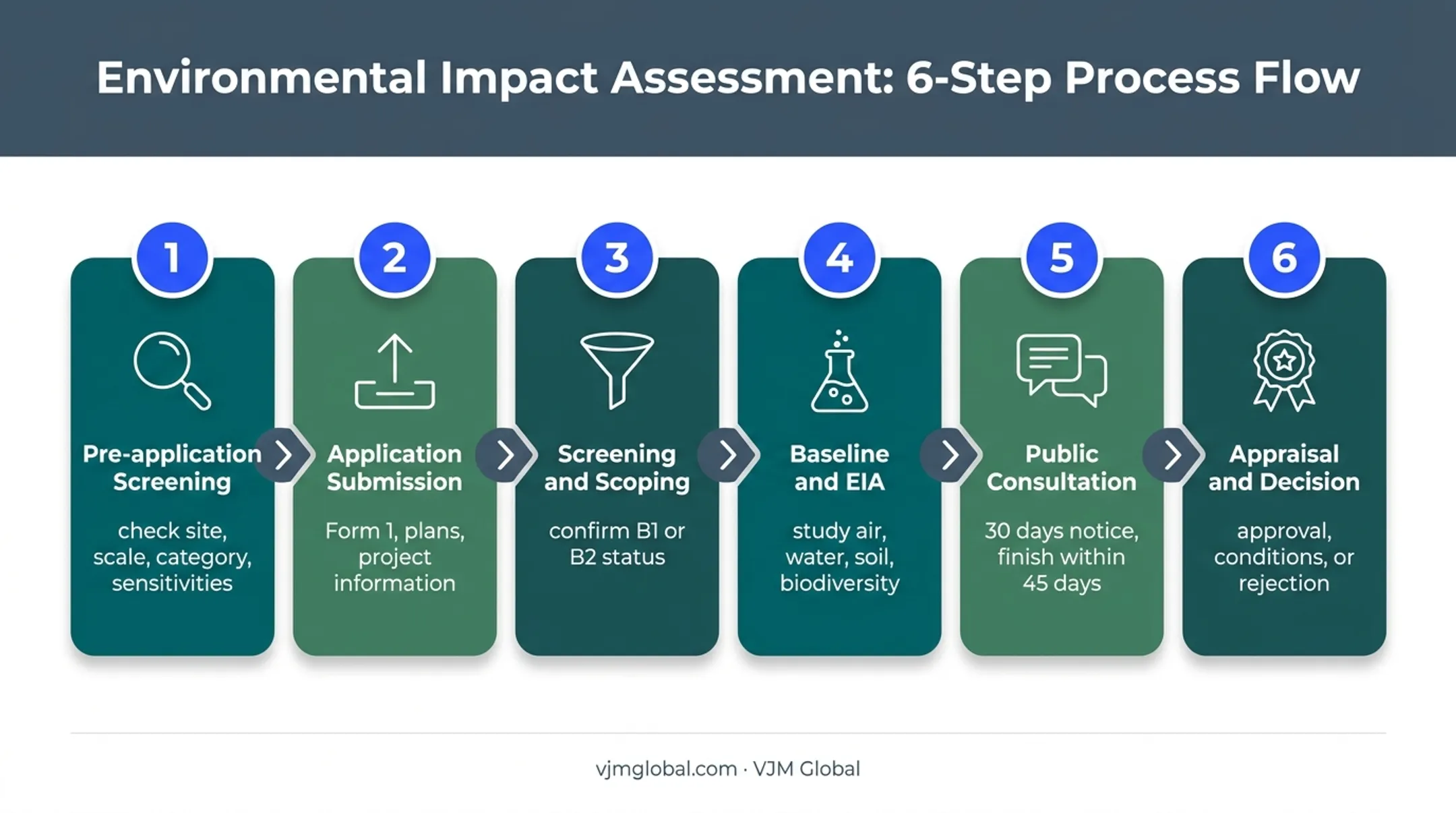

The EC process follows a fixed sequence, though the depth of work at each stage depends on your project's category.
Pre-application screening. Assess land status, environmental sensitivities, project scale, sector classification, expansion history, and any other site-triggered permissions before filing.
Application submission. Submit Form 1 (and Form 1A where applicable) through PARIVESH, along with a pre-feasibility report, site plans, capacity details, and preliminary environmental information. Construction projects under item 8 typically submit a conceptual plan instead.
Screening and scoping. SEAC reviews Category B applications to confirm B1 or B2 status. B1 projects receive Terms of Reference for their EIA study; B2 projects generally proceed without a full EIA report.
Baseline studies and EIA/EMP preparation. For B1 and Category A projects, qualified experts run baseline studies on air, water, soil, noise, biodiversity, waste, traffic, resource use, and disaster risk, then prepare the EIA and EMP. On sensitive cases such as quarry clusters, Kerala's SEAC has required NABET-accredited consultants.
Public consultation. Where required, KSPCB arranges a hearing near the project site, chaired by the District Collector or an officer of equivalent rank. The public gets at least 30 days' notice, and the hearing must finish within 45 days of the proponent's request. Recorded objections and local concerns must be addressed in the final EIA.
Appraisal and decision. SEAC or EAC reviews the file, requests clarifications or revisions where needed, then recommends approval, conditions, or rejection. SEIAA-Kerala or MoEFCC issues the final decision, typically within 45 days of that recommendation. Regulated construction or operations cannot start before clearance is granted.

Coordinating document preparation, portal submissions, and committee queries takes real bandwidth, especially for a foreign investor or NRI managing a Kerala project from overseas.
VJM Global's compliance support team helps clients organise project information, prepare submission packages, and track authority correspondence through to approval. This is advisory support only; it carries no government affiliation and cannot guarantee a clearance outcome.
Documents, Fees, Timelines and Post-Clearance Compliance
Documents You'll Need
Most EC applications require:
- Application form (Form 1, 1A, or 1M depending on project type)
- Project report or pre-feasibility report
- Land ownership or lease documents
- Site and layout plans, capacity, and process details
- Water and energy requirement estimates
- Pollution and waste generation estimates
- Risk assessment and disaster-management plan
- EIA/EMP documents, where applicable
- Proof of other relevant approvals already obtained
Kerala's appraising authorities often expect location-specific detail too:
- Nearby habitations, water bodies, wetlands, forests, or protected areas
- Coastal-zone status and traffic impact
- Rehabilitation or livelihood concerns
- Public-hearing records where consultation was held
Confirm exact requirements against the current authority checklist rather than a generic list.
Fees and Costs
Government processing fees follow the official schedule in force at the time of filing. SEIAA-Kerala has previously confirmed that fees paid at the district level should not be paid again at the state level for the same application. Beyond the government fee, budget separately for:
- Consultant and EIA-preparation charges
- Baseline-study and laboratory testing costs
- Public-consultation logistics
- Document preparation and portal-filing support
Verify the current fee schedule directly with SEIAA-Kerala or PARIVESH before filing. Published figures change, and quoting an outdated number is a common planning mistake.
Timelines and Validity
Processing time depends on project category, document completeness, the season for baseline studies, consultation scheduling, and committee meeting calendars. Treat any quoted timeline as indicative, not guaranteed.

Validity periods vary by project type, under the amended EIA Notification:
| Project type | Validity period |
|---|---|
| Most non-mining projects | 10 years |
| River-valley projects | 13 years |
| Nuclear projects | 15 years |
| Mining projects | Up to 30 years, with a possible 20-year extension subject to five-yearly review |

After the Clearance
Approval isn't the finish line. You still need to:
- Implement every condition attached to the EC
- Run ongoing environmental monitoring per the EMP
- Submit half-yearly compliance reports by 1 June and 1 December
- Maintain pollution-control systems and KSPCB consents
- Track renewal, amendment, or extension deadlines before validity lapses
Validity and extension rules have shifted through notifications and court decisions in recent years. Check the current rule applicable to your project category rather than relying on older commentary, especially for mining and large construction projects.
Common Issues and When Environmental Clearance May Not Be Appropriate
Mistakes That Cause Delays
The same errors show up repeatedly in Kerala EC filings:
- Starting construction or land preparation before EC is granted
- Misclassifying the project under the wrong Schedule item, or treating a genuine expansion as a brand-new one
- Submitting inconsistent site, capacity, or lease-area figures across documents
- Omitting sensitive-area information such as wetlands, forest proximity, or coastal zones
- Relying on incomplete or outdated baseline data
- Failing to respond to public-hearing objections or committee queries
Consequences of Non-Compliance
Kerala's SEAC minutes show enforcement playing out in practice: cases involving excess mineral extraction have triggered demands for independent environmental-damage assessments before any further appraisal proceeds. More broadly, non-compliance can lead to:
- Stop-work directions
- Refusal or cancellation of clearance
- Environmental compensation demands
- Additional regulatory scrutiny or show-cause proceedings
- Difficulty securing KSPCB consent or project financing
The Supreme Court's 2026 Vanashakti ruling, reported by LiveLaw, reinforced that prior clearance remains the rule. The Court prospectively struck down the administrative route that had allowed routine after-the-fact clearance. Starting work before approval, on the assumption it can be regularised later, is no longer a safe bet.
When EC May Not Apply
Some activities fall outside the EIA Schedule or qualify for a specific exemption. Skipping EC, though, doesn't remove other statutory duties. Pollution-control consent, waste management, coastal, forest, wildlife, local-body, and mining obligations still apply independently.
Quick checklist before you proceed:
- Confirm whether your activity is listed in the current Schedule
- Verify capacity, area, and location thresholds against the latest amendment
- Review prior approvals and expansion history for the site
- Get written professional or authority guidance if classification stays unclear
Conclusion
Environmental clearance in Kerala is a project-specific process: classification, environmental studies where required, public consultation, technical appraisal, and conditions that continue well past the approval date. None of it works as a one-time checkbox.
The safest approach is to act early and keep every approval in sequence:
- Screen your project and site before you lock design or land deals
- Confirm applicable rules directly through PARIVESH and SEIAA-Kerala
- Coordinate EC with KSPCB consent and any CRZ, forest, or mining permissions
- Do not start regulated construction until the clearance is in hand
For investors and businesses managing this from outside Kerala, or outside India altogether, VJM Global's compliance team can help map which approvals a project needs and keep the paperwork moving while you focus on the project itself.
Frequently Asked Questions
What are the fees for environmental clearance in Kerala?
Fees follow the government schedule for your project category—confirm current rates on SEIAA-Kerala or PARIVESH before filing. Budget separately for baseline studies, lab testing, EIA/EMP preparation, and consultants.
How do you get an environmental clearance certificate in Kerala?
Confirm your project category, then apply on PARIVESH with the prescribed forms and documents. After any required studies and public consultation, SEAC or EAC appraises the file and SEIAA-Kerala or MoEFCC issues conditional approval.
Is environmental clearance mandatory in Kerala?
Yes, for any project or activity covered under the EIA Notification's Schedule, it's required before the activity begins, expands, or changes in a regulated way. Applicability still depends on project type, scale, location, and specific exemptions.
What is an environmental clearance certificate?
It's the written, conditional approval issued by the competent authority after environmental appraisal of a scheduled project. It doesn't replace KSPCB pollution-control consent, CRZ clearance, or any other project-specific permission you need.
