Treating these as interchangeable is a common and costly mistake. Teams duplicate technical work, submit inconsistent applications, or discover mid-construction that they still can't legally operate. The result: programme delays, abortive costs, and sometimes a complete redesign.
This guide walks through how to identify the correct approvals, coordinate applications across regulators, prepare consistent evidence, and stay compliant once you're operational—across England, Wales, Scotland, and Northern Ireland.
Key Takeaways
- Planning permission governs land use and development; environmental permits control pollution risk—and neither replaces the other.
- Screen early, confirm the correct UK nation and regulator, then use pre-application advice before locking the design.
- Coordinate planning, EIA, and permitting evidence to avoid duplicated surveys and conflicting assumptions.
- Approval is not the end: monitoring, record-keeping, and permit variations continue afterward.
UK Environmental Planning and Permitting Framework
Three distinct decisions sit at the heart of most UK development projects, and conflating them is where problems start.
| Instrument | What it decides |
|---|---|
| Planning permission | Whether the proposed development and land use is acceptable, including design, transport, amenity, and heritage impacts |
| Environmental impact assessment | What significant environmental effects the planning decision-maker must consider—it informs the decision but doesn't grant it |
| Environmental permit | Whether a specified activity can operate, and under what pollution controls |
Planning authorities weigh up land use, design, ecology, heritage, and wider amenity. Environmental regulators, by contrast, focus narrowly on regulated activities: emissions, waste handling, resource use, and pollution prevention. The two systems run on separate legal tests, and one approval doesn't automatically unlock the other.
Which Regulator Applies
The regulator depends on where your project sits:
- England: Environment Agency (with local authorities handling some Part A(2) and Part B industrial activities)
- Wales: Natural Resources Wales
- Scotland: Scottish Environment Protection Agency (SEPA), under its Environmental Authorisations (Scotland) Regulations framework
- Northern Ireland: Northern Ireland Environment Agency, with district councils covering Part C installations
Always verify the current regulator and application route for your specific location and activity—these responsibilities shift between agencies and local authorities depending on the sector.
What Triggers Additional Consent
Certain project characteristics almost always pull in extra assessment or permitting requirements:
- Waste treatment, storage, or disposal activities
- Combustion plant or generators above specified thresholds
- Intensive poultry or pig farming
- Wastewater discharges or water abstraction
- Industrial processes (food production, furniture manufacturing, and similar)
- Protected habitats, contaminated land, or major infrastructure
Screen your project against current legislation, local planning policy, permit regimes, and protected-site requirements before finalising your design. Retrofitting pollution controls into an approved design is far costlier than building them in from the start.
Step-by-Step Application Process
A structured sequence keeps planning and permitting applications aligned instead of working against each other.

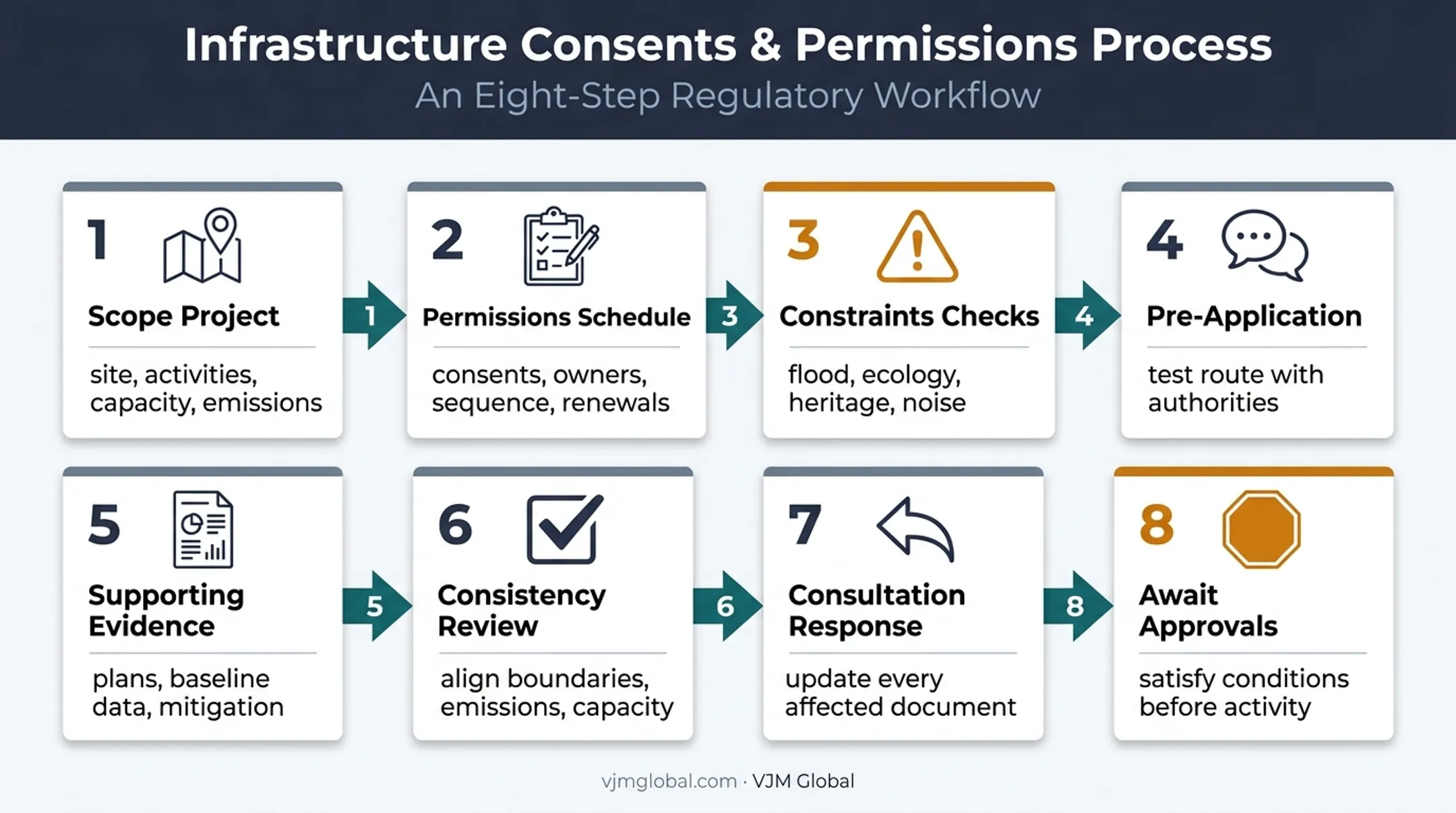

Scope the project. Define the site, proposed development, operational activities, capacity, materials, emissions, waste streams, construction methods, and nearby environmental receptors.
Build a permissions schedule. List every consent needed, who decides it, who owns the application, what technical input it requires, and the expected sequence and renewal obligations.
Run constraints checks early. Cover planning designations, flood risk, watercourses, groundwater, protected species, heritage assets, air quality, noise, traffic, and contaminated land.
Use pre-application engagement. Test your proposed route with the planning authority, environmental regulator, and technical advisers. This reveals whether a standard-rules or bespoke permit applies before you've drafted final documents.
Prepare proportionate supporting evidence. This includes site plans, process descriptions, baseline environmental data, alternatives considered, mitigation measures, monitoring proposals, and a draft environmental management system where required.
Run a consistency review before submission. Check for common inconsistencies that trigger validation queries:
- Mismatched site boundaries between planning and permit drawings
- Different emissions figures in the EIA versus the permit application
- Operating hours or capacity quoted differently across documents
- Mitigation measures described in one document but missing from another
Respond to consultation carefully. When objections or further-information requests arrive, update every affected document, not just the one the query targeted.
Wait for all approvals before acting. Construction, commissioning, fuel use, waste acceptance, or discharges shouldn't begin until every applicable permission and pre-operational condition is satisfied.

Coordinating Planning Permission, EIA, and Environmental Permits
When EIA Applies
Schedule 1 projects require an EIA automatically. Schedule 2 projects require screening to determine whether significant environmental effects are likely, based on nature, size, and location.
According to UK government EIA guidance, Schedule 2 development in a sensitive area may need screening even below the usual thresholds. Don't assume one nation's criteria apply elsewhere: Scotland, Wales, and Northern Ireland each run their own regulations with broadly similar but not identical tests.
Reusing Evidence Without Cutting Corners
EIA and permitting assessments often draw on the same underlying data:
- Baseline surveys and air-quality modelling
- Water and noise assessments
- Biodiversity and traffic data
- Emergency planning information
This evidence can be responsibly reused, but it must be adapted to each authority's legal test and format. Copying an EIA chapter directly into a permit application often leaves critical operational controls—like stack height or abatement equipment specifications—unanswered.

Running Applications in Parallel
According to Environment Agency guidance for developments requiring both consents, developers can generally choose the order of planning and permit applications. Certain waste-operation permits, however, cannot be issued before planning permission is granted.
Parallel preparation, and sometimes parallel submission, reduces duplication. Each application remains a separate legal decision.

A practical coordination sequence looks like this:
- Confirm the development concept
- Complete screening and scoping
- Agree technical methodologies across teams
- Prepare coordinated documents
- Submit linked applications
- Track consultations on both fronts
- Discharge conditions as they're satisfied
- Update the permissions schedule throughout
A UK Example of Coordination
At the Low Level Waste Repository in Holmrook, Cumbria, the Environment Agency granted a revised environmental permit in 2015, drawing on an Environmental Safety Case developed with the regulator. The subsequent planning application, submitted in October 2015 after extensive engagement with Cumbria County Council, secured planning consent in July 2016.
According to the official project case study, that consent secured the site's operational future to around 2050. Shared technical evidence supported two separate but connected decisions, though the published record does not quantify any specific delay avoided.
Compliance After Approval
Getting approval starts an ongoing management obligation. Your permit conditions continue to bind how the site is run day to day.
Building an Operational Management System
A permitted activity typically needs:
- Named responsibilities and a legal/permit register
- Documented operating procedures
- Staff competence and contractor controls
- Monitoring and maintenance schedules
- Document control and incident-response arrangements
Records Worth Organising
Keep structured records so you can evidence compliance when the regulator asks. Core files usually include:
- Monitoring results and inspection notes
- Waste acceptance checks and maintenance logs
- Training records, complaints, and incidents
- Regulator correspondence
Exact retention periods vary by regime, so follow your permit conditions rather than assuming a standard timeframe.
Managing Changes
Before altering capacity, equipment, fuels, waste types, drainage, emissions, operating hours, site layout, or ownership, check whether you need:
- A planning amendment
- A permit variation
- A simple notification
- A fresh environmental assessment
Handling Incidents

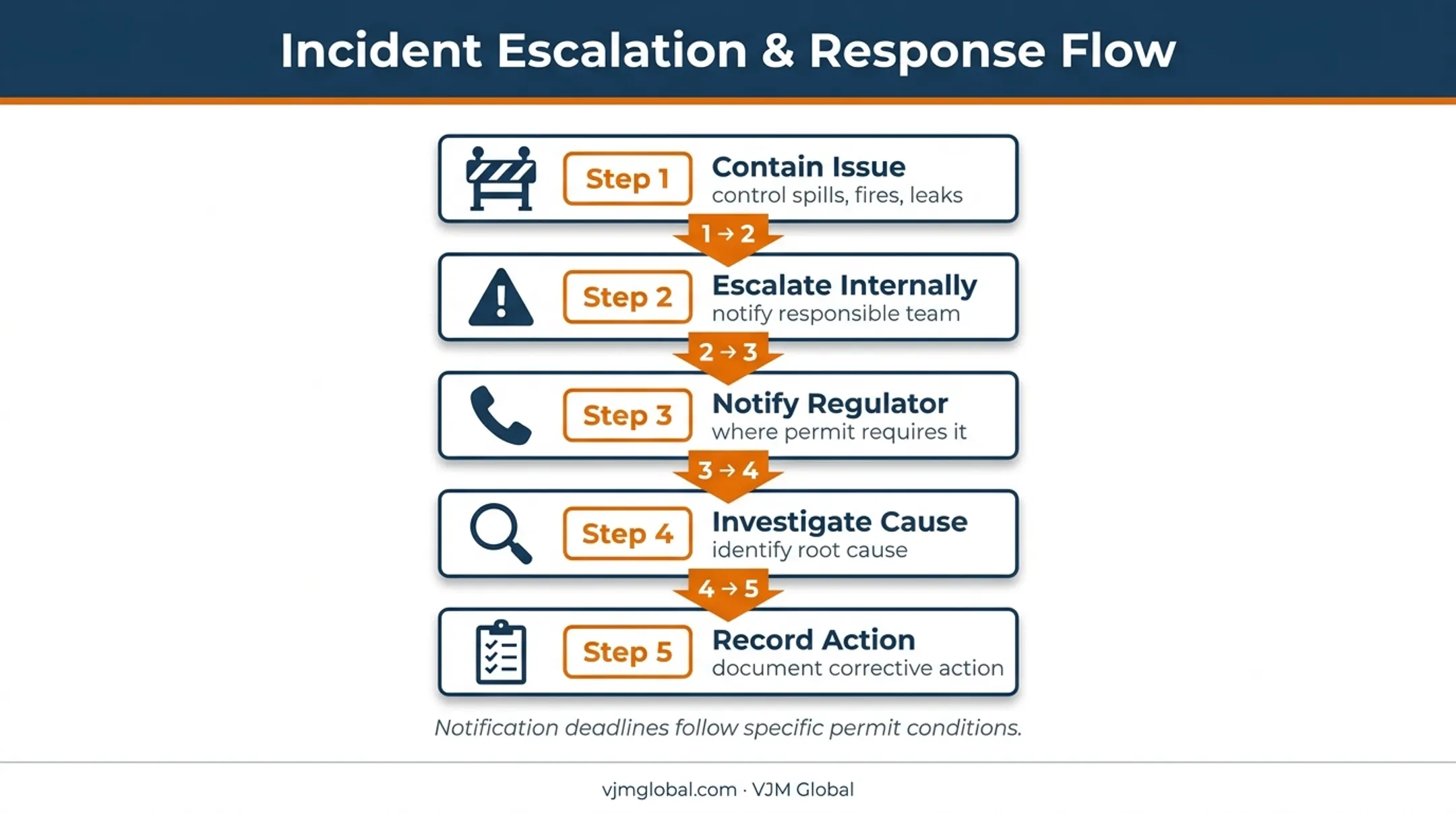

Spills, fires, leaks, equipment failures, flooding, or monitoring exceedances all need a structured response:
- Contain the issue
- Escalate internally
- Notify the regulator where your permit requires it
- Investigate the root cause
- Record corrective action

Do not assume notification deadlines. They are set out in your specific permit conditions.
Avoiding Common Pitfalls
Projects commonly stumble by:
- Applying to the wrong regulator
- Relying on outdated guidance
- Underestimating baseline survey requirements
- Leaving permitting until construction is already advanced
- Failing to budget time for pre-operational conditions
A proportionate review process helps catch these early. Internal checks against your own procedures, specialist input where risk warrants it, and regular regulator engagement all reduce the chance of a conditions breach going unnoticed.
For overseas businesses setting up and operating in the UK, VJM Global can support company formation, accounting, tax, and corporate compliance. Technical planning, EIA, and environmental-permitting decisions should sit with qualified environmental specialists and the relevant UK authorities.
Conclusion
Successful environmental planning and permitting in the UK starts well before the first application form is filled in. It begins at scoping and continues through design, submission, construction, commissioning, and operation.
Practical priorities stay the same:
- Identify every approval your project needs
- Confirm the correct regulator for your nation and activity
- Coordinate your evidence base
- Allow realistic time for consultation and discharge of conditions
- Build a controlled compliance system that outlasts the approval itself
Legislation and regulator guidance shift. Always check current requirements for your project's specific location, sector, scale, and environmental risk before relying on general guidance—including this one.
Frequently Asked Questions
What are the guidelines for obtaining planning permission in the UK?
Start with site and policy checks, then use pre-application discussions before submitting forms, plans, and supporting assessments. Expect public consultation before the local planning authority decides. Always verify current requirements for your specific UK nation.
What is the difference between planning permission and an environmental permit?
Planning permission concerns development and land use acceptability. An environmental permit regulates specified activities, emissions, waste, or pollution risks. Neither automatically replaces the other.
When is an environmental impact assessment required in the UK?
EIA requirements depend on project type, scale, location, and the likelihood of significant environmental effects. Get screening or scoping advice under the rules applicable to your specific UK nation.
Which regulator issues environmental permits in the UK?
The Environment Agency covers England, Natural Resources Wales covers Wales, SEPA covers Scotland, and the Northern Ireland Environment Agency covers Northern Ireland. Confirm the current regulator and activity-specific route before applying.
Can planning permission and an environmental permit be applied for at the same time?
Yes, parallel preparation or submission can work well. Each application remains legally separate and must contain information relevant to its own technical requirements.
What happens after an environmental permit is granted?
You'll need operational controls, monitoring, record-keeping, and readiness for inspections and incident reporting. Seek approval before making any change that could affect your permit conditions.
