NEPA is a procedural law. It forces federal agencies to study environmental consequences, weigh alternatives, and invite public comment before making certain decisions. It rarely approves or blocks a project on its own.
This distinction matters because misunderstanding it costs time and money. A project can clear NEPA review and still need a Clean Water Act permit, an Endangered Species Act consultation, or a state air quality approval.
This article covers what triggers NEPA, the three levels of review, how NEPA interacts with other permitting laws, what drives timelines and litigation risk, recent changes worth verifying, and how NEPA differs from the EPA as an agency.
Key Takeaways
- Federal agencies trigger NEPA when they propose, fund, approve, or take an action with potentially significant environmental effects.
- Review falls into three tiers: categorical exclusion, Environmental Assessment, or Environmental Impact Statement.
- Other approvals still stand alone — Clean Water Act and Endangered Species Act duties are coordinated under NEPA, not replaced.
- Stable project design, early baseline data, and disciplined agency coordination reduce permitting risk substantially.
- Rules and agency procedures change often; verify current requirements before finalizing a project schedule.
What Is NEPA and When Does It Affect Environmental Permitting?
Congress enacted NEPA in 1970 to build environmental consideration into federal planning. It's codified at 42 U.S.C. § 4321 and following sections, and it applies to what the statute calls a "major federal action" — one subject to substantial federal control and responsibility.
That connection, often called the federal nexus, shows up in several common forms:
- A federal permit or authorization (Army Corps dredge-and-fill permit, for instance)
- Federal funding for construction or infrastructure work
- A federal land lease, right-of-way, or land-use decision
- A federal loan guarantee tied to project financing
Projects with no meaningful federal funding, approval, or control generally fall outside NEPA's scope. The statute specifically excludes actions where the federal government can't control the outcome.
NEPA Isn't the Same as Substantive Environmental Law
Here's where confusion sets in. NEPA requires analysis and disclosure. It doesn't set pollution limits, protect specific habitats, or issue water permits. Those obligations come from separate statutes — the Clean Water Act, the Endangered Species Act, the Clean Air Act.
A project can complete NEPA review and still owe several other approvals. One NEPA document is rarely the only requirement standing between a project and construction.
Lead Agencies and Cooperating Agencies
One federal agency typically manages the NEPA process as the lead agency. Other agencies with jurisdiction or special expertise can serve as cooperating agencies, contributing consultations and technical analysis without taking over the review.
State, tribal, and local reviews often run alongside the federal process. Sometimes they're coordinated; sometimes they proceed entirely separately, depending on the laws involved and the project's location.
How the NEPA Review Process Works: CE, EA, and EIS
Every NEPA review starts with a screening question: does this action fit a category the agency has already determined doesn't normally cause significant effects? If yes, it may qualify for a categorical exclusion (CE). If not, the agency moves to deeper analysis.
| Review Level | Purpose | Outcome |
|---|---|---|
| Categorical Exclusion | Covers actions an agency has predetermined don't normally cause significant effects | Typically no EA or EIS required, unless extraordinary circumstances apply |
| Environmental Assessment (EA) | Evaluates whether effects could be significant | Finding of No Significant Impact (FONSI) or escalation to EIS |
| Environmental Impact Statement (EIS) | Full analysis for actions with likely significant effects | Record of Decision (ROD) after public review |
Categorical Exclusions Have Limits
A CE isn't automatic. Agencies define these categories in their own procedures, and extraordinary circumstances (unusual site conditions, sensitive species, cumulative effects) can pull a project out of a CE and into an EA.
The EA Pathway and FONSI
An Environmental Assessment examines the proposed action's likely impacts, considers alternatives briefly, and often incorporates mitigation to keep effects below the significance threshold. When the agency concludes effects won't be significant, it issues a FONSI and proceeds without an EIS.
When an EIS Is Required
An EIS applies to actions expected to significantly affect the environment. The process runs through several stages:

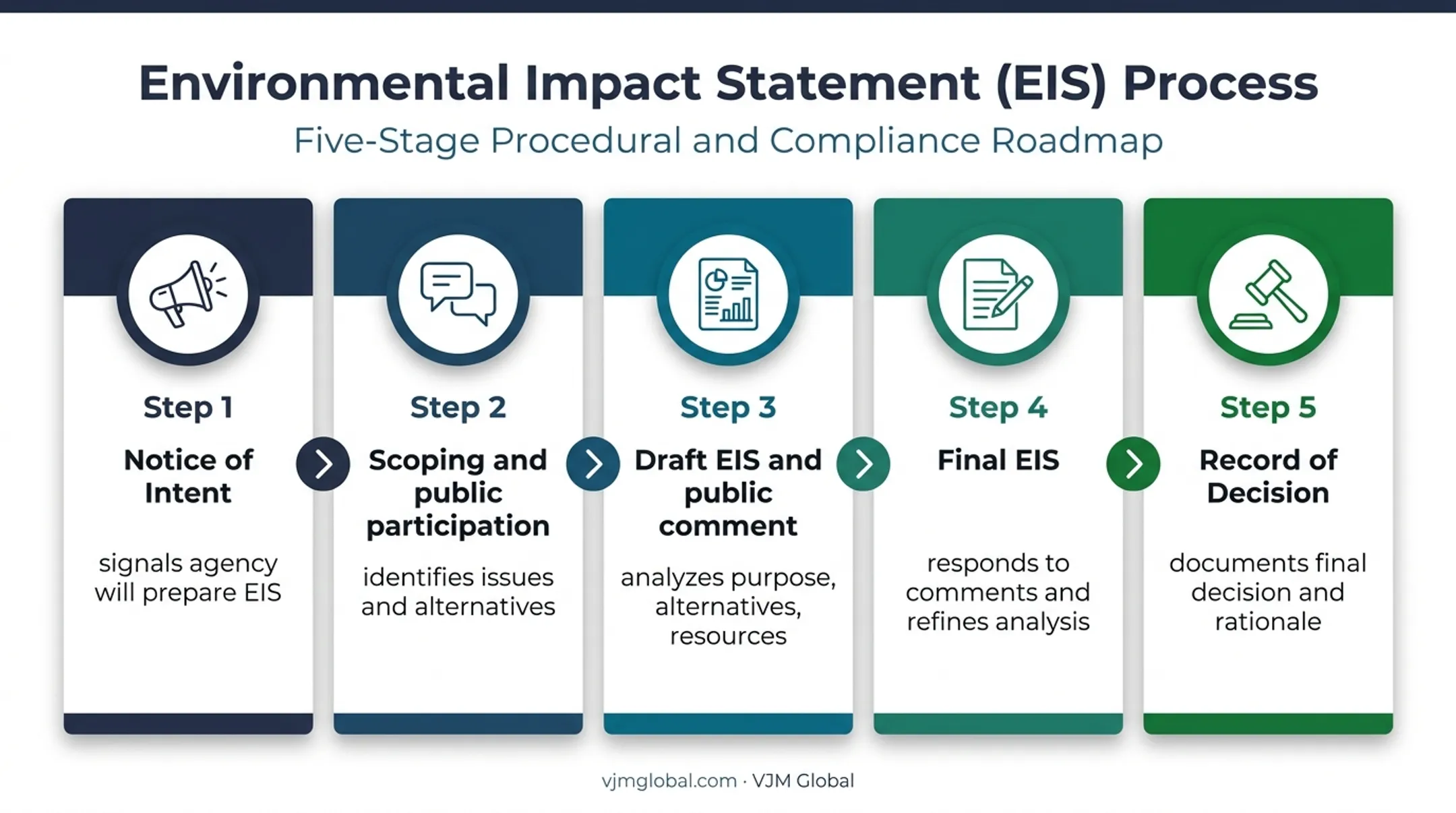

- Notice of Intent (NOI): signals the agency will prepare an EIS
- Scoping and public participation: identifies key issues and reasonable alternatives
- Draft EIS and public comment: analyzes purpose and need, alternatives, and affected resources
- Final EIS: responds to comments and refines the analysis
- Record of Decision (ROD): documents the agency's final decision and rationale

Across these stages, courts still require agencies to take a "hard look" at environmental consequences and alternatives. In Robertson v. Methow Valley Citizens Council, 490 U.S. 332 (1989), the Supreme Court held that an agency must adequately study the effects.
Once that analysis is done, the agency may choose an option other than the least environmentally damaging one, as long as the decision is lawful and well explained. NEPA demands informed decision-making, not a specific outcome.
How NEPA Coordinates With Other Environmental Permits and Approvals
Agencies often use what's informally called the NEPA umbrella: one coordinated review supporting several related federal decisions. A shared alternatives analysis, common baseline data, and a unified administrative record can serve multiple approvals at once.
This coordination shows up across several other permitting processes:
- Clean Water Act Section 404 — agencies such as the Federal Highway Administration often merge NEPA and Section 404 studies so alternatives and data serve both reviews. The Army Corps still issues its own permit decision.
- Endangered Species Act Section 7 consultation — agencies consult on qualifying actions; a biological opinion can stand independently of the NEPA document.
- National Historic Preservation Act Section 106 — regulations allow early coordination, and under specified conditions an EA/FONSI or EIS/ROD can satisfy Section 106. A categorical exclusion does not automatically clear that obligation.
Coordination does not erase separate statutory standards. Each agency administering its own law still has to meet that law's requirements, even when the underlying environmental analysis overlaps.
A Real Example: Empire Wind

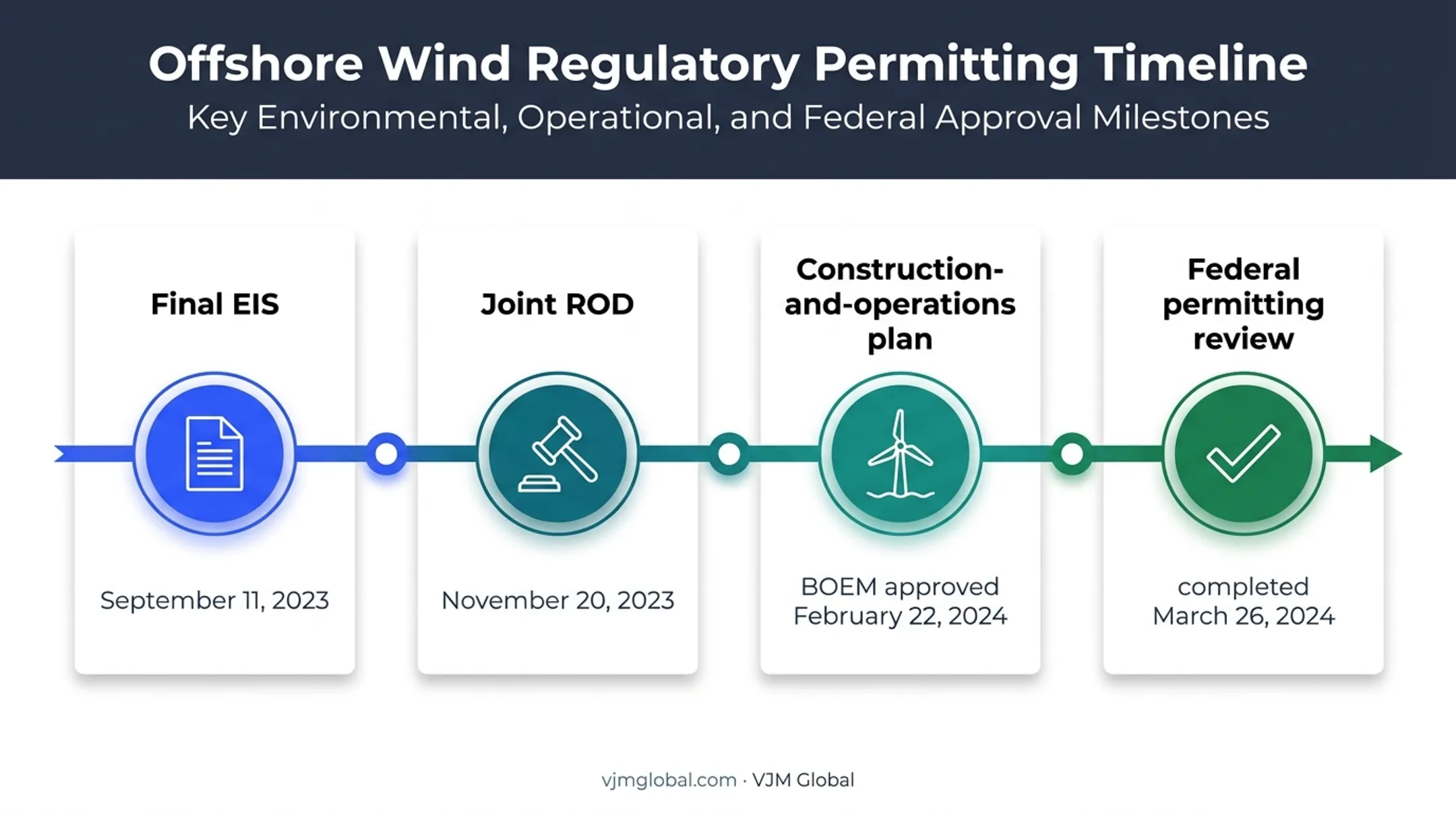

The Bureau of Ocean Energy Management's Empire Wind project shows how this works in practice. BOEM issued the final EIS on September 11, 2023, and a joint Record of Decision on November 20, 2023.
That ROD named BOEM as NEPA lead while separately documenting Endangered Species Act consultation, Section 106 consultation, and a National Marine Fisheries Service decision adopting the EIS for its own authorization. BOEM approved the project's construction-and-operations plan on February 22, 2024. The federal Permitting Council reported completion of the project's federal permitting review on its FAST-41 dashboard on March 26, 2024.

That sequence shows several federal decisions running on a coordinated schedule, not a single approval covering everything.
FAST-41: Scheduling, Not Substance
FAST-41 coordinates covered projects' reviews through public, project-specific timetables. It improves scheduling and accountability across agencies. It doesn't remove any agency's underlying legal obligations.
How NEPA Can Affect Permitting Timelines, Costs, and Litigation Risk
NEPA review sits on the critical path for most major federal actions. Agencies generally must finish their analysis before issuing a final permit, lease, funding decision, or Record of Decision (ROD). Delay here delays everything downstream.
Common Sources of Delay
- Incomplete or shifting project descriptions
- Late-discovered wetlands, species, or cultural resources
- Poorly defined alternatives
- Insufficient early consultation with cooperating agencies
- Agency staffing and capacity constraints
- Supplemental analysis triggered by design changes
Early screening and disciplined scoping catch these problems before they drive cost overruns. Delay stacks consultant fees, idle capital carrying costs, and redesign work when supplemental analysis is required.
A stable project description, submitted with solid baseline data, gives agencies less reason to request more studies later and keeps the NEPA budget closer to plan.
What the Data Actually Shows

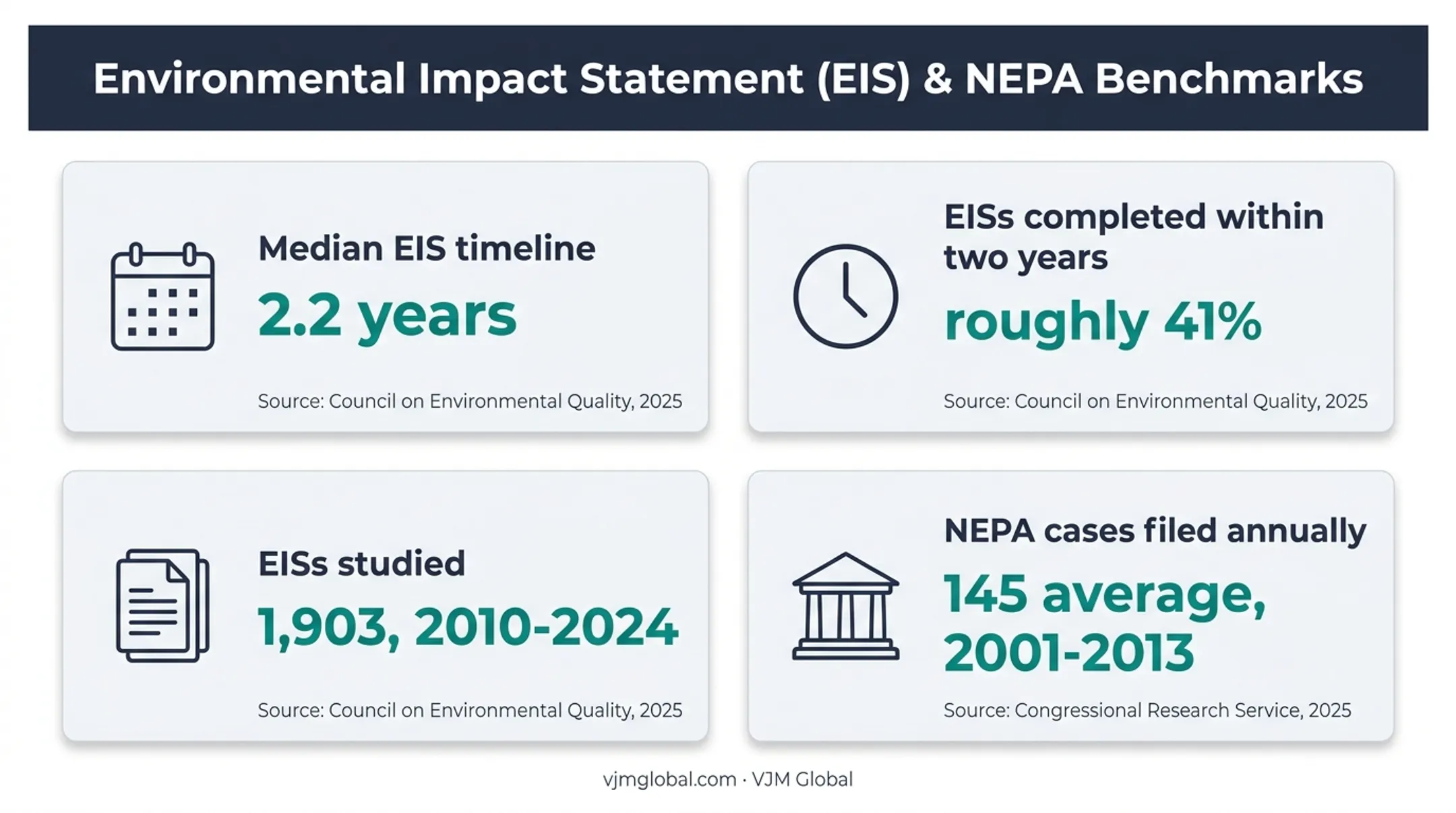

According to the Council on Environmental Quality's 2025 EIS timeline report, final EISs completed in 2024 took a median of 2.2 years from Notice of Intent to final EIS, with roughly 41% finishing within two years. That figure covers 1,903 final EISs studied across 2010–2024 and stops at final EIS — not ROD or permit issuance.
Litigation adds another layer of uncertainty. A 2025 Congressional Research Service report cites historical CEQ surveys showing an average of 145 NEPA cases filed per year between 2001 and 2013. That's a historical baseline, not a current risk rate for any specific project or agency.

Courts can remand a decision for more analysis, vacate it entirely, or issue an injunction when the administrative record falls short. A legally deficient EIS can undo years of work in a single ruling, which is why a well-documented record matters as much as the underlying science.
Recent NEPA Changes and What Project Teams Should Verify
NEPA implementation has shifted considerably in the past few years, and project teams need to check current status rather than relying on older summaries.

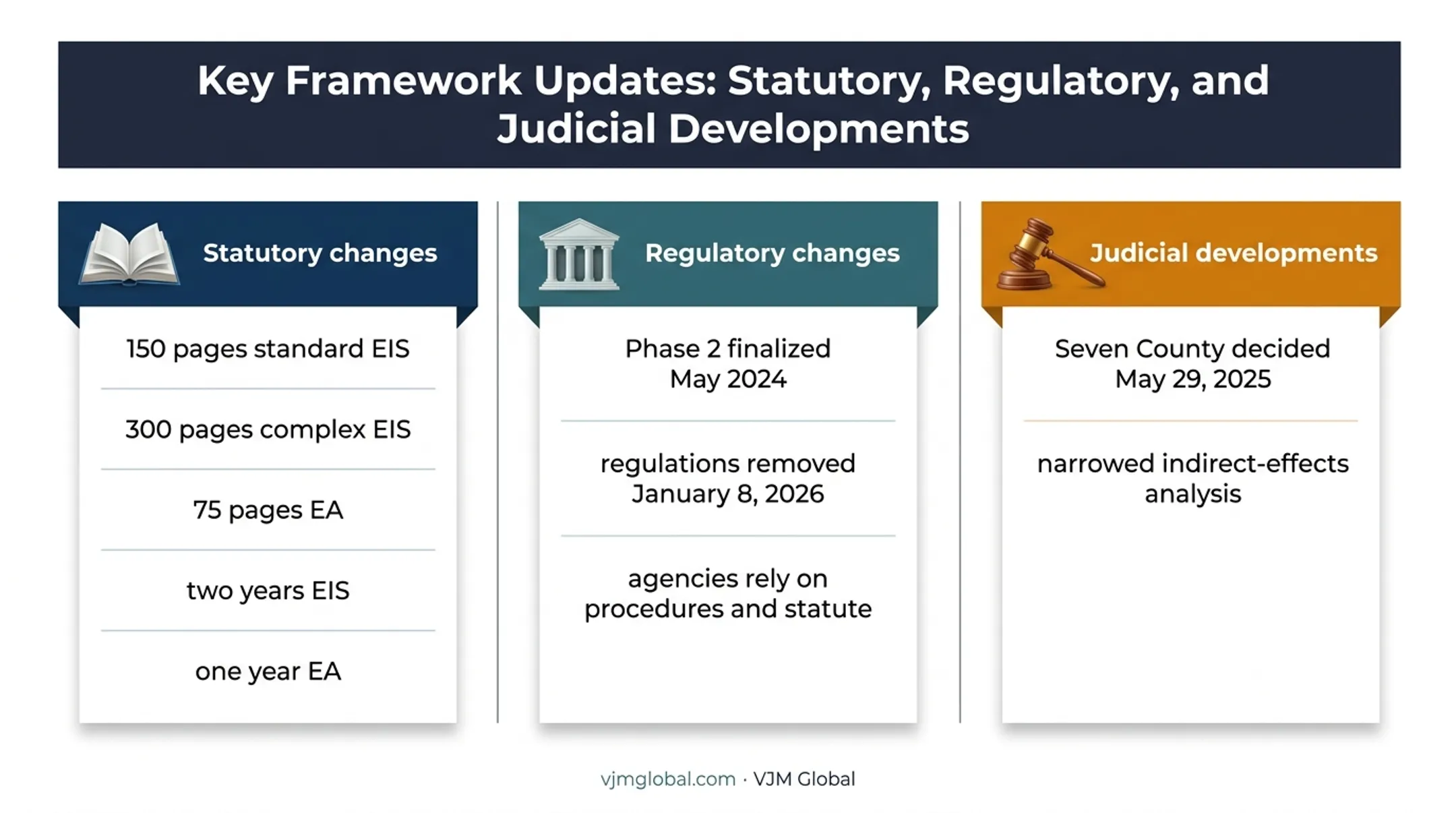

Statutory changes: The 2023 Fiscal Responsibility Act codified page limits—150 pages for a standard EIS, 300 for extraordinarily complex actions, and 75 for an EA. It also set general deadlines of two years for an EIS and one year for an EA from the applicable starting point, subject to extensions.
Regulatory changes: CEQ finalized a Phase 2 rule in May 2024, but subsequently moved to remove its government-wide regulations at 40 CFR parts 1500–1508, with final removal effective January 8, 2026. Agencies now rely more heavily on their own procedures and the statute itself.
Judicial developments: In Seven County Infrastructure Coalition v. Eagle County, decided May 29, 2025, the Supreme Court rejected requiring a railway EIS to analyze effects from separate upstream drilling and downstream refining projects simply because the railway might make them more likely.
This ruling narrows how far agencies must trace indirect effects. Effects from the project itself, including those occurring later or farther away, can still require analysis.

A few practical notes for project teams:
- Distinguish enacted law and binding agency procedure from proposed legislation or interim guidance.
- Compare the lead agency's specific procedures, since implementation differs across agencies.
- Don't assume a faster review track removes Clean Water Act, Endangered Species Act, historic preservation, or tribal consultation obligations.
NEPA Versus EPA: Understanding the Difference
These two get confused constantly, and the mix-up causes real scheduling mistakes.
| Factor | NEPA | EPA |
|---|---|---|
| Legal status | Federal statute (42 U.S.C. § 4321 et seq.) | Federal agency |
| Primary function | Requires environmental analysis before major federal decisions | Administers and enforces environmental programs (Clean Air Act, Clean Water Act, and others) |
| Role in reviews | Sets the process every lead agency follows | Reviews and comments on other agencies' draft EISs under Clean Air Act Section 309 |
| Relationship to permits | Doesn't issue permits itself | Issues certain permits directly under its own statutory authorities |
The federal agency responsible for the proposed action (the Federal Highway Administration for a highway project, BOEM for an offshore lease) usually serves as NEPA lead agency. EPA gets involved through Section 309 review, not by default.
EPA discontinued its formal draft-EIS rating system in October 2018. Section 309 review continues, but references to EPA assigning ratings to every draft EIS reflect an outdated practice.
A Practical NEPA Readiness Checklist for Project Teams
Getting ahead of NEPA review starts well before any application gets filed.
- Confirm the federal nexus. Identify the likely lead agency, list every anticipated federal decision, and map related state, tribal, and local approvals before locking in a project schedule.
- Lock down a stable project description. Cover location, footprint, construction and operating activities, technology, and proposed mitigation. Material design changes after review begins often trigger additional analysis.
- Start baseline studies early. Wetlands, wildlife, threatened and endangered species, cultural resources, water and air quality, and community impacts all need documentation before scoping ends.
- Build a responsibility matrix. Assign ownership for agency coordination, consultations, data delivery, public engagement, and permit applications.
- Maintain an evidence trail. Document assumptions, data sources, alternatives considered, mitigation commitments, and agency communications. This record matters most if a decision faces judicial challenge.
Multinational businesses running US infrastructure or energy projects often need to coordinate this environmental workstream with broader corporate compliance: entity structuring, tax positioning, and financial reporting tied to the project.
VJM Global supports foreign investors and multinational companies with that back-office coordination—business setup, tax compliance, and accounting—as projects move through US regulatory processes. NEPA-specific legal conclusions still require qualified US environmental counsel; VJM Global's services are not a substitute for that advice.
Frequently Asked Questions
What are the requirements for an environmental assessment under NEPA?
An EA determines whether a federal action may significantly affect the environment, weighing impacts and reasonable alternatives. It ends in a Finding of No Significant Impact (FONSI) or a decision to prepare an EIS. Always verify the lead agency's current procedures.
What are the recent changes to the National Environmental Policy Act?
The 2023 Fiscal Responsibility Act set statutory page limits and deadlines, and CEQ removed its government-wide regulations effective January 2026. The Supreme Court's 2025 Seven County decision also narrowed how far indirect-effects analysis must extend.
What are the key differences between NEPA and EPA?
NEPA is a procedural federal statute requiring environmental review before major federal decisions. EPA is a federal agency that administers separate environmental programs and reviews some NEPA documents under Clean Air Act Section 309.
Does every project require a full Environmental Impact Statement under NEPA?
No. Projects fall into one of three tracks: categorical exclusion, Environmental Assessment, or EIS. An EIS applies only when significant environmental effects are expected.
Does NEPA itself issue an environmental permit?
No. NEPA informs a federal agency's decision-making process. Separate permits under laws like the Clean Water Act or Endangered Species Act remain required regardless of NEPA's outcome.
How can a project team reduce NEPA-related permitting delays?
Confirm the federal nexus early, keep the project description stable, and gather complete baseline data. Coordinate consultations proactively and maintain a well-organized administrative record.
