The order pushes state agencies toward faster coordination, clearer timelines, and better applicant support. For manufacturing, energy, infrastructure, agricultural, and mining projects, permitting delays translate directly into higher financing costs and stalled investment decisions.
This article breaks down what EO 26-03 actually does, and how it differs from a separate, much narrower order signed in August 2026 that restricts nonferrous mining permitting in the Rainy River Headwaters Watershed near the Boundary Waters.
Key Takeaways
- EO 26-03 targets coordination, clear timelines, accountability, and permit tracking—not weaker environmental standards.
- Streamlined processing is not automatic approval; technical review and public participation still apply.
- Results depend on staffing, guidance, and legislative follow-through—not the order text alone.
- A separate August 2026 order restricts nonferrous mining near the Boundary Waters, apart from this reform.
- Confirm current rules with Minnesota agencies and qualified advisors before relying on projected timelines.
Why Minnesota Is Overhauling Its Permitting System

Minnesota's permitting problems weren't a secret before Walz signed anything. The Minnesota Chamber Foundation's 2024 report documented an average 586 days to issue priority Tier 2 air permits between 2018 and September 2023. Similar federal air permits in Illinois took roughly 110 days over the same window.
The Permitting Backlog Behind the Reform
The Foundation's dashboard snapshot from November 2023 found approximately 371 air applications awaiting assignment, some sitting untouched for years. A 2026 update from the same organization counted 382 applications awaiting assignment or in process as of February 2026, with 265 still unassigned.

These figures come from the Minnesota Chamber Foundation's permitting report, not from MPCA's own compliance metrics, so treat them as dated snapshots rather than a live queue count.
What EO 26-03 Actually Directs Agencies to Do
The order doesn't rewrite Minnesota's environmental statutes. Instead, it directs the Minnesota Pollution Control Agency (MPCA) and the Department of Employment and Economic Development to:
- Launch a two-stage air permitting process for qualifying projects (Minnesota Rule 7007.0750) by March 1, 2026
- Begin a broader air, water, and land timeline-reduction initiative by March 31, 2026
- Enhance the public permit application tracker by April 1, 2026
- Publish an annual list of consultants whose client applications were complete at least 80% of the time
- Deliver progress reports to the Governor in October and December 2026
The full text of Executive Order 26-03 lays out these deadlines directly.
This builds on 2025 legislation that already requires MPCA to flag application deficiencies within 30 business days. Applicants then have five business days to respond before a completeness determination.
How the Streamlined Process Could Work in Practice

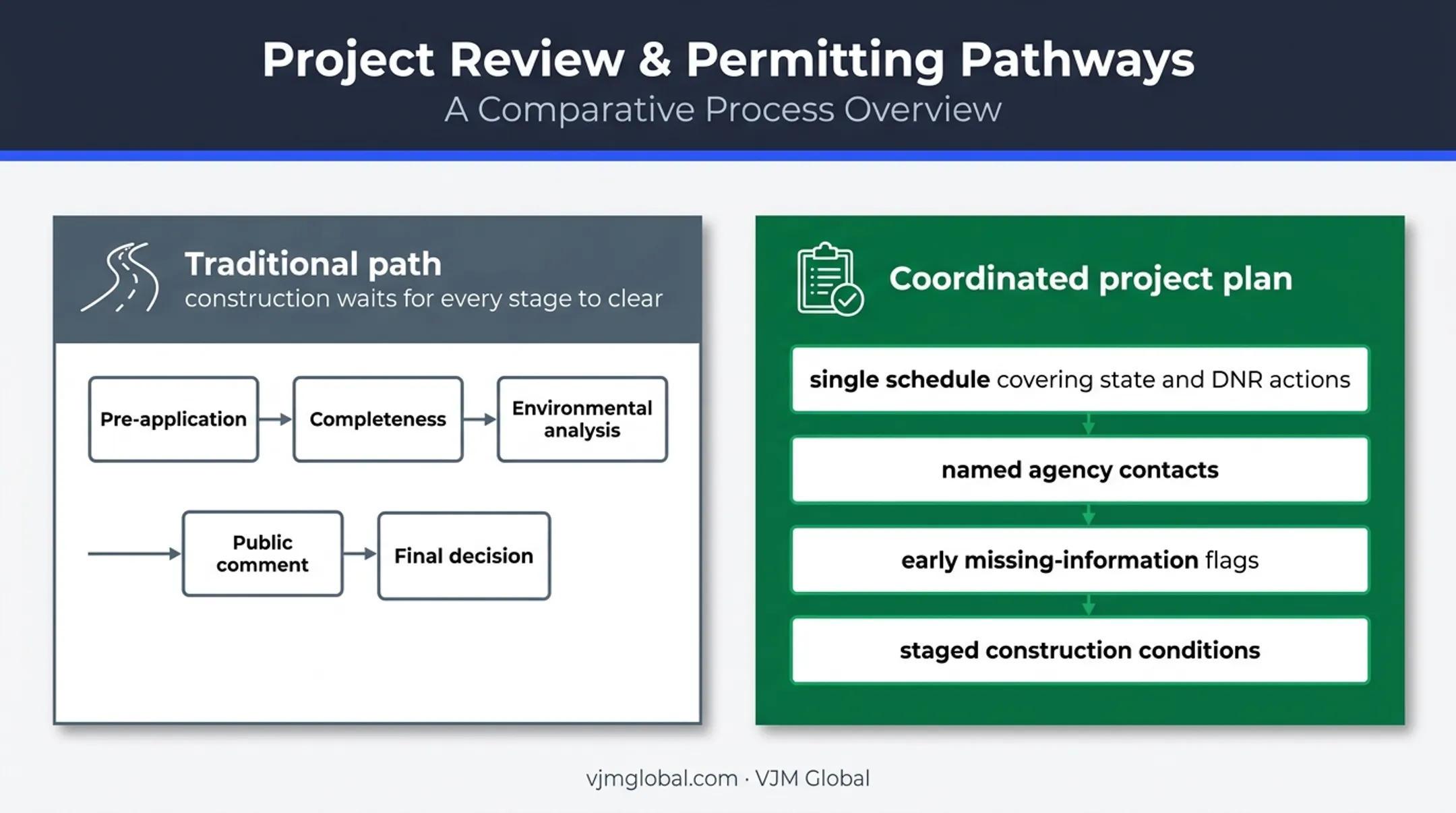

Picture a mid-sized manufacturer planning a new production facility in Minnesota. Under the traditional path, construction cannot begin until the project clears every stage:
- Pre-application consultation
- Completeness review
- Environmental analysis
- Public comment
- Final permit decision
A Hypothetical Manufacturing Project
Under a coordinated project plan (CPP), the same manufacturer might get:
- A single project schedule covering every required state and DNR action
- Named agency contacts responsible for each permit category
- Early flagging of missing technical information, before it becomes a bottleneck
- Staged construction-related conditions under Rule 7007.0750, issued after public participation requirements are met
That last point matters. Under the rule, construction may proceed only to the extent the issued conditions allow, while remaining conditions go through EPA's standard 45-day review. This is not a green light to start full operations early.

What Still Requires Full Approval
Site grading and foundation work might move forward under staged conditions in some cases. Full approval is still generally required for:
- Facility operation
- Emissions releases
- Wastewater discharges
- Regulated waste handling
Project owners should not assume one streamlined process replaces every required approval. Build a permit matrix instead, with realistic timing for each authorization the project needs:
- State and federal permits
- Local and land-use approvals
- Water, air, and construction authorizations
Environmental Protections and Oversight: What the Order Does Not Change
EO 26-03 is a process-reform measure. "Streamlined" still gets misread as "loosened" fairly often.
Safeguards That Remain in Place
Nothing in the order removes:
- Emissions limits or water-quality standards
- Required environmental review for qualifying projects
- Public comment periods and, where applicable, tribal consultation
- MPCA's and DNR's enforcement authority
- Monitoring and mitigation conditions attached to individual permits
Where Faster Processing Raises Questions
Faster administrative handling helps when it cuts dead time. An application sitting unassigned for months isn't protecting anyone.
Compressing technical review or public participation windows is a different matter, and it's one that environmental groups are watching closely.
MPCA's own November 2025 performance report shows why blanket claims about "efficiency" need context. Priority water permits met their statutory goal 99% of the time, while priority Tier 2 air permits met it only 15% of the time. The order's success will show up unevenly across permit types, not as one uniform improvement.
Who May Be Affected and What Businesses Should Do
Sectors most likely to feel this shift include advanced manufacturing, clean energy, mining, agriculture, transportation, utilities, and large infrastructure development. Eligibility ultimately comes down to the specific permit type and final agency rules, not blanket sector coverage.
A practical preparation checklist:
- Identify every required permit early—don't wait for completeness review to surface a gap
- Request a pre-application meeting and, for complex projects, a coordinated project plan
- Confirm named agency contacts and get commitments in writing where possible
- Build a master schedule that accounts for public comment periods and environmental review
- Document stakeholder and public engagement thoroughly; it's often the slowest variable
- Model staged-approval upside against the risk that review still extends the schedule
For businesses evaluating a Minnesota project from outside the U.S., including Australian and UK companies weighing cross-border investment, the permitting timeline is only part of the picture. Tax exposure, entity structure, and financial risk all need separate evaluation.
Cross-border investors also need tax, entity-structure, and statutory compliance review beside the permit track. VJM Global supports that work with tax due diligence, entity-structure planning, and financial compliance analysis that inform investment decisions—without replacing Minnesota-specific permitting counsel.
Any business considering a Minnesota project should still confirm permitting requirements directly with state agencies and qualified local environmental or legal specialists.
Legal Limits, Implementation Risks, and the Separate Mining Order
An executive order directs executive-branch agencies. It cannot override state statutes, court rulings, federal requirements, local approvals, or treaty obligations on its own authority.
Why an Executive Order Has Limits
Under Minnesota Statutes section 4.035, nonemergency executive orders take effect 15 days after publication and filing. They expire 90 days after the issuing governor leaves office unless another expiration applies. EO 26-03's staged air-permit directive works because it invokes an existing rule, not because it creates new legal authority from scratch.
Realistic implementation risks include:
- Insufficient agency staffing to meet the ordered deadlines
- Inconsistent application across departments during the transition
- Incomplete applicant submissions slowing early-stage review
- Possible litigation over specific implementation choices
The Boundary Waters Exception: EO 26-10

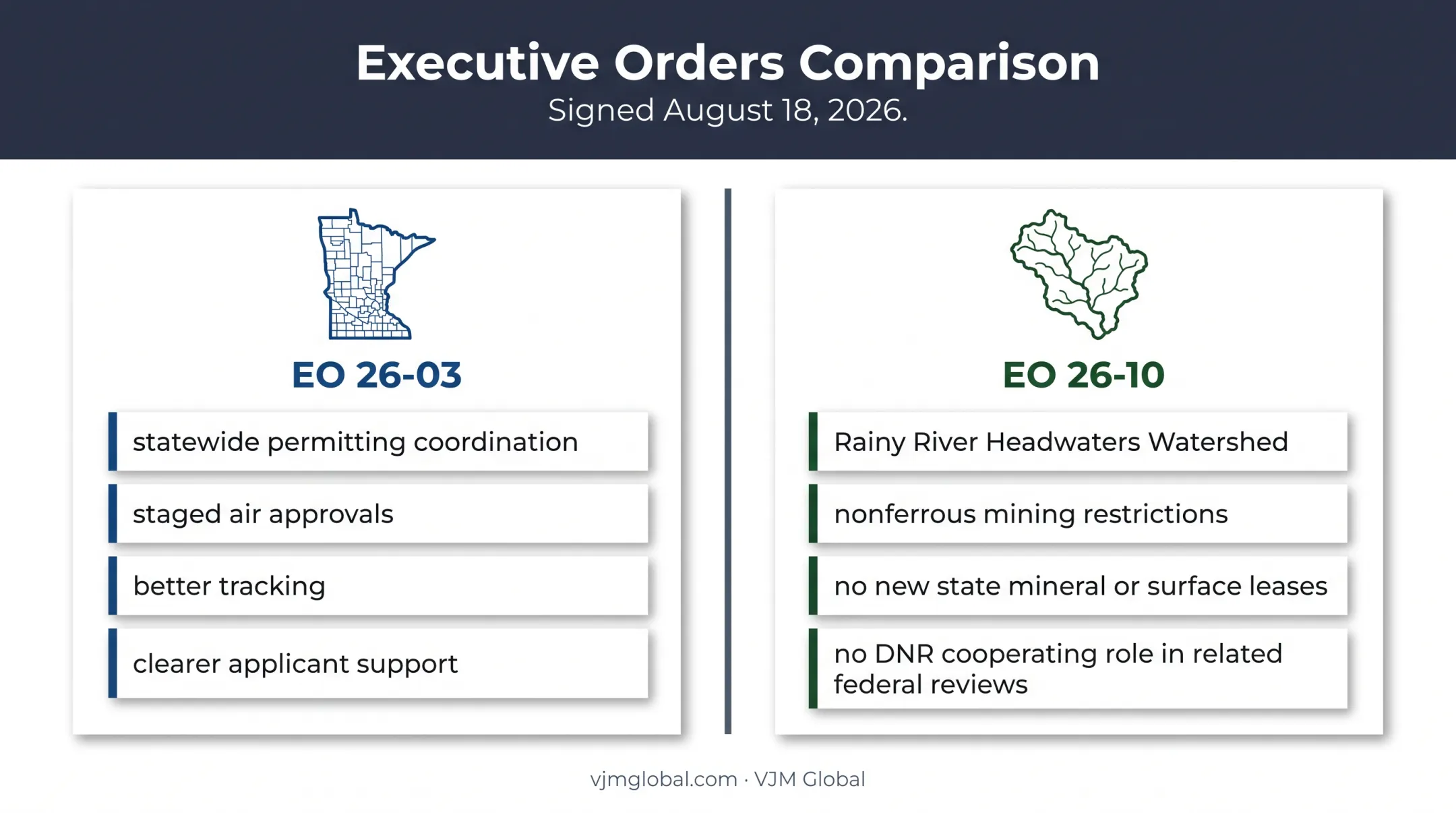

Six months after the general reform order, Walz signed a separate, narrower directive. EO 26-10, signed August 18, 2026, restricts DNR and MPCA from environmental review or permitting work on nonferrous mining proposals in the Rainy River Headwaters Watershed. Those restrictions stay in place pending resolution of ongoing litigation and related rulemaking.
The full text of EO 26-10 also blocks DNR from offering new state nonferrous mineral or surface leases in the watershed. It bars DNR from serving as a cooperating agency in related federal reviews. It does not automatically cancel existing leases, though it does direct their review and strict enforcement.

Don't conflate the two orders. EO 26-03 is about making permitting faster and more predictable statewide. EO 26-10 puts targeted brakes on one category of mining activity in one defined watershed.
Bottom Line
EO 26-03 could reduce uncertainty through better coordination, clearer applicant support, staged approvals, and improved tracking. It does not guarantee faster approval, and it does not remove environmental obligations.
The real test is processing performance over the next few reporting cycles—not the order's stated intentions. Watch:
- Actual permit turnaround and backlog trends in agency data
- MPCA's October and December 2026 progress reports as the first checkpoints
If you're planning a Minnesota project, review current agency guidance directly. Get project-specific advice before you submit an application or lock a construction timeline to projected efficiencies.
Frequently Asked Questions
What did Governor Walz's environmental permitting order do?
EO 26-03 directs Minnesota agencies to improve permitting efficiency, coordination, and transparency, including staged air permit approvals for qualifying projects. Confirm specific requirements through official MPCA guidance before relying on them.
Does the order weaken Minnesota's environmental protections?
No. It focuses on administrative speed, not removing emissions limits, water-quality standards, or public comment requirements. Permit-specific safeguards still need to be verified for each project category.
Can businesses begin construction before receiving a full operating permit?
In limited cases, qualifying projects may get staged construction-related conditions under an existing rule. Eligibility, exact conditions, and operational restrictions vary by project and must be confirmed with MPCA.
Which Minnesota agencies are affected by the order?
MPCA and the Department of Employment and Economic Development (through Business First Stop) carry most implementation duties. Exact responsibilities depend on the permit type and project involved.
How is the permitting order different from the Boundary Waters mining order?
EO 26-03 is a broad, statewide process-efficiency initiative. EO 26-10, signed six months later, imposes targeted restrictions on nonferrous mining permitting and leases in one specific watershed.
When will the changes take effect?
Several EO 26-03 deadlines fall between March and December 2026, but implementation details can shift. Check the official executive order text and current MPCA guidance before making decisions.
